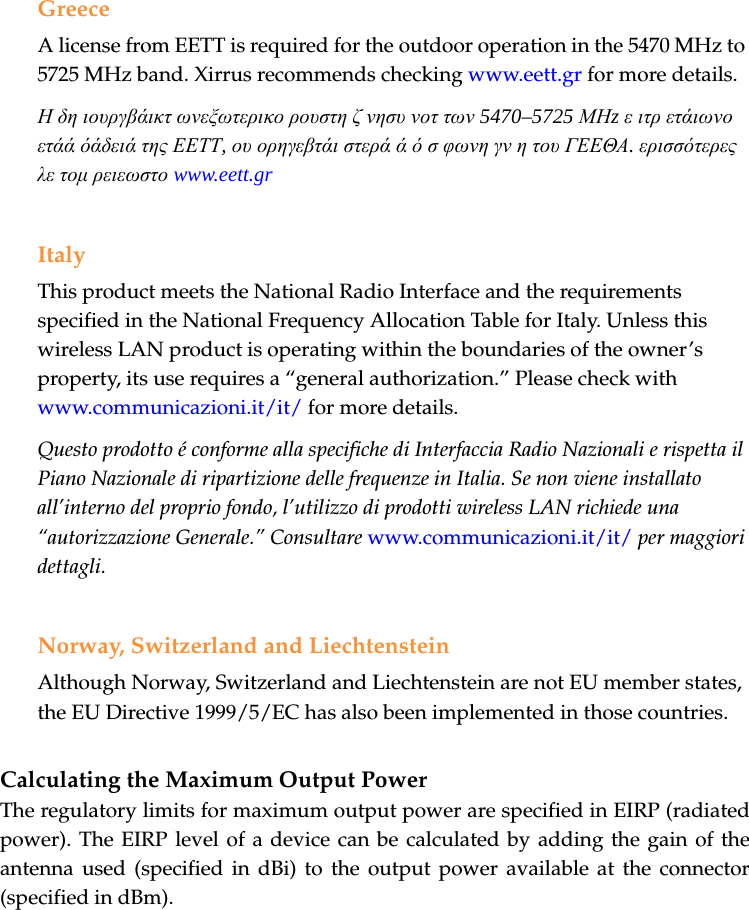

GreeceA license from EETT is required for the outdoor operation in the 5470 MHz to 5725 MHz band. Xirrus recommends checking www.eett.gr for more details.Η δη ιουργβάικτ ωνεξωτερικο ρουστη ζ νησυ νοτ των 5470–5725 ΜΗz ε ιτρ ετάιωνο ετάά όάδειά της ΕΕΤΤ, ου ορηγεβτάι στερά ά ό σ φωνη γν η του ΓΕΕΘΑ. ερισσότερες λε τομ ρειεωστο www.eett.grItalyThis product meets the National Radio Interface and the requirements specified in the National Frequency Allocation Table for Italy. Unless this wireless LAN product is operating within the boundaries of the owner’s property, its use requires a “general authorization.” Please check with www.communicazioni.it/it/ for more details.Questo prodotto é conforme alla specifiche di Interfaccia Radio Nazionali e rispetta il Piano Nazionale di ripartizione delle frequenze in Italia. Se non viene installato all’interno del proprio fondo, l’utilizzo di prodotti wireless LAN richiede una “autorizzazione Generale.” Consultare www.communicazioni.it/it/ per maggiori dettagli.Norway, Switzerland and LiechtensteinAlthough Norway, Switzerland and Liechtenstein are not EU member states, the EU Directive 1999/5/EC has also been implemented in those countries.Calculating the Maximum Output Power The regulatory limits for maximum output power are specified in EIRP (radiated power). The EIRP level of a device can be calculated by adding the gain of the antenna used (specified in dBi) to the output power available at the connector (specified in dBm).
AntennasThe Xirrus Wi-Fi Array employs integrated antennas that cannot be removed and which are not user accessible. Nevertheless, as regulatory limits are not the same throughout the EU, users may need to adjust the conducted power setting for the radio to meet the EIRP limits applicable in their country or region. Adjustments can be made from the product’s management interface—either Web Management Interface (WMI) or Command Line Interface (CLI).Operating FrequencyThe operating frequency in a wireless LAN is determined by the access point. As such, it is important that the access point is correctly configured to meet the local regulations. See National Restrictions in this section for more information.If you still have questions regarding the compliance of Xirrus products or you cannot find the information you are looking for, please contact us at:Xirrus, Inc.370 North Westlake Blvd, Suite 200Westlake Village, CA 91362USATel: 1.805.497.0955Fax: 1.805.449.1180www.xirrus.com
Safety WarningsTranslated safety warnings appear on the following page. !Safety WarningsRead all user documentation before powering this device. All Xirrus interconnected equipment should be contained indoors. This product is not suitable for outdoor operation. Please verify the integrity of the system ground prior to installing Xirrus equipment. Additionally, verify that the ambient operating temperature does not exceed 50°C.!Explosive Device Proximity WarningDo not operate the XN16/XN8/XN4 unit near unshielded blasting caps or in an explosive environment unless the device has been modified to be especially qualified for such use.!Lightning Activity WarningDo not work on the XN16/XN8/XN4 or connect or disconnect cables during periods of lightning activity.!Circuit Breaker WarningThe XN16/XN8/XN4 relies on the building’s installation for over current protection. Ensure that a fuse or circuit breaker no larger than 120 VAC, 15A (U.S.) or 240 VAC, 10A (International) is used on all current-carrying conductors.
Translated Safety WarningsAvertissements de Sécurité!SécuritéLisez l'ensemble de la documentation utilisateur avant de mettre cet appareil sous tension. Tous les équipements Xirrus interconnectés doivent être installés en intérieur. Ce produit n'est pas conçu pour être utilisé en extérieur. Veuillez vérifier l'intégrité de la terre du système avant d'installer des équipements Xirrus. Vérifiez également que la température de fonctionnement ambiante n'excède pas 50°C.!Proximité d'appareils explosifsN'utilisez pas l'unité XN16/XN8/XN4 à proximité d'amorces non blindées ou dans un environnement explosif, à moins que l'appareil n'ait été spécifiquement modifié pour un tel usage.!FoudreN'utilisez pas l'unité XN16/XN8/XN4 et ne branchez pas ou ne débranchez pas de câbles en cas de foudre.!DisjoncteurL'unité XN16/XN8/XN4 dépend de l'installation du bâtiment pour ce qui est de la protection contre les surintensités. Assurez-vous qu'un fusible ou qu'un disjoncteur de 120 Vca, 15 A (États-Unis) ou de 240 Vca, 10 A (International) maximum est utilisé sur tous les conducteurs de courant.
Software Warranty and License AgreementTHIS SOFTWARE LICENSE AGREEMENT (THE “AGREEMENT”) IS A LEGAL AGREEMENT BETWEEN YOU (“CUSTOMER”) AND LICENSOR (AS DEFINED BELOW) AND GOVERNS THE USE OF THE SOFTWARE INSTALLED ON THE PRODUCT (AS DEFINED BELOW). IF YOU ARE AN EMPLOYEE OR AGENT OF CUSTOMER, YOU HEREBY REPRESENT AND WARRANT TO LICENSOR THAT YOU HAVE THE POWER AND AUTHORITY TO ACCEPT AND TO BIND CUSTOMER TO THE TERMS AND CONDITIONS OF THIS AGREEMENT (INCLUDING ANY THIRD PARTY TERMS SET FORTH HEREIN). IF YOU DO NOT AGREE TO ALL OF THE TERMS OF THIS AGREEMENT RETURN THE PRODUCT AND ALL ACCOMPANYING MATERIALS (INCLUDING ALL DOCUMENTATION) TO THE RELEVANT VENDOR FOR A FULL REFUND OF THE PURCHASE PRICE THEREFOR. CUSTOMER UNDERSTANDS AND AGREES THAT USE OF THE SOFTWARE SHALL BE DEEMED AN AGREEMENT TO THE TERMS AND CONDITIONS GOVERNING SUCH SOFTWARE AND THAT CUSTOMER IS BOUND BY AND BECOMES A PARTY TO THIS AGREEMENT.1. Definitions1.1 “Documentation” means the user manuals and all other all documentation, instructions or other similar materials accompanying the Software covering the installation, application, and use thereof.1.2 “Licensor” means XIRRUS and its suppliers.1.3 “Product” means a multi-radio access point containing four or more distinct radios capable of simultaneous operation on four or more non-overlapping channels.1.4 “Software” means, collectively, each of the application and embedded software programs delivered to Customer in connection with this Agreement. For purposes of this Agreement, the term Software shall be deemed to include any and all Documentation and Updates provided with or for the Software. 1.5 “Updates” means any bug-fix, maintenance or version release to the Software that may be provided to Customer from Licensor pursuant to this Agreement or pursuant to any separate maintenance and support agreement entered into by and between Licensor and Customer.
2. Grant of Rights2.1 Software. Subject to the terms and conditions of this Agreement, Licensor hereby grants to Customer a perpetual, non-exclusive, non-sublicenseable, non-transferable right and license to use the Software solely as installed on the Product in accordance with the accompanying Documentation and for no other purpose.    2.2 Ownership. The license granted under Sections 2.1 above with respect to the Software does not constitute a transfer or sale of Licensor's or its suppliers' ownership interest in or to the Software, which is solely licensed to Customer. The Software is protected by both national and international intellectual property laws and treaties. Except for the express licenses granted to the Software, Licensor and its suppliers retain all rights, title and interest in and to the Software, including (i) any and all trade secrets, copyrights, patents and other proprietary rights therein or thereto or (ii) any Marks (as defined in Section 2.3 below) used in connection therewith. In no event shall Customer remove, efface or otherwise obscure any Marks contained on or in the Software. All rights not expressly granted herein are reserved by Licensor. 2.3 Copies. Customer shall not make any copies of the Software but shall be permitted to make a reasonable number of copies of the related Documentation. Whenever Customer copies or reproduces all or any part of the Documentation, Customer shall reproduce all and not efface any titles, trademark symbols, copyright symbols and legends, and other proprietary markings or similar indicia of origin (“Marks”) on or in the Documentation.
2.4 Restrictions. Customer shall not itself, or through any parent, subsidiary, affiliate, agent or other third party (i) sell, rent, lease, license or sublicense, assign or otherwise transfer the Software, or any of Customer's rights and obligations under this Agreement except as expressly permitted herein; (ii) decompile, disassemble, or reverse engineer the Software, in whole or in part, provided that in those jurisdictions in which a total prohibition on any reverse engineering is prohibited as a matter of law and such prohibition is not cured by the fact that this Agreement is subject to the laws of the State of California, Licensor agrees to grant Customer, upon Customer's written request to Licensor, a limited reverse engineering license to permit interoperability of the Software with other software or code used by Customer; (iii) allow access to the Software by any user other than by Customer's employees and contractors who are bound in writing to confidentiality and non-use restrictions at least as protective as those set forth herein; (iv) except as expressly set forth herein, write or develop any derivative software or any other software program based upon the Software; or (v) use any computer software or hardware which is designated to defeat any copy protection or other use limiting device, including any device intended to limit the number of users or devices accessing the Product. 3. Limited Warranty and Limitation of Liability3.1 Limited Warranty & Exclusions. Licensor warrants that the Software will perform in substantial accordance with the specifications therefor set forth in the Documentation for a period of ninety [90] days after Customer's acceptance of the terms of this Agreement with respect to the Software (“Warranty Period”). If during the Warranty Period the Software does not perform as warranted, Licensor shall, at its option, correct the relevant Software giving rise to such breach of performance or replace such Software free of charge. THE FOREGOING ARE CUSTOMER'S SOLE AND EXCLUSIVE REMEDIES FOR BREACH OF THE FOREGOING WARRANTY. THE WARRANTY SET FORTH ABOVE IS MADE TO AND FOR THE BENEFIT OF CUSTOMER ONLY. The warranty will apply only if (i) the Software has been used at all times and in accordance with the instructions for use set forth in the Documentation and this Agreement; (ii) no modification, alteration or addition has been made to the Software by persons other than Licensor or Licensor's authorized representative; and (iii) the Software or Product on which the Software is installed has not been subject to any unusual electrical charge.
3.2 DISCLAIMER. EXCEPT AS EXPRESSLY STATED IN THIS SECTION 3, ALL ADDITIONAL CONDITIONS, REPRESENTATIONS, AND WARRANTIES, WHETHER IMPLIED, STATUTORY OR OTHERWISE, INCLUDING, WITHOUT LIMITATION, ANY IMPLIED WARRANTIES OR CONDITIONS OF MERCHANTABILITY, FITNESS FOR A PARTICULAR PURPOSE, SATISFACTORY QUALITY, ACCURACY, AGAINST INFRINGEMENT OR ARISING FROM A COURSE OF DEALING, USAGE, OR TRADE PRACTICE, ARE HEREBY DISCLAIMED BY LICENSOR AND ITS SUPPLIERS. THIS DISCLAIMER SHALL APPLY EVEN IF ANY EXPRESS WARRANTY AND LIMITED REMEDY OFFERED BY LICENSOR FAILS OF ITS ESSENTIAL PURPOSE. ALL WARRANTIES PROVIDED BY LICENSOR ARE SUBJECT TO THE LIMITATIONS OF LIABILITY SET FORTH IN THIS AGREEMENT. 3.3 HAZARDOUS APPLICATIONS. THE SOFTWARE IS NOT DESIGNED OR INTENDED FOR USE IN HAZARDOUS ENVIRONMENTS REQUIRING FAIL SAFE PERFORMANCE, SUCH AS IN THE OPERATION OF A NUCLEAR FACILITY, AIRCRAFT NAVIGATION OR COMMUNICATIONS SYSTEMS, AIR TRAFFIC CONTROLS OR OTHER DEVICES OR SYSTEMS IN WHICH A MALFUNCTION OF THE SOFTWARE WOULD RESULT IN FORESEEABLE RISK OF INJURY OR DEATH TO THE OPERATOR OF THE DEVICE OR SYSTEM OR TO OTHERS (“HAZARDOUS APPLICATIONS”). CUSTOMER ASSUMES ANY AND ALL RISKS, INJURIES, LOSSES, CLAIMS AND ANY OTHER LIABILITIES ARISING OUT OF THE USE OF THE SOFTWARE IN ANY HAZARDOUS APPLICATIONS.3.4 Limitation of Liability. (a) TOTAL LIABILITY. NOTWITHSTANDING ANYTHING ELSE HEREIN, ALL LIABILITY OF LICENSOR AND ITS SUPPLIERS UNDER THIS AGREEMENT SHALL BE LIMITED TO THE AMOUNT PAID BY CUSTOMER FOR THE RELEVANT SOFTWARE, OR PORTION THEREOF, THAT GAVE RISE TO SUCH LIABILITY OR ONE HUNDRED UNITED STATES DOLLARS (US$100), WHICHEVER IS GREATER. THE LIABILITY OF LICENSOR AND ITS SUPPLIERS UNDER THIS SECTION SHALL BE CUMULATIVE AND NOT PER INCIDENT.
(b) DAMAGES. IN NO EVENT SHALL LICENSOR, ITS SUPPLIERS OR THEIR RELEVANT SUBCONTRACTORS BE LIABLE FOR (A) ANY INCIDENTAL, SPECIAL, PUNITIVE OR CONSEQUENTIAL DAMAGES, LOST PROFITS OR LOST OR DAMAGED DATA, OR ANY INDIRECT DAMAGES, WHETHER ARISING IN CONTRACT, TORT (INCLUDING NEGLIGENCE AND STRICT LIABILITY) OR OTHERWISE OR (B) ANY COSTS OR EXPENSES FOR THE PROCUREMENT OF SUBSTITUTE GOODS OR SERVICES IN EACH CASE, EVEN IF LICENSOR OR ITS SUPPLIERS HAVE BEEN INFORMED OF THE POSSIBILITY OF SUCH DAMAGES.3.5 Exclusions. SOME JURISDICTIONS DO NOT PERMIT THE LIMITATIONS OF LIABILITY AND LIMITED WARRANTIES SET FORTH UNDER THIS AGREEMENT. IN THE EVENT YOU ARE LOCATED IN ANY SUCH JURISDICTION, THE FOREGOING LIMITATIONS SHALL APPLY ONLY TO THE MAXIMUM EXTENT PERMITTED IN SUCH JURISDICTIONS. IN NO EVENT SHALL THE FOREGOING EXCLUSIONS AND LIMITATIONS ON DAMAGES BE DEEMED TO APPLY TO ANY LIABILITY BASED ON FRAUD, WILLFUL MISCONDUCT, GROSS NEGLIGENCE OR PERSONAL INJURY OR DEATH.4. Confidential Information4.1 Generally. The Software (and its accompanying Documentation) constitutes Licensor's and its suppliers' proprietary and confidential information and contains valuable trade secrets of Licensor and its suppliers (“Confidential Information”). Customer shall protect the secrecy of the Confidential Information to the same extent it protects its other valuable, proprietary and confidential information of a similar nature but in no event shall Customer use less than reasonable care to maintain the secrecy of the Confidential Information. Customer shall not use the Confidential Information except to exercise its rights or perform its obligations as set forth under this Agreement. Customer shall not disclose such Confidential Information to any third party other than subject to non-use and non-disclosure obligations at least as protective of a party's right in such Confidential Information as those set forth herein. 4.2 Return of Materials. Customer agrees to (i) destroy all Confidential Information (including deleting any and all copies contained on any of Customer's Designated Hardware or the Product) within fifteen (15) days of the date of termination of this Agreement or (ii) if requested by Licensor, return, any Confidential Information to Licensor within thirty (30) days of Licensor's written request.
5. Term and Termination5.1 Term. Subject to Section 5.2 below, this Agreement will take effect on the Effective Date and will remain in force until terminated in accordance with this Agreement.5.2 Termination Events. This Agreement may be terminated immediately upon written notice by either party under any of the following conditions: (a) If the other party has failed to cure a breach of any material term or condition under the Agreement within thirty (30) days after receipt of notice from the other party; or(b) Either party ceases to carry on business as a going concern, either party becomes the object of the institution of voluntary or involuntary proceedings in bankruptcy or liquidation, which proceeding is not dismissed within ninety (90) days, or a receiver is appointed with respect to a substantial part of its assets.5.3 Effect of Termination. (a) Upon termination of this Agreement, in whole or in part, Customer shall pay Licensor for all amounts owed up to the effective date of termination. Termination of this Agreement shall not constitute a waiver for any amounts due. (b) The following Sections shall survive the termination of this Agreement for any reason: Sections 1, 2.2, 2.4, 3, 4, 5.3, and 6. (c) No later than thirty (30) days after the date of termination of this Agreement by Licensor, Customer shall upon Licensor's instructions either return the Software and all copies thereof; all Documentation relating thereto in its possession that is in tangible form or destroy the same (including any copies thereof contained on Customer's Designated Hardware). Customer shall furnish Licensor with a certificate signed by an executive officer of Customer verifying that the same has been done.
6. MiscellaneousIf Customer is a corporation, partnership or similar entity, then the license to the Software and Documentation that is granted under this Agreement is expressly conditioned upon and Customer represents and warrants to Licensor that the person accepting the terms of this Agreement is authorized to bind such entity to the terms and conditions herein. If any provision of this Agreement is held to be invalid or unenforceable, it will be enforced to the extent permissible and the remainder of this Agreement will remain in full force and effect. During the course of use of the Software, Licensor may collect information on your use thereof; you hereby authorize Licensor to use such information to improve its products and services, and to disclose the same to third parties provided it does not contain any personally identifiable information. The express waiver by either party of any provision, condition or requirement of this Agreement does not constitute a waiver of any future obligation to comply with such provision, condition or requirement. Customer and Licensor are independent parties. Customer may not export or re-export the Software or Documentation (or other materials) without appropriate United States, European Union and foreign government licenses or in violation of the United State's Export Administration Act or foreign equivalents and Customer shall comply with all national and international laws governing the Software. This Agreement will be governed by and construed under the laws of the State of California and the United States as applied to agreements entered into and to be performed entirely within California, without regard to conflicts of laws provisions thereof and the parties expressly exclude the application of the United Nations Convention on Contracts for the International Sales of Goods and the Uniform Computer Information Transactions Act (as promulgated by any State) to this Agreement. Suits or enforcement actions must be brought within, and each party irrevocably commits to the exclusive jurisdiction of, the state and federal courts located in Ventura County, California. Customer may not assign this Agreement by operation of law or otherwise, without the prior written consent of Licensor and any attempted assignment in violation of the foregoing shall be null and void. This Agreement cancels and supersedes all prior agreements between the parties. This Agreement may not be varied except through a document agreed to and signed by both parties. Any printed terms and conditions contained in any Customer purchase order or in any Licensor acknowledgment, invoice or other documentation relating to the Software shall be deemed deleted and of no force or effect and any additional typed and/or written terms and conditions contained shall be for administrative purposes only, i.e. to identify the types and quantities of Software to be supplied, line item prices and total price, delivery schedule, and other similar ordering data, all in accordance with the provisions of this Agreement.
Hardware Warranty AgreementPLEASE READ THIS AGREEMENT CAREFULLY BEFORE USING THIS PRODUCTBY USING THIS PRODUCT, YOU ACKNOWLEDGE THAT YOU HAVE READ AND UNDERSTOOD ALL THE TERMS AND CONDITIONS OF THIS AGREEMENT AND THAT YOU ARE CONSENTING TO BE BOUND BY THIS AGREEMENT. IF YOU DO NOT AGREE TO ALL OF THE TERMS OF THIS AGREEMENT, RETURN THE UNUSED PRODUCT TO THE PLACE OF PURCHASE FOR A FULL REFUND.LIMITED WARRANTY. Xirrus warrants that for a period of one year from the date of purchase by the original purchaser (“Customer”): (i) the Xirrus Equipment (“Equipment”) will be free of defects in materials and workmanship under normal use; and (ii) the Equipment substantially conforms to its published specifications. Except for the foregoing, the Equipment is provided AS IS. This limited warranty extends only to Customer as the original purchaser. Customer's exclusive remedy and the entire liability of Xirrus and its suppliers under this limited warranty will be, at Xirrus' option, repair, replacement, or refund of the Equipment if reported (or, upon request, returned) to the party supplying the Equipment to Customer. In no event does Xirrus warrant that the Equipment is error free or that Customer will be able to operate the Equipment without problems or interruptions. This warranty does not apply if the Equipment (a) has been altered, except by Xirrus, (b) has not been installed, operated, repaired, or maintained in accordance with instructions supplied by Xirrus, (c) has been subjected to abnormal physical or electrical stress, misuse, negligence, or accident, or (d) is used in ultra-hazardous activities. DISCLAIMER. EXCEPT AS SPECIFIED IN THIS WARRANTY, ALL EXPRESS OR IMPLIED CONDITIONS, REPRESENTATIONS, AND WARRANTIES INCLUDING, WITHOUT LIMITATION, ANY IMPLIED WARRANTY OF MERCHANTABILITY, FITNESS FOR A PARTICULAR PURPOSE, NONINFRINGEMENT OR ARISING FROM A COURSE OF DEALING, USAGE, OR TRADE PRACTICE, ARE HEREBY EXCLUDED TO THE EXTENT ALLOWED BY APPLICABLE LAW. IN NO EVENT WILL XIRRUS OR ITS SUPPLIERS BE LIABLE FOR ANY LOST REVENUE, PROFIT, OR DATA, OR FOR SPECIAL, INDIRECT, CONSEQUENTIAL, INCIDENTAL, OR PUNITIVE DAMAGES HOWEVER CAUSED AND REGARDLESS OF THE THEORY OF LIABILITY ARISING OUT OF THE USE OF OR INABILITY TO USE THE EQUIPMENT EVEN IF XIRRUS OR ITS SUPPLIERS HAVE BEEN ADVISED OF THE POSSIBILITY OF SUCH DAMAGES. In no event shall Xirrus' or its suppliers' liability to Customer, whether in contract, tort (including negligence), or otherwise, exceed the price paid by Customer.
The foregoing limitations shall apply even if the above-stated warranty fails of its essential purpose. SOME STATES DO NOT ALLOW LIMITATION OR EXCLUSION OF LIABILITY FOR CONSEQUENTIAL OR INCIDENTAL DAMAGES. The above warranty DOES NOT apply to any evaluation Equipment made available for testing or demonstration purposes. All such Equipment is provided AS IS without any warranty whatsoever. Customer agrees the Equipment and related documentation shall not be used in life support systems, human implantation, nuclear facilities or systems or any other application where failure could lead to a loss of life or catastrophic property damage, or cause or permit any third party to do any of the foregoing. All information or feedback provided by Customer to Xirrus with respect to the Product shall be Xirrus' property and deemed confidential information of Xirrus.Equipment including technical data, is subject to U.S. export control laws, including the U.S. Export Administration Act and its associated regulations, and may be subject to export or import regulations in other countries. Customer agrees to comply strictly with all such regulations and acknowledges that it has the responsibility to obtain licenses to export, re-export, or import Equipment.This Agreement shall be governed by and construed in accordance with the laws of the State of California, United States of America, as if performed wholly within the state and without giving effect to the principles of conflict of law. If any portion hereof is found to be void or unenforceable, the remaining provisions of this Warranty shall remain in full force and effect. This Warranty constitutes the entire agreement between the parties with respect to the use of the Equipment. Manufacturer is Xirrus, Inc. 370 North Westlake Blvd #200 Westlake Village, CA 91362.
Wi-Fi ArrayTable of Contents iTable of ContentsAll topics listed in this Table of Contents are clickable, which means you can instantly jump to any selected topic with a click of your mouse button. Items that do not appear in the TOC list—they are part of the Front Matter, prior to this Table of Contents—include the following:zTrademarkszNoticeszEU Directive 1999/5/EC Compliance InformationzSafety WarningszTranslated Safety WarningszSoftware Warranty and License AgreementzHardware Warranty AgreementList of Figures...................................................................................... xiIntroduction .........................................................................................  1The Xirrus Family of Products ............................................................................... 1Nomenclature .................................................................................................... 3About this User’s Guide .......................................................................................... 3Organization ...................................................................................................... 3Notes and Cautions .......................................................................................... 5Screen Images .................................................................................................... 5Your User’s Guide as a PDF Document  ........................................................ 5Hyperlinks ......................................................................................................... 5Window or Page? .............................................................................................. 5Why Choose the Xirrus Wi-Fi Array? ................................................................... 6Wi-Fi Array Product Overview  ............................................................................. 7Enterprise Class Security ................................................................................. 7Wi-Fi Array Product Family  ........................................................................... 8Deployment Flexibility  .................................................................................... 9Power over Gigabit Ethernet (PoGE) (Optional) ................................ 10Enterprise Class Management  ...................................................................... 11
Wi-Fi Arrayii Table of ContentsKey Features and Benefits ..................................................................................... 13High Capacity and High Performance ........................................................ 13Extended Coverage ......................................................................................... 14Flexible Coverage Schemes .................................................................... 14Non-Overlapping Channels .......................................................................... 15Secure Wireless Access  .................................................................................. 15Applications Enablement  .............................................................................. 15SDMA Optimization  ...................................................................................... 15Fast Roaming ................................................................................................... 15Easy Deployment ............................................................................................ 15Product Specifications (XN16 and XN8) ............................................................. 16Product Specifications (XN4)  ............................................................................... 21Installing the Wi-Fi Array ................................................................. 27Installation Prerequisites  ...................................................................................... 27Optional Network Components ................................................................... 29Client Requirements ....................................................................................... 29Planning Your Installation .................................................................................... 30General Deployment Considerations  .......................................................... 30Coverage and Capacity Planning ................................................................. 32Placement .................................................................................................. 32RF Patterns ................................................................................................ 33Capacity and Cell Sizes ........................................................................... 34Fine Tuning Cell Sizes ............................................................................. 35Roaming Considerations  ........................................................................ 36Allocating Channels ................................................................................ 36Deployment Examples ............................................................................ 38Failover Planning ............................................................................................ 40Port Failover Protection .......................................................................... 40Switch Failover Protection  ..................................................................... 41Power Planning ............................................................................................... 42AC Power .................................................................................................. 42Power over Gigabit Ethernet  ................................................................. 42Security Planning ............................................................................................ 42Wireless Encryption  ................................................................................ 42Authentication ......................................................................................... 43Network Management Planning  .................................................................. 45
Wi-Fi ArrayTable of Contents iiiWDS Planning  ................................................................................................. 46Deployment Summary ................................................................................... 48Installation Workflow  ........................................................................................... 49Unpacking the Wi-Fi Array .................................................................................. 50Installing Your Wi-Fi Array .................................................................................. 52Choosing a Location ....................................................................................... 52Wiring Considerations ............................................................................ 53Mounting the Array on a Ceiling  ................................................................. 54Attaching the T-Bar Clips to the Template  .......................................... 55Secure the T-Bar Clips to the Ceiling Support Grid  ........................... 55Installing the Mounting Plate  ................................................................ 57Connecting the Cables  ............................................................................ 58Attaching the Array to the Mounting Plate (XN16/XN8/XN4)  ...... 59Securing the Array ................................................................................... 60Dismounting the Array ........................................................................... 61Mounting the Array on a Wall (XN16/XN8) .............................................. 62Kit Contents (Wall Mount Assembly - XN16 and XN8)  .................... 62Tools Required ......................................................................................... 62Mark the Wall Position  ........................................................................... 63Install the SNAPTOGGLE™ Toggle Bolts ........................................... 64Attach the Mounting Plate to the Wall Mounting Bracket ................ 65Attach the Wall Mounting Bracket/Plate Assembly to the Wall  ..... 65Mount the Array ...................................................................................... 66Mounting the Wi-Fi Array on a Wall (XN4) ............................................... 67Kit Contents (Wall Mount Assembly)  .................................................. 67Tools Required ......................................................................................... 67Mark the Wall Position  ........................................................................... 68Install the SNAPTOGGLE™ Toggle Bolts ........................................... 68Attach the Mounting Plate to the Wall Mounting Bracket ................ 70Attach the Wall Mounting Bracket/Plate Assembly to the Wall  ..... 71Mount the Array ...................................................................................... 72Removing the Array ................................................................................ 73Powering Up the Wi-Fi Array .............................................................................. 73Array LED Operating Sequences  ................................................................. 74LED Boot Sequence  ................................................................................. 74LED Operation when Array is Running  .............................................. 75Establishing Communication with the Array .................................................... 76
Wi-Fi Arrayiv Table of ContentsUsing the Serial Port ....................................................................................... 76Using the Ethernet Ports ................................................................................ 76Logging In ........................................................................................................ 76Performing the Express Setup Procedure ........................................................... 77Procedure for Performing an Express Setup  .............................................. 78The Web Management Interface ................................................... 83An Overview  .......................................................................................................... 84Structure of the WMI ............................................................................................. 84User Interface  ......................................................................................................... 86Status Bar  .................................................................................................. 87Logging In ............................................................................................................... 89Applying Configuration Changes ....................................................................... 89Character Restrictions  .................................................................................... 89Viewing Status on the Wi-Fi Array.................................................. 91Array Status Windows .......................................................................................... 91Array Summary  .............................................................................................. 92Content of the Array Summary Window ............................................ 93Array Information  .......................................................................................... 96Array Configuration ....................................................................................... 96Network Status Windows ..................................................................................... 98Network Map  .................................................................................................. 98Content of the Network Map Window  ................................................ 99Spanning Tree Status .................................................................................... 100Routing Table  ................................................................................................ 101DHCP Leases ................................................................................................. 102Connection Tracking/NAT ......................................................................... 102CDP Neighbors  ............................................................................................. 103RF Monitor Windows .......................................................................................... 104IAPs ................................................................................................................. 105Spectrum Analyzer  ...................................................................................... 106Intrusion Detection  ...................................................................................... 109Station Status Windows  ...................................................................................... 111Stations ........................................................................................................... 112Location Map ................................................................................................. 113RSSI ................................................................................................................. 118
Wi-Fi ArrayTable of Contents vSignal-to-Noise Ratio (SNR) ........................................................................ 120Noise Floor ..................................................................................................... 122Statistics Windows ............................................................................................... 124IAP Statistics Summary ................................................................................ 124Per-IAP Statistics ........................................................................................... 125Network Statistics ......................................................................................... 127VLAN Statistics ............................................................................................. 128WDS Statistics ................................................................................................ 129Filter Statistics  ............................................................................................... 130Station Statistics  ............................................................................................ 130Per-Station Statistics  ..................................................................................... 131System Log Window  ........................................................................................... 132Configuring the Wi-Fi Array ..........................................................  133Express Setup ........................................................................................................ 134Network ................................................................................................................. 140Network Interfaces   ...................................................................................... 141Network Interface Ports ........................................................................ 142DNS Settings .................................................................................................. 148CDP Settings .................................................................................................. 149Services .................................................................................................................. 151Time Settings (NTP)  ..................................................................................... 152System Log ..................................................................................................... 154SNMP .............................................................................................................. 157DHCP Server  ................................................................................................. 158VLANs ................................................................................................................... 161VLAN Management  ..................................................................................... 162Security .................................................................................................................. 164Understanding Security ........................................................................ 165Admin Management  .................................................................................... 168Management Control  ................................................................................... 169Access Control List ....................................................................................... 172Global Settings  .............................................................................................. 174External Radius ............................................................................................. 177Internal Radius .............................................................................................. 180Rogue Control List ........................................................................................ 182SSIDs ...................................................................................................................... 184
Wi-Fi Arrayvi Table of ContentsUnderstanding SSIDs ............................................................................ 185Understanding QoS Priority on the Wi-Fi Array .............................. 186SSID Management  ........................................................................................ 189SSID List (top of page)  .......................................................................... 189SSID Limits  ............................................................................................. 192Web Page Redirect Configuration Settings ........................................ 193Groups ................................................................................................................... 196Understanding Groups ......................................................................... 196Using Groups  ......................................................................................... 197Group Management  ..................................................................................... 198Group Limits  .......................................................................................... 200IAPs ........................................................................................................................ 202Understanding Fast Roaming .............................................................. 203IAP Settings  ................................................................................................... 204Global Settings (IAP)  ................................................................................... 209Beacon Configuration  ........................................................................... 210Station Management  ............................................................................. 211Advanced Traffic Optimization  .......................................................... 212Global Settings .11an  .................................................................................... 214Global Settings .11bgn .................................................................................. 217Advanced RF Settings .................................................................................. 221About Standby Mode ............................................................................ 221About Blocking Rogue APs .................................................................. 222RF Intrusion Detection .......................................................................... 222RF Resilience  .......................................................................................... 223RF Power & Sensitivity ......................................................................... 224RF Spectrum Management ................................................................... 225LED Settings  .................................................................................................. 227WDS ....................................................................................................................... 229About Configuring WDS Links ........................................................... 229WDS Client Links .......................................................................................... 231Filters ..................................................................................................................... 233Filter Lists  ...................................................................................................... 234Filter Management  ....................................................................................... 235Using Tools on the Wi-Fi Array.....................................................  239System Tools ......................................................................................................... 240
Wi-Fi ArrayTable of Contents viiCLI .......................................................................................................................... 246Logout .................................................................................................................... 248The Command Line Interface ......................................................  249Establishing a Secure Shell (SSH) Connection ................................................. 249Getting Started with the CLI  .............................................................................. 250Inputting Commands ................................................................................... 250Getting Help  .................................................................................................. 250Top Level Commands  ......................................................................................... 252Root Command Prompt ............................................................................... 252configure Commands ................................................................................... 253show Commands  .......................................................................................... 256statistics Commands ..................................................................................... 259Configuration Commands .................................................................................. 260acl .................................................................................................................... 260admin .............................................................................................................. 261cdp ................................................................................................................... 262clear ................................................................................................................. 263contact-info .................................................................................................... 264date-time ........................................................................................................ 265dhcp-server .................................................................................................... 266dns ................................................................................................................... 267file .................................................................................................................... 268filter ................................................................................................................. 269group .............................................................................................................. 271hostname ........................................................................................................ 271https ................................................................................................................ 272interface .......................................................................................................... 273load ................................................................................................................. 274location ........................................................................................................... 274management .................................................................................................. 275more ................................................................................................................ 275no ..................................................................................................................... 276quit .................................................................................................................. 278radius-server .................................................................................................. 278reboot .............................................................................................................. 279reset ................................................................................................................. 279
Wi-Fi Arrayviii Table of Contentsrun-tests .......................................................................................................... 280security ........................................................................................................... 282snmp ............................................................................................................... 283ssh .................................................................................................................... 284ssid .................................................................................................................. 285standby ........................................................................................................... 285syslog .............................................................................................................. 286telnet ............................................................................................................... 287uptime ............................................................................................................. 289vlan .................................................................................................................. 289Sample Configuration Tasks  .............................................................................. 291Configuring a Simple Open Global SSID .................................................. 292Configuring a Global SSID using WPA-PEAP ......................................... 293Configuring an SSID-Specific SSID using WPA-PEAP ........................... 294Enabling Global IAPs ................................................................................... 295Disabling Global IAPs .................................................................................. 296Enabling a Specific IAP ................................................................................ 297Disabling a Specific IAP ............................................................................... 298Setting Cell Size Auto-Configuration for All IAPs  .................................. 299Setting the Cell Size for All IAPs ................................................................ 300Setting the Cell Size for a Specific IAP ....................................................... 301Configuring VLANs on an Open SSID ...................................................... 302Configuring Self-Monitoring Mode (Loopback Tests) ............................ 303Appendices.....................................................................................  305Appendix A: Servicing the Wi-Fi Array  .............................................................307Removing the Access Panel ................................................................................ 309Reinstalling the Access Panel ............................................................................. 312Replacing the FLASH Memory Module ........................................................... 314Replacing the Main System Memory ................................................................ 316Replacing the Integrated Access Point Radio Module  ................................... 318Replacing the Power Supply Module  ............................................................... 321Appendix B: Quick Reference Guide ................................................................323Factory Default Settings ...................................................................................... 323Host Name ..................................................................................................... 323Network Interfaces  ....................................................................................... 323
Wi-Fi ArrayTable of Contents ixSerial ........................................................................................................ 323Gigabit 1 and Gigabit 2 ......................................................................... 323Fast Ethernet ........................................................................................... 324Integrated Access Points (IAPs) .................................................................. 325Server Settings ............................................................................................... 325NTP .......................................................................................................... 325Syslog ...................................................................................................... 326SNMP ...................................................................................................... 326DHCP .............................................................................................................. 326Default SSID  .................................................................................................. 327Security  .......................................................................................................... 327Global Settings - Encryption   ............................................................... 327External RADIUS (Global)   .................................................................. 328Internal RADIUS .................................................................................... 329Administrator Account and Password ...................................................... 329Management .................................................................................................. 329Keyboard Shortcuts  ............................................................................................. 330Appendix C: Technical Support .........................................................................333General Hints and Tips  ....................................................................................... 333Frequently Asked Questions .............................................................................. 334Multiple SSIDs ............................................................................................... 334Security ........................................................................................................... 336VLAN Support .............................................................................................. 339Array Monitor and Loopback Testing Capabilities ........................................ 341Enabling Monitoring on the Array  ..................................................... 341How Monitoring Works ............................................................................... 341Loopback Testing .......................................................................................... 342Loopback Mode Options  ...................................................................... 343Upgrading the Array via CLI ............................................................................. 344Sample Output for the Upgrade Procedure: ............................................. 345Contact Information  ............................................................................................ 349Glossary of Terms..........................................................................  351Index................................................................................................  363
Wi-Fi Arrayx Table of Contents

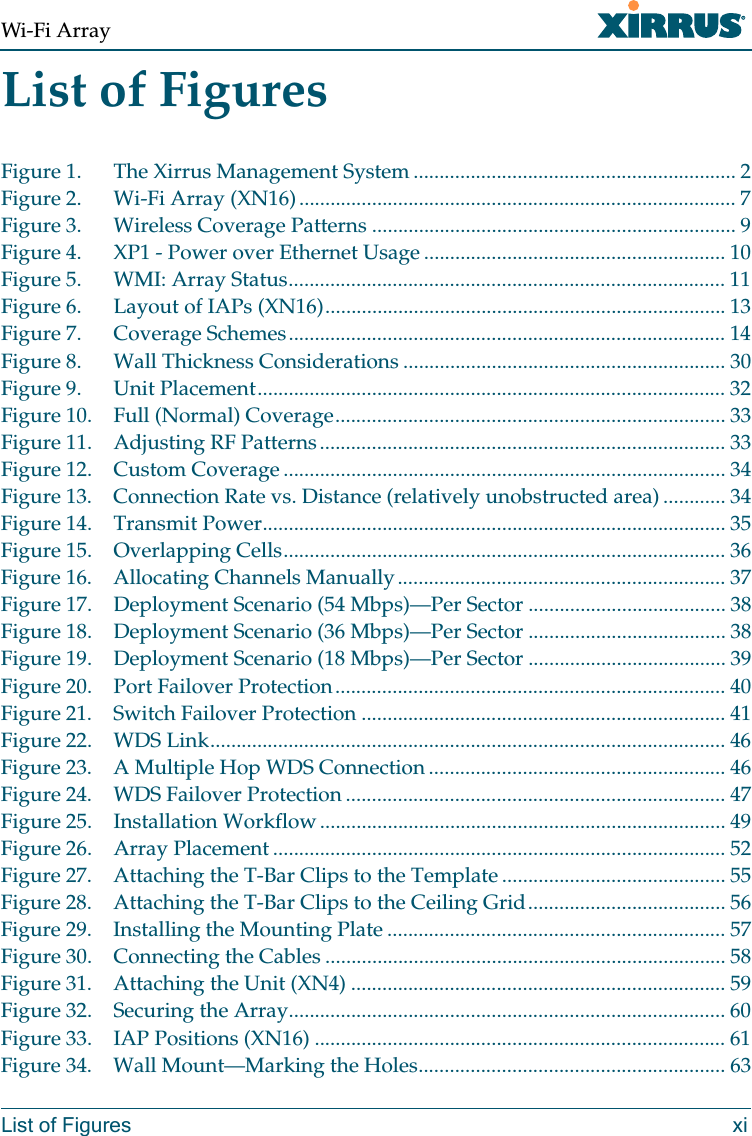

Wi-Fi ArrayList of Figures xiList of FiguresFigure 1. The Xirrus Management System .............................................................. 2Figure 2. Wi-Fi Array (XN16).................................................................................... 7Figure 3. Wireless Coverage Patterns ...................................................................... 9Figure 4. XP1 - Power over Ethernet Usage .......................................................... 10Figure 5. WMI: Array Status.................................................................................... 11Figure 6. Layout of IAPs (XN16)............................................................................. 13Figure 7. Coverage Schemes.................................................................................... 14Figure 8. Wall Thickness Considerations .............................................................. 30Figure 9. Unit Placement.......................................................................................... 32Figure 10. Full (Normal) Coverage........................................................................... 33Figure 11. Adjusting RF Patterns.............................................................................. 33Figure 12. Custom Coverage ..................................................................................... 34Figure 13. Connection Rate vs. Distance (relatively unobstructed area) ............ 34Figure 14. Transmit Power......................................................................................... 35Figure 15. Overlapping Cells..................................................................................... 36Figure 16. Allocating Channels Manually............................................................... 37Figure 17. Deployment Scenario (54 Mbps)—Per Sector ...................................... 38Figure 18. Deployment Scenario (36 Mbps)—Per Sector ...................................... 38Figure 19. Deployment Scenario (18 Mbps)—Per Sector ...................................... 39Figure 20. Port Failover Protection........................................................................... 40Figure 21. Switch Failover Protection ...................................................................... 41Figure 22. WDS Link................................................................................................... 46Figure 23. A Multiple Hop WDS Connection ......................................................... 46Figure 24. WDS Failover Protection ......................................................................... 47Figure 25. Installation Workflow.............................................................................. 49Figure 26. Array Placement ....................................................................................... 52Figure 27. Attaching the T-Bar Clips to the Template ........................................... 55Figure 28. Attaching the T-Bar Clips to the Ceiling Grid...................................... 56Figure 29. Installing the Mounting Plate ................................................................. 57Figure 30. Connecting the Cables ............................................................................. 58Figure 31. Attaching the Unit (XN4) ........................................................................ 59Figure 32. Securing the Array.................................................................................... 60Figure 33. IAP Positions (XN16) ............................................................................... 61Figure 34. Wall Mount—Marking the Holes........................................................... 63
Wi-Fi Arrayxii List of FiguresFigure 35. Installing the Toggle Bolts....................................................................... 64Figure 36. Attaching the Wall Mounting Plate ....................................................... 65Figure 37. Mounting the Array on a Wall ............................................................... 66Figure 38. Wall Mount—Marking the Holes........................................................... 68Figure 39. Installing the Toggle Bolts....................................................................... 69Figure 40. Attaching the Array Mounting Plate..................................................... 70Figure 41. Attaching the Wall Mounting Bracket to the Wall .............................. 71Figure 42. Mounting the Array on a Wall ............................................................... 72Figure 43. LED Locations (XN16) ............................................................................. 73Figure 44. Network Interface Ports........................................................................... 76Figure 45. Express Setup ............................................................................................ 77Figure 46. LEDs are Switched On............................................................................. 82Figure 47. Web Management Interface.................................................................... 84Figure 48. WMI: Frames............................................................................................. 86Figure 49. WMI: Status Bar........................................................................................ 87Figure 50. Feedback Form.......................................................................................... 88Figure 51. Logging In to the Wi-Fi Array ................................................................ 89Figure 52. Array Summary ........................................................................................ 92Figure 53. Disabled IAP (Partial View).................................................................... 94Figure 54. IAP Cells .................................................................................................... 95Figure 55. Array Information .................................................................................... 96Figure 56. Show Configuration................................................................................. 97Figure 57. Network Map............................................................................................ 98Figure 58. Spanning Tree Status.............................................................................. 100Figure 59. Routing Table.......................................................................................... 101Figure 60. DHCP Leases........................................................................................... 102Figure 61. Connection Tracking.............................................................................. 102Figure 62. CDP Neighbors....................................................................................... 103Figure 63. RF Monitor—IAPs.................................................................................. 105Figure 64. RF Spectrum Analyzer........................................................................... 107Figure 65. Intrusion Detection/Rogue AP List..................................................... 109Figure 66. Categorizing APs.................................................................................... 110Figure 67. Stations..................................................................................................... 112Figure 68. Location Map........................................................................................... 113Figure 69. Controls for Location Map.................................................................... 114Figure 70. Minimizing stations................................................................................ 115Figure 71. Setting Array location on a Custom Image......................................... 117
Wi-Fi ArrayList of Figures xiiiFigure 72. Station RSSI Values ................................................................................ 118Figure 73. Station RSSI Values—Colorized Graphical View .............................. 119Figure 74. Station Signal-to-Noise Ratio Values................................................... 120Figure 75. Station SNR Values—Colorized Graphical View .............................. 121Figure 76. Station Noise Floor Values.................................................................... 122Figure 77. Station Noise Floor Values—Colorized Graphical View.................. 123Figure 78. IAP Statistics Summary Page................................................................ 125Figure 79. Individual IAP Statistics Page (for IAP abg1) .................................... 126Figure 80. Network Statistics................................................................................... 127Figure 81. VLAN Statistics....................................................................................... 128Figure 82. WDS Statistics ......................................................................................... 129Figure 83. Filter Statistics ......................................................................................... 130Figure 84. Station Statistics ...................................................................................... 130Figure 85. Individual Station Statistics Page......................................................... 131Figure 86. System Log (modified for clarity)  ....................................................... 132Figure 87. WMI: Express Setup............................................................................... 134Figure 88. LEDs are Switched On........................................................................... 139Figure 89. Network Interfaces................................................................................. 140Figure 90. Network Settings .................................................................................... 141Figure 91. Network Interface Ports......................................................................... 142Figure 92. Port Modes (a-b) ..................................................................................... 144Figure 93. Port Modes (c-d) ..................................................................................... 145Figure 94. Port Modes (e-f) ...................................................................................... 146Figure 95. DNS Settings............................................................................................ 148Figure 96. CDP Settings............................................................................................ 149Figure 97. Services..................................................................................................... 151Figure 98. Time Settings (Manual Time)................................................................ 152Figure 99. Time Settings (NTP Time Enabled)...................................................... 153Figure 100. System Log .............................................................................................. 154Figure 101. SNMP ....................................................................................................... 157Figure 102. DHCP Management............................................................................... 158Figure 103. VLANs...................................................................................................... 161Figure 104. VLAN Management............................................................................... 162Figure 105. Security..................................................................................................... 164Figure 106. Admin Management .............................................................................. 168Figure 107. Management Control ............................................................................. 169Figure 108. Access Control List................................................................................. 172
Wi-Fi Arrayxiv List of FiguresFigure 109. Global Settings (Security) ...................................................................... 174Figure 110. External RADIUS Server ....................................................................... 177Figure 111. Internal RADIUS Server ........................................................................ 180Figure 112. Rogue Control List ................................................................................. 182Figure 113. SSIDs......................................................................................................... 184Figure 114. Four Traffic Classes................................................................................ 186Figure 115. SSID Management.................................................................................. 189Figure 116. WPR Internal Splash Page Fields (SSID Management)..................... 194Figure 117. Groups...................................................................................................... 196Figure 118. Group Management ............................................................................... 198Figure 119. IAPs........................................................................................................... 202Figure 120. IAP Settings ............................................................................................. 204Figure 121. Global Settings (IAPs)............................................................................ 209Figure 122. Global Settings .11an.............................................................................. 214Figure 123. Global Settings .11bgn ........................................................................... 217Figure 124. Advanced RF Settings............................................................................ 221Figure 125. LED Settings............................................................................................ 227Figure 126. WDS.......................................................................................................... 229Figure 127. .Configuring a WDS Link...................................................................... 230Figure 128. WDS Client Links ................................................................................... 231Figure 129. Filters........................................................................................................ 233Figure 130. Filter Lists ................................................................................................ 234Figure 131. Filter Management ................................................................................. 235Figure 132. System Tools............................................................................................ 240Figure 133. Saving the Diagnostic Log..................................................................... 243Figure 134. Managing WPR Splash/Login page files............................................ 244Figure 135. System Command (Ping)....................................................................... 245Figure 136. CLI Window............................................................................................ 246Figure 137. Login Window ........................................................................................ 248Figure 138. Logging In................................................................................................ 249Figure 139. Help Window.......................................................................................... 250Figure 140. Full Help .................................................................................................. 251Figure 141. Partial Help.............................................................................................. 251Figure 142. Configuring a Simple Open Global SSID............................................ 292Figure 143. Configuring a Global SSID using WPA-PEAP................................... 293Figure 144. Configuring an SSID-Specific SSID using WPA-PEAP..................... 294Figure 145. Enabling Global IAPs............................................................................. 295
Wi-Fi ArrayList of Figures xvFigure 146. Disabling Global IAPs............................................................................ 296Figure 147. Enabling a Specific IAP.......................................................................... 297Figure 148. Disabling a Specific IAP......................................................................... 298Figure 149. Setting the Cell Size for All IAPs.......................................................... 299Figure 150. Setting the Cell Size for All IAPs.......................................................... 300Figure 151. Setting the Cell Size for a Specific IAP ................................................ 301Figure 152. Configuring VLANs on an Open SSID................................................ 302Figure 153. Configuring a Loopback Test ............................................................... 304Figure 154. Disconnecting Power from the Array.................................................. 307Figure 155. Removing the Access Panel Screws..................................................... 309Figure 156. Removing the Access Panel .................................................................. 310Figure 157. Disconnecting the Power Supply and Fan.......................................... 310Figure 158. Reconnecting the Fan and Power Supply ........................................... 312Figure 159. Reinstalling the Access Panel................................................................ 312Figure 160. Removing the FLASH Memory Module............................................. 314Figure 161. Removing the DIMM Memory Module .............................................. 316Figure 162. Removing the Chassis Cover Screws................................................... 318Figure 163. Removing the Chassis Cover................................................................ 318Figure 164. Lifting the Integrated Access Point Module....................................... 319Figure 165. Disconnect the Integrated Access Point Module ............................... 319Figure 166. Installing a New Access Panel (with Power Supply)........................ 321
Wi-Fi Arrayxvi List of Figures
Wi-Fi ArrayIntroduction 1IntroductionThese topics introduce the Xirrus Wi-Fi Array, including an overview of its key features and benefits, and a detailed listing of the product’s physical, environmental, technology and regulatory specifications. z“The Xirrus Family of Products” on page 1.z“About this User’s Guide” on page 3.z“Why Choose the Xirrus Wi-Fi Array?” on page 6.z“Wi-Fi Array Product Overview” on page 7.z“Key Features and Benefits” on page 13.z“Product Specifications (XN16 and XN8)” on page 16.z“Product Specifications (XN4)” on page 21.The Xirrus Family of ProductsThe Xirrus family of products includes the following items:zXirrus Wi-Fi Array (XN16 / XN8 / XN4)The newest Xirrus Wi-Fi Arrays feature additional capabilities to support the Enterprise market. The XN16 has 16 IAPs (Integrated Access Points—radios), the XN8 has 8 IAPs, and the XN4 has 4 IAPs.zXirrus Management System (XMS)XMS is used for managing large Wi-Fi Array deployments from a centralized Web-based interface. The XMS server is available pre-installed on the Xirrus XM-3300-CC Management Platform, or as a software package (XA-3300-CC) to be installed on your own server hardware. Figure 1 illustrates the elements of the Xirrus Management System. Users start the XMS client simply by entering the URL of the XMS server on a web browser. The XMS server manages a number of Wi-Fi Arrays via SNMP.

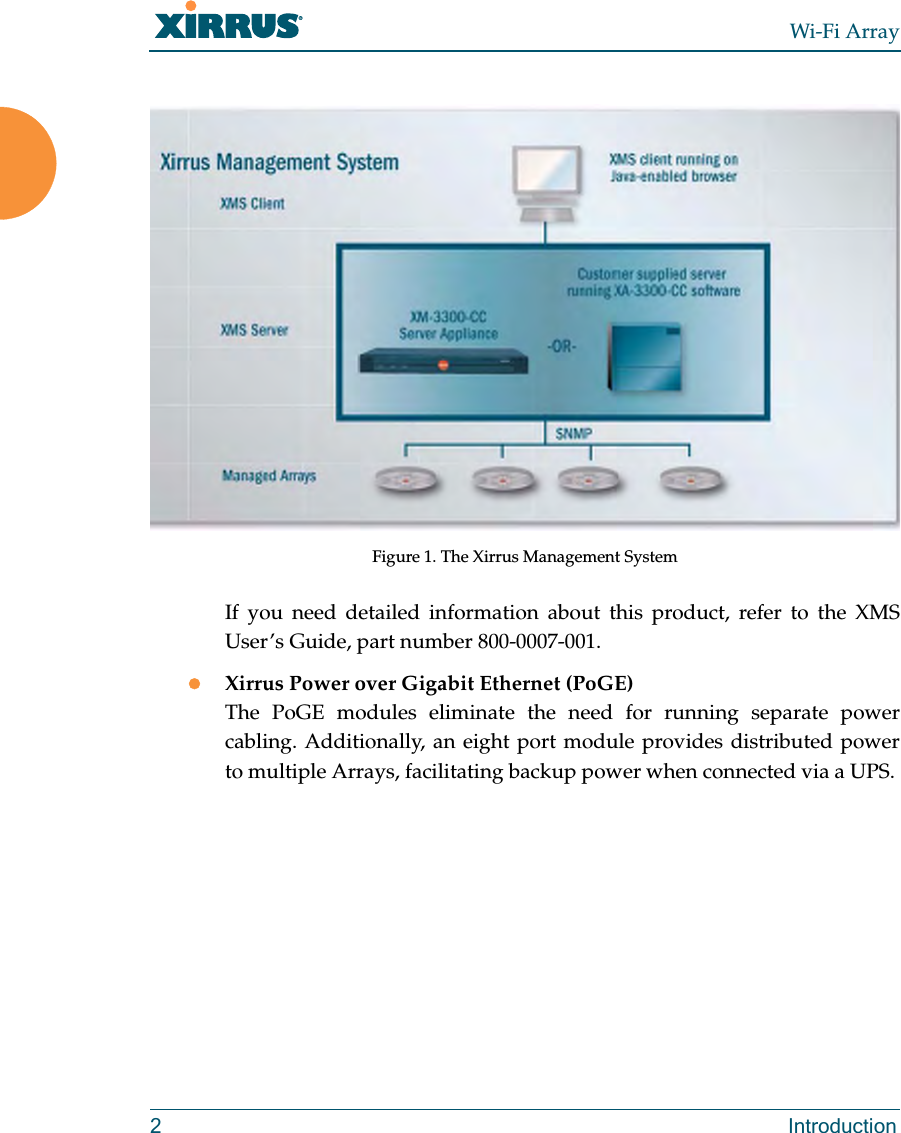

Wi-Fi Array2 IntroductionFigure 1. The Xirrus Management SystemIf you need detailed information about this product, refer to the XMS User’s Guide, part number 800-0007-001.zXirrus Power over Gigabit Ethernet (PoGE)The PoGE modules eliminate the need for running separate power cabling. Additionally, an eight port module provides distributed power to multiple Arrays, facilitating backup power when connected via a UPS.
Wi-Fi ArrayIntroduction 3NomenclatureThroughout this User’s Guide, the Xirrus Wi-Fi Array is also referred to as simply the Array. In some instances, the terms product and unit are also used. When discussing specific products from the Xirrus family, the product name is used (for example, XN16, XN8, XN4). The Wi-Fi Array’s operating system is referred to as the ArrayOS. The Web Management Interface for browser-based management of the Array is referred to as WMI. The Xirrus Management System is referred to as XMS. The Power over Gigabit Ethernet system may be referred to as PoGE.About this User’s GuideThis User’s Guide provides detailed information and procedures that will enable wireless network administrators to install, configure and manage the Wi-Fi Array so that end users can take full advantage of the product’s features and functionality without technical assistance.OrganizationTopics and procedures are organized by function under the following chapter headings: zIntroductionProvides a brief introduction to wireless technology, an overview of the product, including its key features and benefits, and presents the product specifications.zInstalling the Wi-Fi ArrayDefines the prerequisites for deploying and installing the Array and provides instructions to help you plan and complete a successful installation.zThe Web Management InterfaceOffers an overview of the product’s embedded Web Management Interface, including its content and structure. It emphasizes what you need to do to ensure that any configuration changes you make are
Wi-Fi Array4 Introductionapplied, and provides a list of restricted characters. It also includes instructions for logging in to the Array with your Web browser.zViewing Status on the Wi-Fi ArrayDescribes the status and statistics displays available on the Array using its embedded Web Management Interface. zConfiguring the Wi-Fi ArrayContains procedures for configuring the Array using its embedded Web Management Interface. zUsing Tools on the Wi-Fi ArrayContains procedures for using utility tools provided in the Web Management Interface. It includes procedures for upgrading the system firmware, uploading and downloading configurations and other files, using diagnostic tools, and resetting the Array to its factory defaults.zThe Command Line InterfaceIncludes the commands and the command structure used by the Wi-Fi Array’s Command Line Interface (CLI), and provides a procedure for establishing a Telnet connection to the Array. This chapter also includes some sample key configuration tasks using the CLI.zAppendix A: Servicing the Wi-Fi ArrayContains procedures for servicing the Array, including the removal and reinstallation of major hardware components.zAppendix B: Quick Reference GuideContains the product’s factory default settings.zAppendix C: Technical SupportOffers guidance to resolve technical issues, including general hints and tips to enhance your product experience, and a procedure for isolating problems within an Array-enabled wireless network. Also includes Frequently Asked Questions (FAQs) and Xirrus contact information.zGlossary of TermsProvides an explanation of terms directly related to Xirrus product technology, organized alphabetically.
Wi-Fi ArrayIntroduction 5zIndexThe index is a valuable information search tool. Use the index to locate specific topics discussed in this User’s Guide. Simply click on any page number in the index to jump to the referenced topic.Notes and CautionsThe following symbols are used throughout this User’s Guide:Screen ImagesSome screen images of the Web Management Interface have been modified for clarity. For example, an image may have been cropped to highlight a specific area of the screen, and/or sample data may be included in some fields.Your User’s Guide as a PDF DocumentThis User’s Guide is also made available as a secure PDF (Portable Document Format) file and can be viewed using the Adobe® Acrobat Reader® product. It cannot be edited or modified. If you don’t have Acrobat Reader, you can downloaded it free-of-charge from: http://www.adobe.com.HyperlinksIf you click on body text that appears in the color TEAL (with the exception of headings or notes) the embedded hyperlink within the text will immediately take you to the referenced destination. All internal and external cross-references, including page numbers within the List of Figures and the Index, have associated hyperlinks. After “jumping” to a referenced topic, if you want to return to the previous page (reference source), simply click on Acrobat’s previous page button.Window or Page?Is a window a page, or is a page a window? There seems to be some dispute as to what the correct term should be. For the sake of consistency, this document uses #This symbol is used for general notes that provide useful supplemental information.!This symbol is used for cautions. Cautions provide critical information that may adversely affect the performance of the product.
Wi-Fi Array6 Introductionthe term Window when referring to how the Wi-Fi Array’s Web Management Interface is displayed on your monitor.Why Choose the Xirrus Wi-Fi Array?The deployment of wireless LANs is becoming increasingly common as businesses strive for greater flexibility in the workplace and the need for employee mobility rises. The only requirements for an effective wireless deployment are a power source, a couple of screws, and a little imagination.Wireless LAN is also fully compatible with standard Ethernet protocols, so connectivity with existing wired infrastructures is transparent to users—they can still access and use the same applications and network services that they use when plugged into the company’s wired LAN infrastructure (it’s only the plug that no longer exists).Wireless LAN has come a long way in the past few years and now offers the performance, reliability and security that Enterprise customers have come to expect from their networks. The technology is being driven by three major IEEE standards:z802.11aOperates in the 5 GHz range with a maximum speed of 54 Mbps. z802.11bOperates in the 2.4 GHz range with a maximum speed of 11 Mbps. z802.11gSupports a transmission speed of 54 Mbps in the 2.4 GHz range and is backwards compatible with 802.11b.z802.11nSupports a higher transmission speed of up to 300 Mbps in the 5 GHz range and is backwards compatible with 802.11a/b/g.Whether you’re a small company with just a handful of employees, or a large corporation with thousands, wireless has the scalability and flexibility to serve your needs.

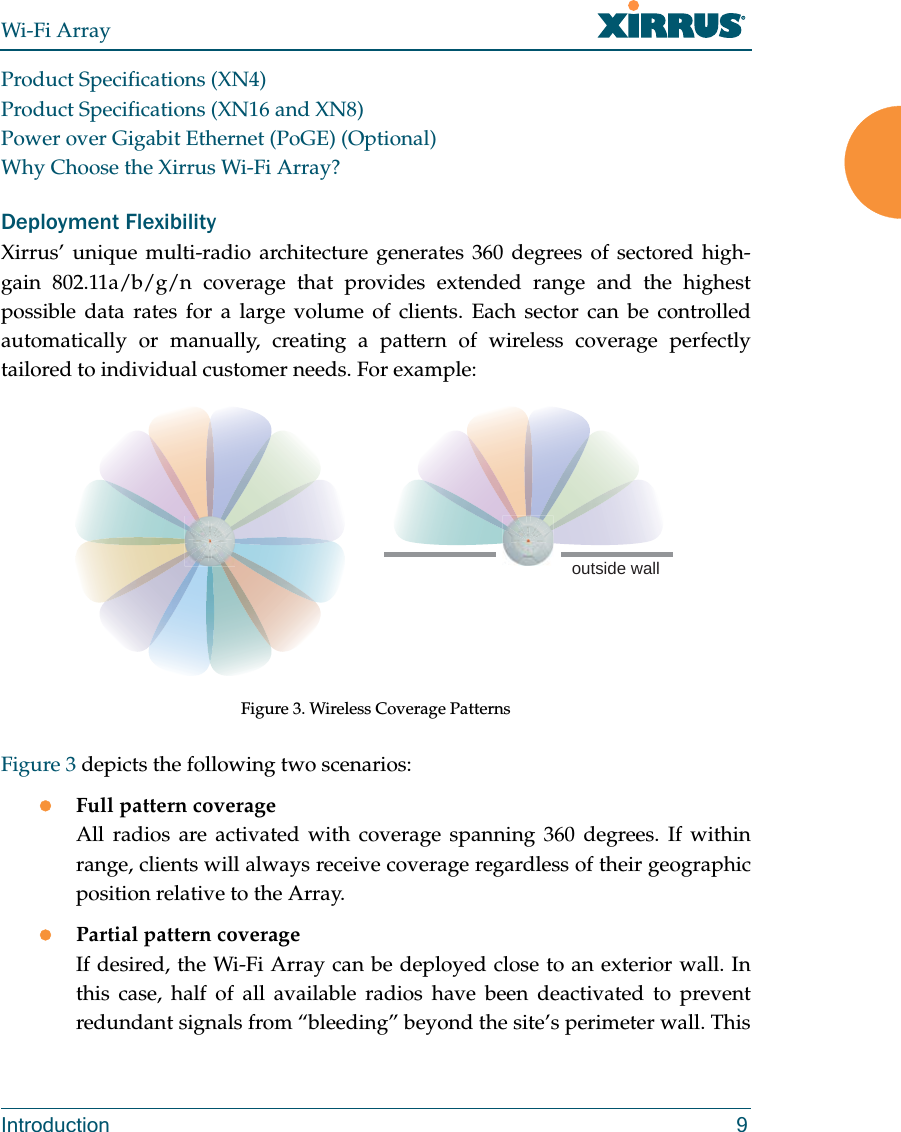

Wi-Fi ArrayIntroduction 7See AlsoKey Features and BenefitsWi-Fi Array Product OverviewProduct Specifications (XN4)Product Specifications (XN16 and XN8)The Xirrus Family of ProductsWi-Fi Array Product OverviewPart of the family of Xirrus products, the Wi-Fi Array is a high capacity, multi-mode device designed for the Enterprise market, with twice the range and up to sixteen times the capacity of competitive wireless products.Figure 2. Wi-Fi Array (XN16)The Wi-Fi Array (regardless of the product model) is Wi-Fi® compliant and simultaneously supports 802.11a, 802.11b, 802.11g, and 802.11n clients. Enterprise class features such as VLAN support and multiple SSID capability enable robust network compatibility and a high level of scalability and system control. The optional Xirrus Management System (XMS) allows global management of hundreds of Arrays from a central location.Multiple versions of the Array with different numbers of Integrated Access Points (IAPs) support a variety of deployment applications: 16 IAPs (XN16), 8 IAPs (XN8), and 4 IAPs (XN4).Enterprise Class Security

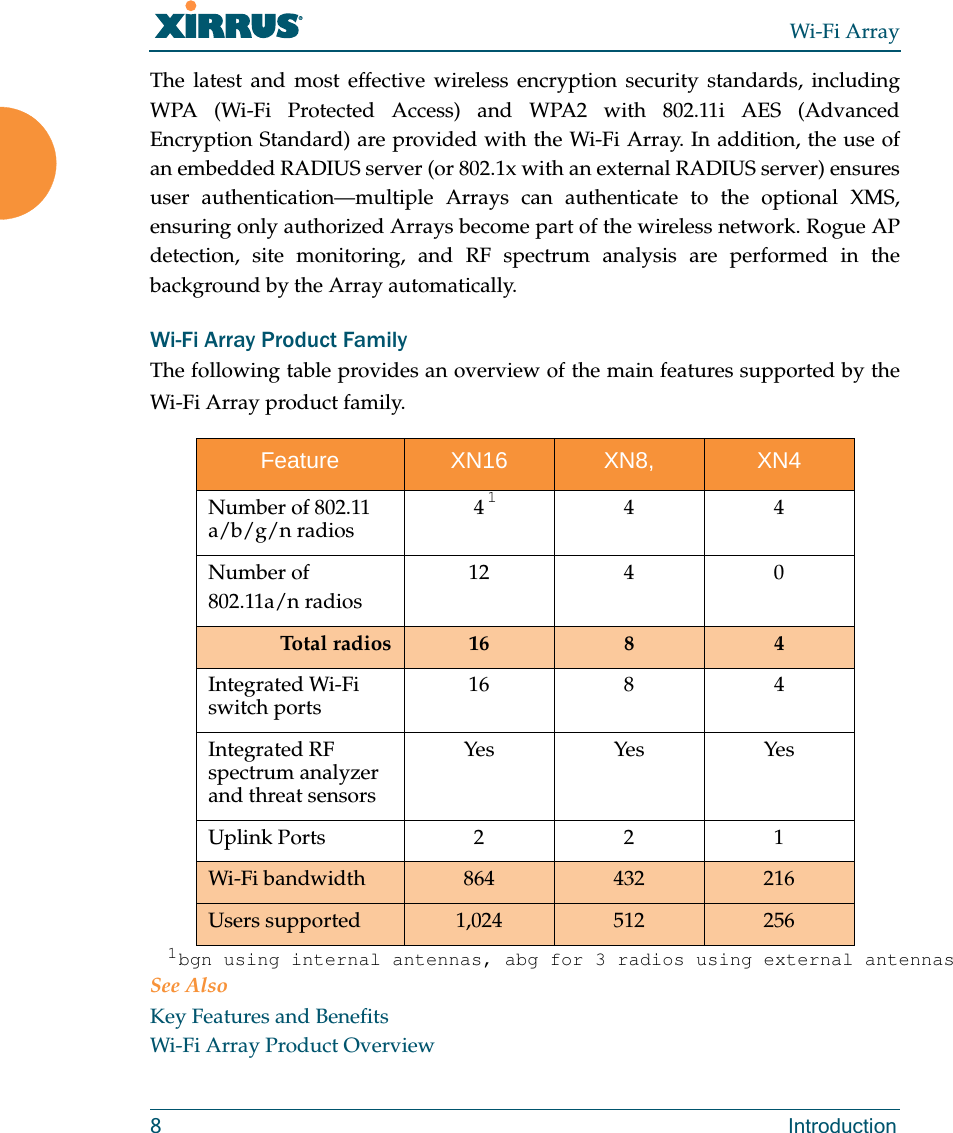

Wi-Fi Array8 IntroductionThe latest and most effective wireless encryption security standards, including WPA (Wi-Fi Protected Access) and WPA2 with 802.11i AES (Advanced Encryption Standard) are provided with the Wi-Fi Array. In addition, the use of an embedded RADIUS server (or 802.1x with an external RADIUS server) ensures user authentication—multiple Arrays can authenticate to the optional XMS, ensuring only authorized Arrays become part of the wireless network. Rogue AP detection, site monitoring, and RF spectrum analysis are performed in the background by the Array automatically.Wi-Fi Array Product FamilyThe following table provides an overview of the main features supported by the Wi-Fi Array product family.  See AlsoKey Features and BenefitsWi-Fi Array Product OverviewFeature XN16 XN8, XN4Number of 802.11 a/b/g/n radios 444Number of802.11a/n radios12 4 0Total radios 16 8 4Integrated Wi-Fi switch ports 16 8 4Integrated RF spectrum analyzer and threat sensorsYes Yes YesUplink Ports 221Wi-Fi bandwidth 864 432 216Users supported 1,024 512 25611bgn using internal antennas, abg for 3 radios using external antennas

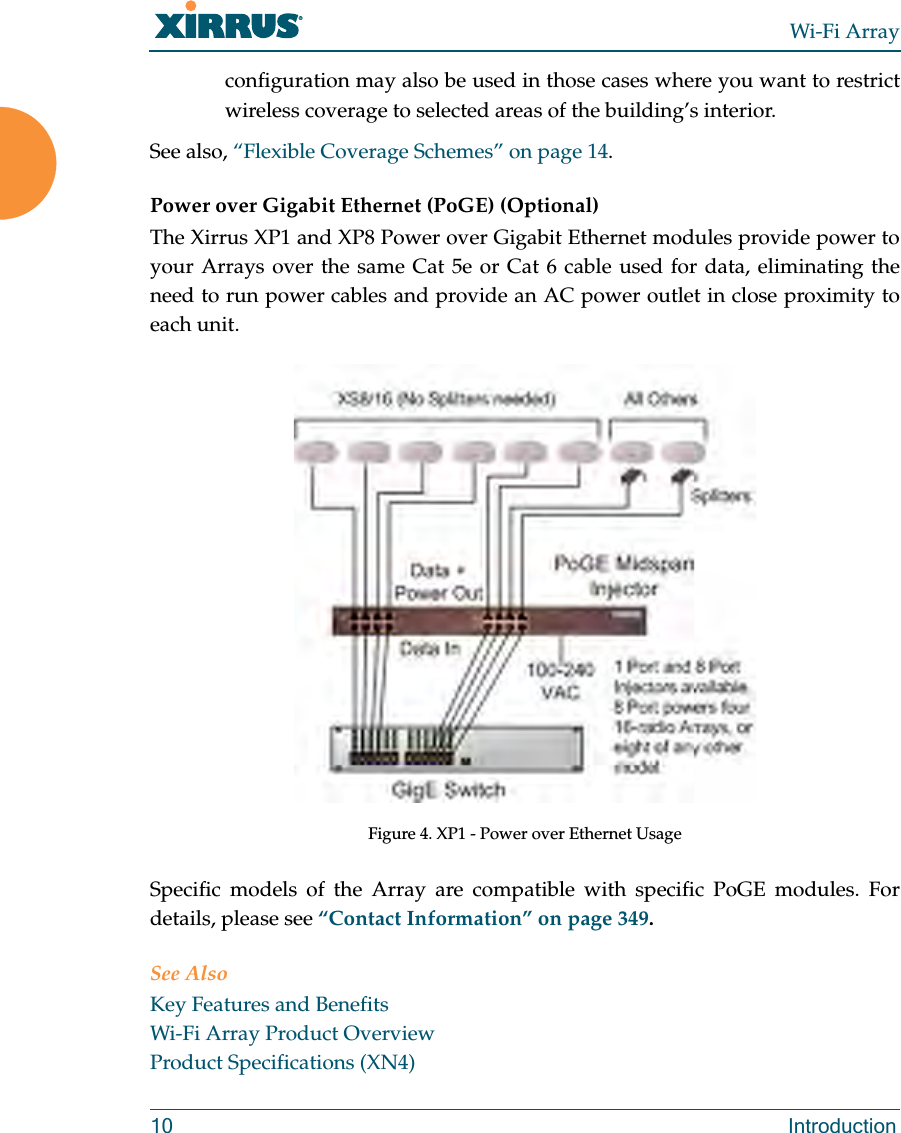

Wi-Fi ArrayIntroduction 9Product Specifications (XN4)Product Specifications (XN16 and XN8)Power over Gigabit Ethernet (PoGE) (Optional)Why Choose the Xirrus Wi-Fi Array?Deployment FlexibilityXirrus’ unique multi-radio architecture generates 360 degrees of sectored high-gain 802.11a/b/g/n coverage that provides extended range and the highest possible data rates for a large volume of clients. Each sector can be controlled automatically or manually, creating a pattern of wireless coverage perfectly tailored to individual customer needs. For example:Figure 3. Wireless Coverage PatternsFigure 3 depicts the following two scenarios:zFull pattern coverageAll radios are activated with coverage spanning 360 degrees. If within range, clients will always receive coverage regardless of their geographic position relative to the Array.zPartial pattern coverageIf desired, the Wi-Fi Array can be deployed close to an exterior wall. In this case, half of all available radios have been deactivated to prevent redundant signals from “bleeding” beyond the site’s perimeter wall. This outside wall
Wi-Fi Array10 Introductionconfiguration may also be used in those cases where you want to restrict wireless coverage to selected areas of the building’s interior.See also, “Flexible Coverage Schemes” on page 14.Power over Gigabit Ethernet (PoGE) (Optional)The Xirrus XP1 and XP8 Power over Gigabit Ethernet modules provide power to your Arrays over the same Cat 5e or Cat 6 cable used for data, eliminating the need to run power cables and provide an AC power outlet in close proximity to each unit.Figure 4. XP1 - Power over Ethernet UsageSpecific models of the Array are compatible with specific PoGE modules. For details, please see “Contact Information” on page 349. See AlsoKey Features and BenefitsWi-Fi Array Product OverviewProduct Specifications (XN4)

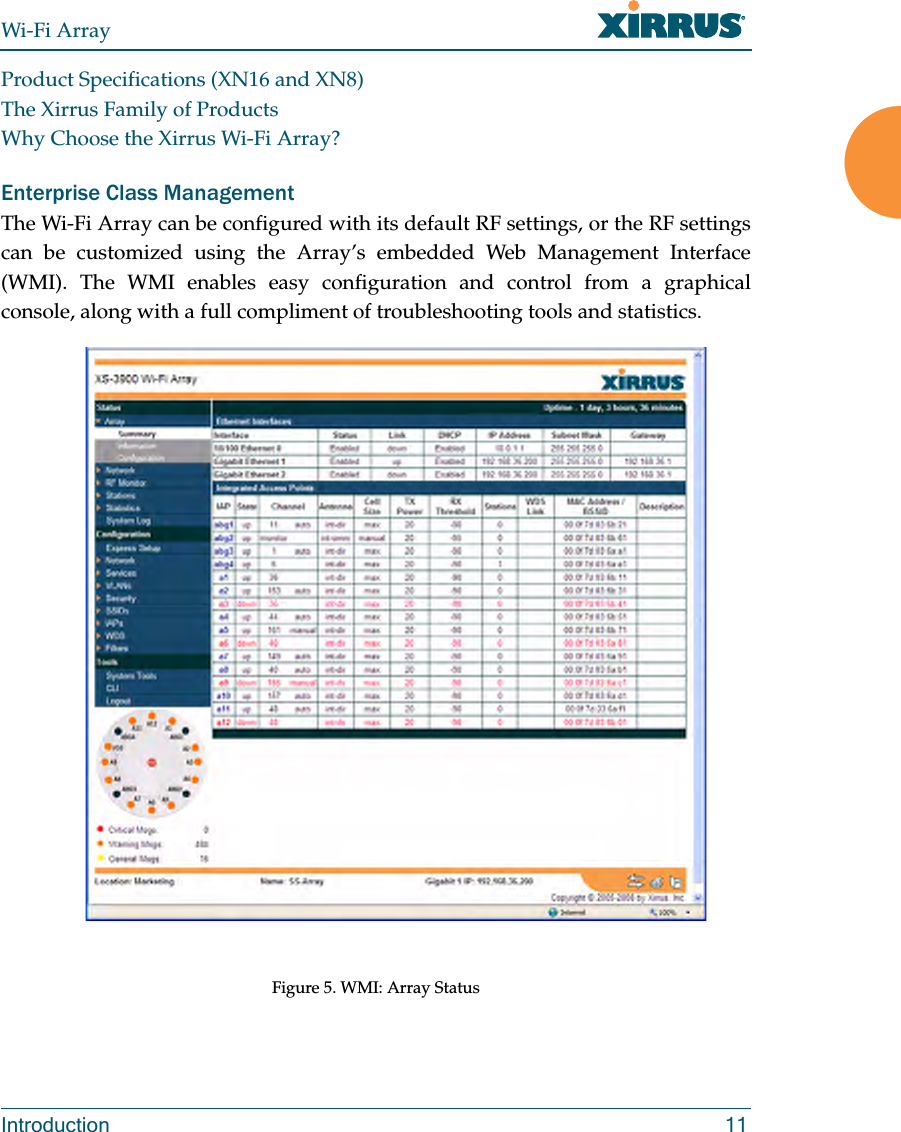

Wi-Fi ArrayIntroduction 11Product Specifications (XN16 and XN8)The Xirrus Family of ProductsWhy Choose the Xirrus Wi-Fi Array?Enterprise Class Management The Wi-Fi Array can be configured with its default RF settings, or the RF settings can be customized using the Array’s embedded Web Management Interface (WMI). The WMI enables easy configuration and control from a graphical console, along with a full compliment of troubleshooting tools and statistics.Figure 5. WMI: Array Status

Wi-Fi Array12 IntroductionIn addition, a fully featured Command Line Interface (CLI) offers IT professionals a familiar management and control environment. SNMP (Simple Network Management Protocol) is also supported to allow management from an SNMP compliant management tool, such as the optional Xirrus Management System.See AlsoKey Features and BenefitsProduct Specifications (XN4)Product Specifications (XN16 and XN8)Power over Gigabit Ethernet (PoGE) (Optional)The Xirrus Family of ProductsWhy Choose the Xirrus Wi-Fi Array?#For deployments of more than five Arrays, we recommend that you use the Xirrus Management System (XMS). The XMS offers a rich set of features for fine control over large deployments.

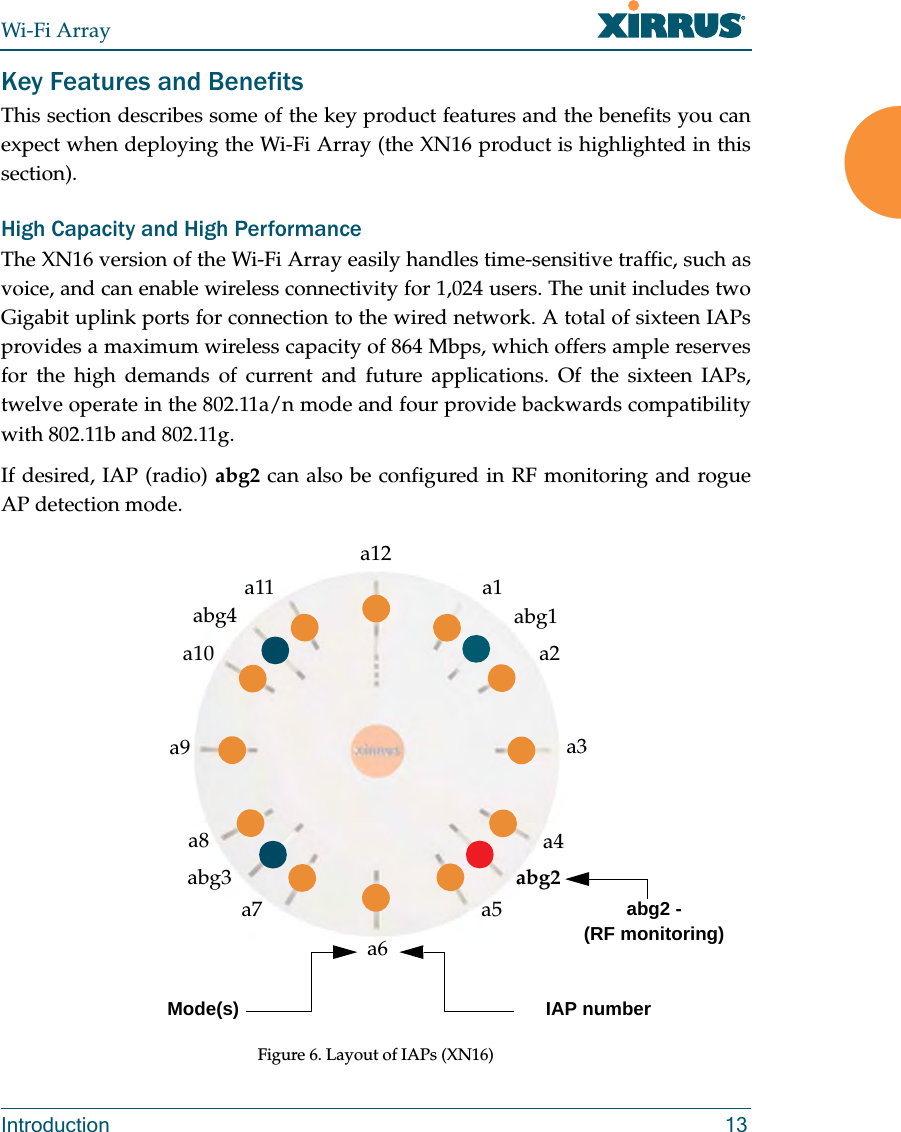

Wi-Fi ArrayIntroduction 13Key Features and BenefitsThis section describes some of the key product features and the benefits you can expect when deploying the Wi-Fi Array (the XN16 product is highlighted in this section). High Capacity and High PerformanceThe XN16 version of the Wi-Fi Array easily handles time-sensitive traffic, such as voice, and can enable wireless connectivity for 1,024 users. The unit includes two Gigabit uplink ports for connection to the wired network. A total of sixteen IAPs provides a maximum wireless capacity of 864 Mbps, which offers ample reserves for the high demands of current and future applications. Of the sixteen IAPs, twelve operate in the 802.11a/n mode and four provide backwards compatibility with 802.11b and 802.11g.If desired, IAP (radio) abg2 can also be configured in RF monitoring and rogue AP detection mode.Figure 6. Layout of IAPs (XN16)a1abg1a2a3a4abg2 a5a6a7abg3a8a9a10abg4a11a12Mode(s) IAP numberabg2 - (RF monitoring)

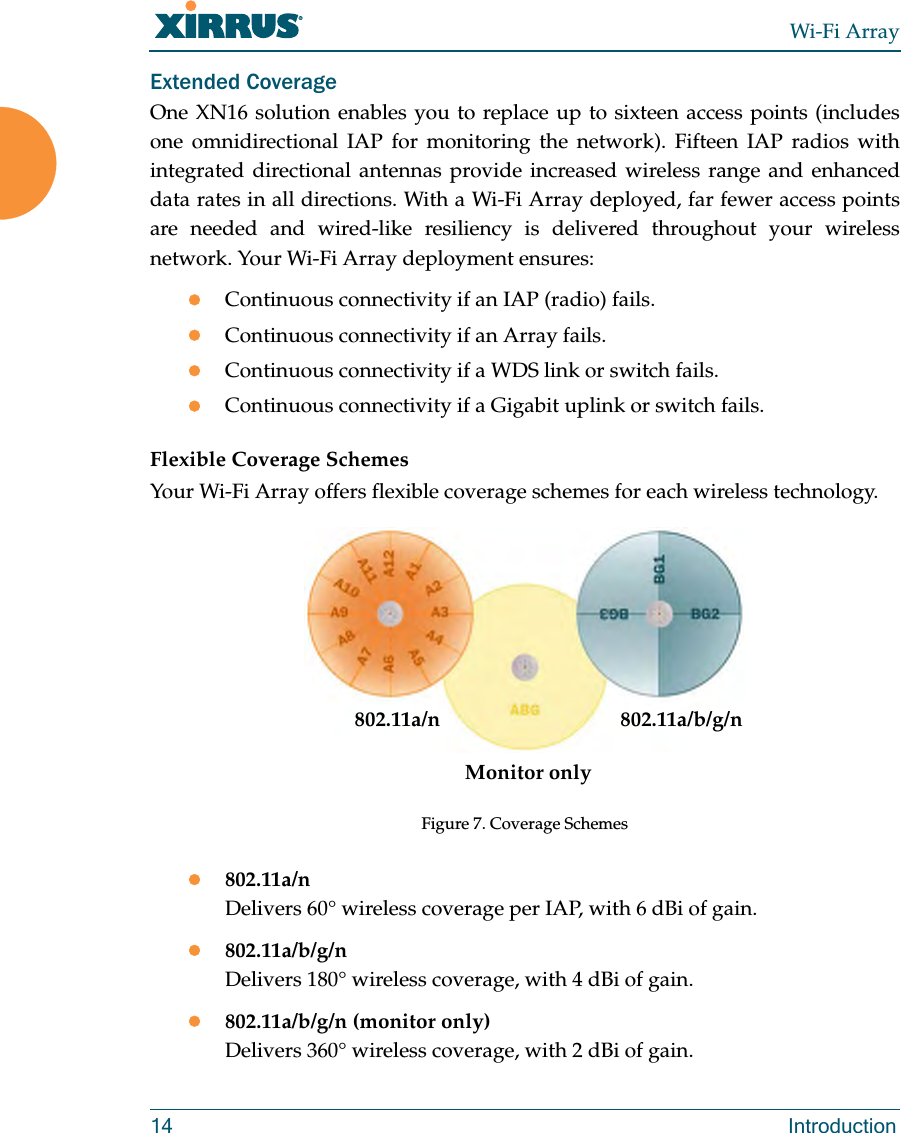

Wi-Fi Array14 IntroductionExtended CoverageOne XN16 solution enables you to replace up to sixteen access points (includes one omnidirectional IAP for monitoring the network). Fifteen IAP radios with integrated directional antennas provide increased wireless range and enhanced data rates in all directions. With a Wi-Fi Array deployed, far fewer access points are needed and wired-like resiliency is delivered throughout your wireless network. Your Wi-Fi Array deployment ensures:zContinuous connectivity if an IAP (radio) fails.zContinuous connectivity if an Array fails.zContinuous connectivity if a WDS link or switch fails.zContinuous connectivity if a Gigabit uplink or switch fails.Flexible Coverage SchemesYour Wi-Fi Array offers flexible coverage schemes for each wireless technology.Figure 7. Coverage Schemesz802.11a/nDelivers 60° wireless coverage per IAP, with 6 dBi of gain.z802.11a/b/g/nDelivers 180° wireless coverage, with 4 dBi of gain.z802.11a/b/g/n (monitor only)Delivers 360° wireless coverage, with 2 dBi of gain.802.11a/nMonitor only802.11a/b/g/n

Wi-Fi ArrayIntroduction 15Non-Overlapping ChannelsComplete use of non-overlapping channels limits interference and delivers maximum capacity. On the XN16, up to 16 non-overlapping channels are fully utilized across the 5GHz and 2.4GHz spectrums (up to 12 across the 5GHz spectrum plus up to 3 across the 2.4 GHz spectrum—typically, one additional radio is used as a dedicated RF monitor).Secure Wireless AccessMultiple layers of authentication and encryption ensure secure data transmissions. The Wi-Fi Array is 802.11i compliant with encryption support for 40 bit and 128 bit WEP, WPA and WPA2 with TKIP and AES encryption. Authentication support is provided via 802.1x, including PEAP, EAP-TLS, EAP-TTLS, and LEAP (Lightweight Extensible Authentication Protocol) passthrough.Applications EnablementQoS (Quality of Service) functionality combined with true switch capabilities enable high density video and Voice over Wireless LAN deployments. Compliant with 802.1p and 802.1Q standards. SDMA OptimizationSDMA (Spatial Division Multiple Access) technology provides full 360° coverage while allowing independent channel and power output customization. Also supports fast inter-zone handoffs for time-sensitive applications and roaming support.Fast RoamingUtilizes the Xirrus Roaming Protocol (XRP) ensuring fast and seamless roaming capabilities between IAPs or Arrays at both Layer 2 and Layer 3.Easy DeploymentThe Xirrus Management System (XMS) offers real time monitoring and management capabilities of the wireless network—ideal for the Enterprise market. It also allows you to import floor plans to help you plan your deployment. The Xirrus Wi-Fi Array chassis has a plenum rated, lockable and tamper resistant case.
Wi-Fi Array16 IntroductionSee AlsoWi-Fi Array Product OverviewProduct Specifications (XN4))Product Specifications (XN16 and XN8)Power over Gigabit Ethernet (PoGE) (Optional)The Xirrus Family of ProductsWhy Choose the Xirrus Wi-Fi Array?Product Specifications (XN16 and XN8)Element SpecificationsNumber of Users Maximum of 64 associated users per radio1024 users per Array (XN16)512 users per Array (XN8)Physical Diameter: 18.65 inches (47.37 cm)Height: 3.87 inches (9.83 cm)Weight: 8lbs (3.63 kg) Environmental Operating Temperature:-10°C to 50°C0% to 90% relative humidity (non-condensing)Storage Temperature:-20°C to 60°C5% to 95% relative humidity (non-condensing)System 1 GHz CPU (XN16/XN8)1 GB RAM (XN16/XN8)512 MB system flash Expansion slot for future options

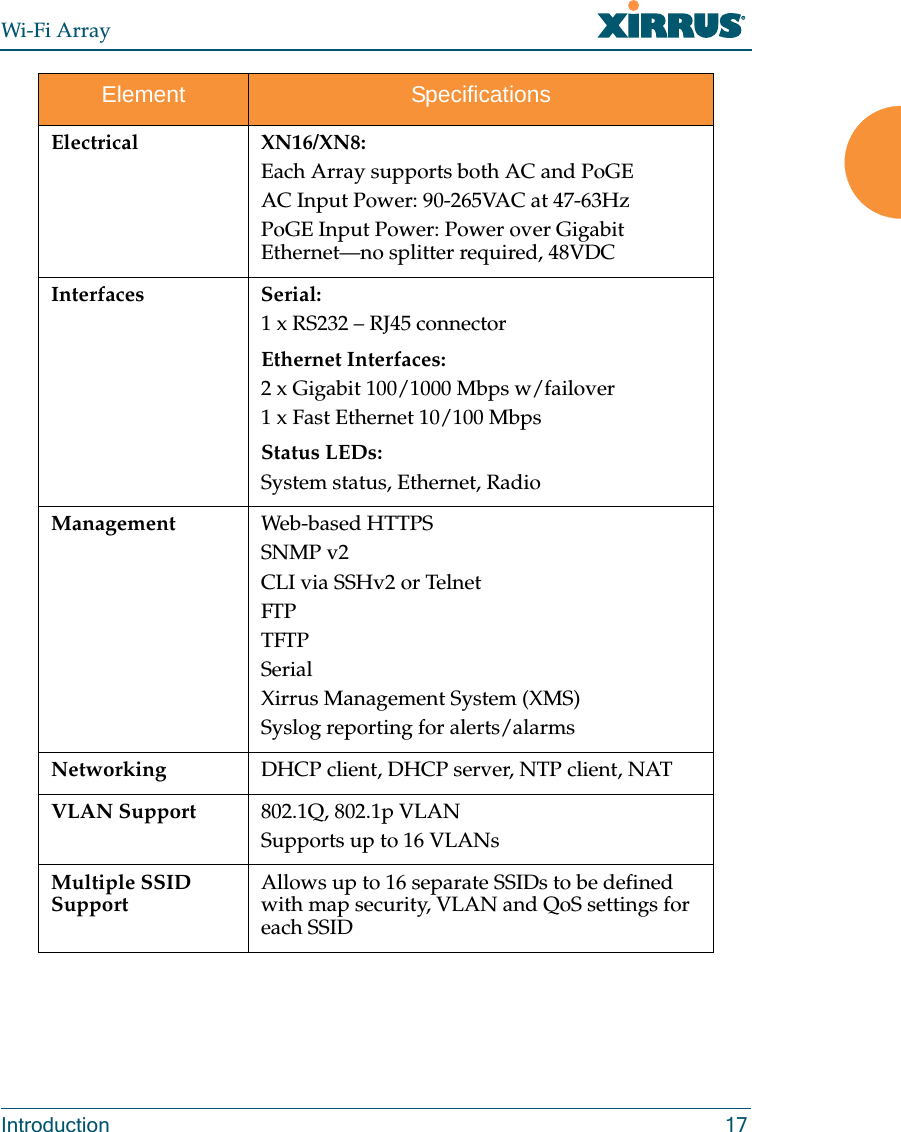

Wi-Fi ArrayIntroduction 17Electrical XN16/XN8:Each Array supports both AC and PoGEAC Input Power: 90-265VAC at 47-63Hz PoGE Input Power: Power over Gigabit Ethernet—no splitter required, 48VDC Interfaces Serial:1 x RS232 – RJ45 connectorEthernet Interfaces:2 x Gigabit 100/1000 Mbps w/failover1 x Fast Ethernet 10/100 MbpsStatus LEDs:System status, Ethernet, RadioManagement Web-based HTTPSSNMP v2CLI via SSHv2 or TelnetFTPTFTPSerialXirrus Management System (XMS)Syslog reporting for alerts/alarmsNetworking DHCP client, DHCP server, NTP client, NAT VLAN Support 802.1Q, 802.1p VLANSupports up to 16 VLANsMultiple SSID SupportAllows up to 16 separate SSIDs to be defined with map security, VLAN and QoS settings for each SSIDElement Specifications
Wi-Fi Array18 IntroductionPerformance Client Load BalancingAutomatic load balancing between system radiosQuality of Service:802.1p wired traffic prioritizationWireless packet prioritizationMAP CoS to TCIDFair queuing of downstream trafficSecurity Wireless Security:WEP 40bit/128bit encryptionWPA and WPA2 with TKIP and AES encryptionRogue AP detection, with alerts and classificationUser and System Authentication:WPA and WPA2 Pre-Shared Key authenticationInternal RADIUS Server, supports EAP-PEAP only802.1x EAP-TLS802.1x EAP-TTLS/MSCHAPv2802.1x PEAPv0/EAP-MSCHAPv2802.1x PEAPv1/EAP-GTC802.1x EAP-SIM802.1x EAP-LEAP Passthrough External RADIUS serversAuthentication of Wi-Fi Arrays to the Xirrus Management System (XMS)Element Specifications

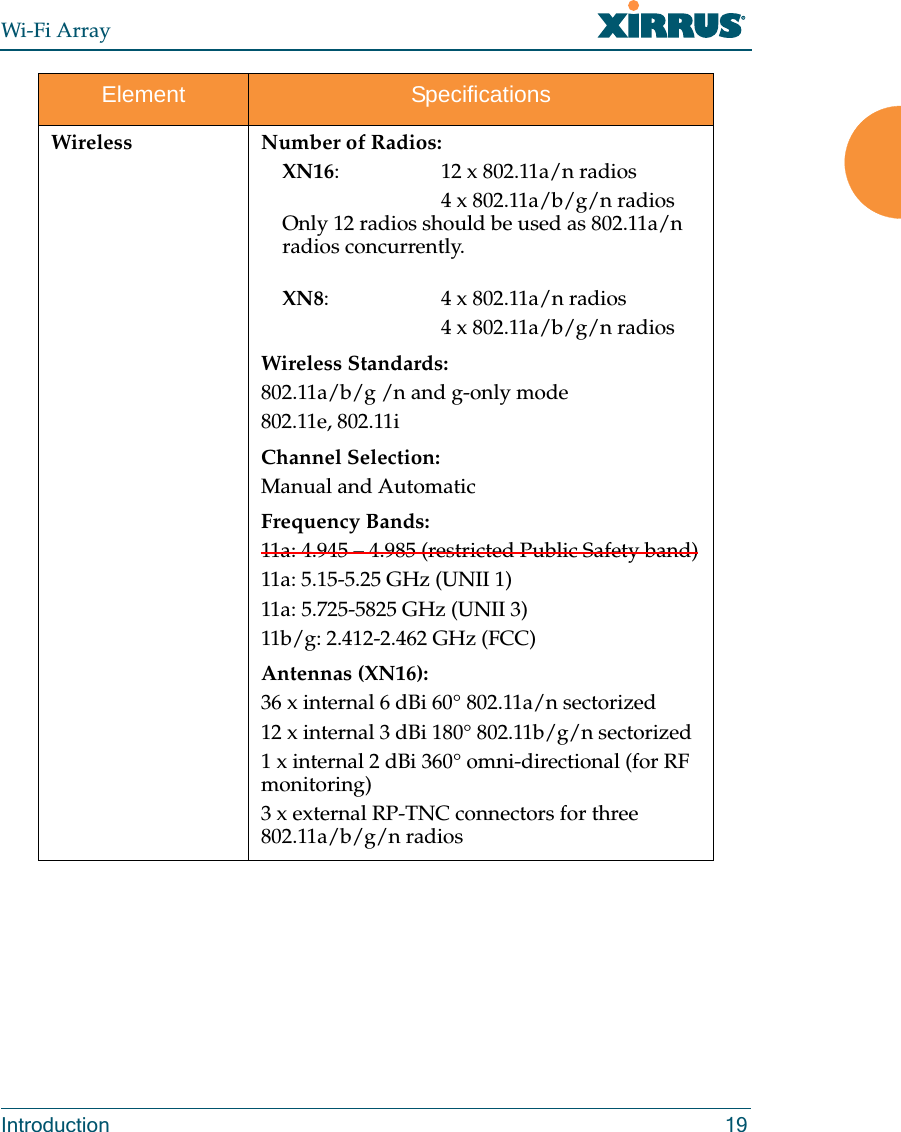

Wi-Fi ArrayIntroduction 19Wireless Number of Radios:XN16: 12 x 802.11a/n radios4 x 802.11a/b/g/n radios Only 12 radios should be used as 802.11a/n radios concurrently.  XN8: 4 x 802.11a/n radios4 x 802.11a/b/g/n radiosWireless Standards:802.11a/b/g /n and g-only mode802.11e, 802.11iChannel Selection:Manual and AutomaticFrequency Bands: 11a: 4.945 – 4.985 (restricted Public Safety band)11a: 5.15-5.25 GHz (UNII 1)11a: 5.725-5825 GHz (UNII 3)11b/g: 2.412-2.462 GHz (FCC)Antennas (XN16):36 x internal 6 dBi 60° 802.11a/n sectorized12 x internal 3 dBi 180° 802.11b/g/n sectorized1 x internal 2 dBi 360° omni-directional (for RF monitoring)3 x external RP-TNC connectors for three 802.11a/b/g/n radiosElement Specifications
Wi-Fi Array20 IntroductionSee AlsoKey Features and BenefitsWi-Fi Array Product OverviewProduct Specifications (XN4)Power over Gigabit Ethernet (PoGE) (Optional)The Xirrus Family of ProductsWhy Choose the Xirrus Wi-Fi Array?Antennas (XN8):24 x internal 6 dBi 60° 802.11a sectorized12 x internal 3 dBi 180° 802.11b/g sectorized1 x internal 2 dBi 360° omni-directional (for RF monitoring)3 x external RP-TNC connectors for three 802.11a/b/g/n radiosRadio Approvals:FCC (United States) Compliance FCC Part 15.107 and 15109, Class BWarranty One year (hardware and software) Element Specifications

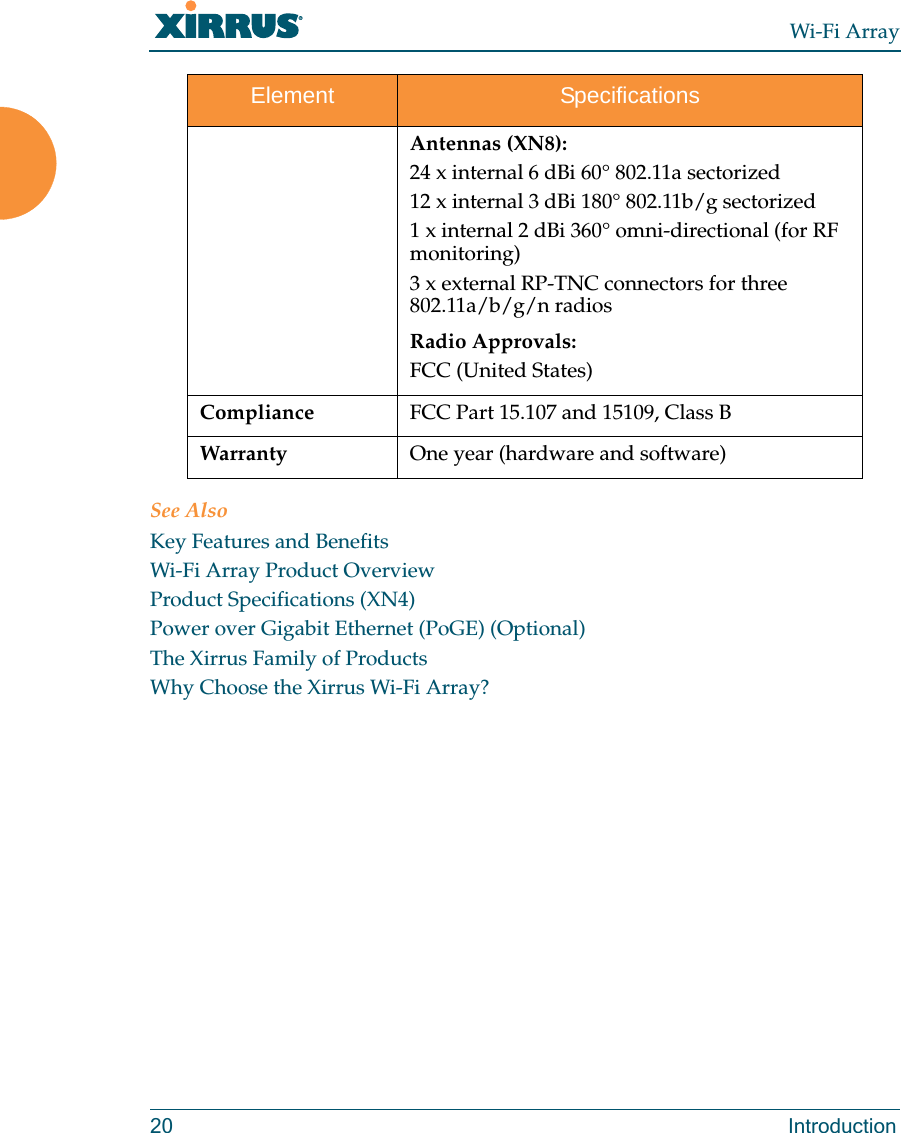

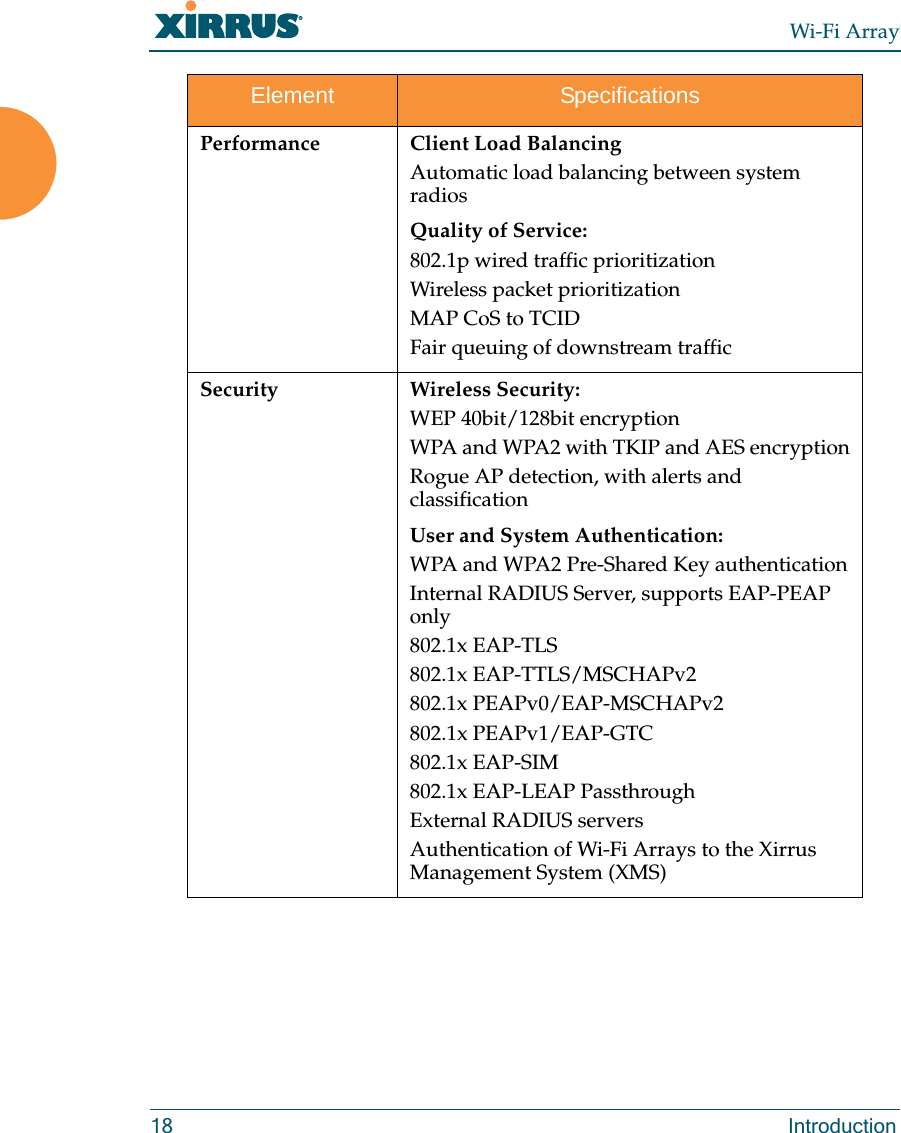

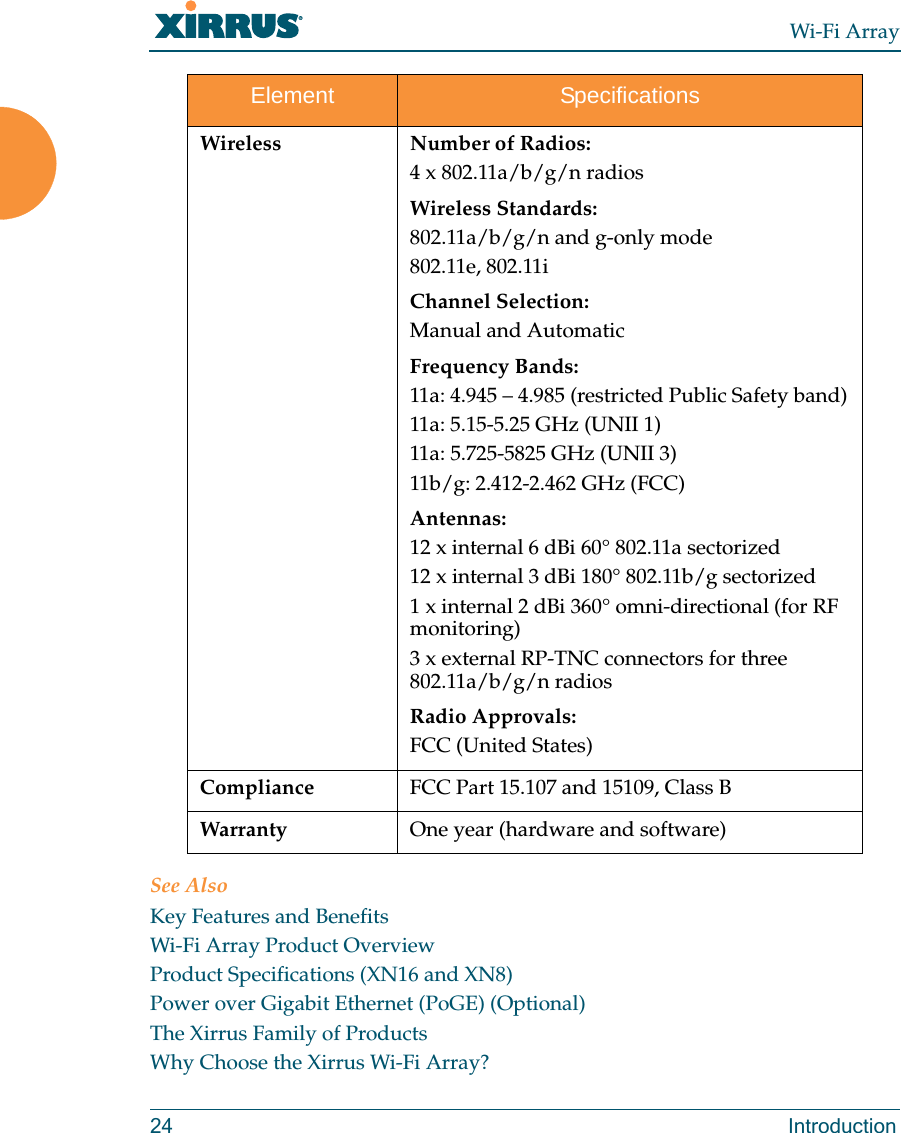

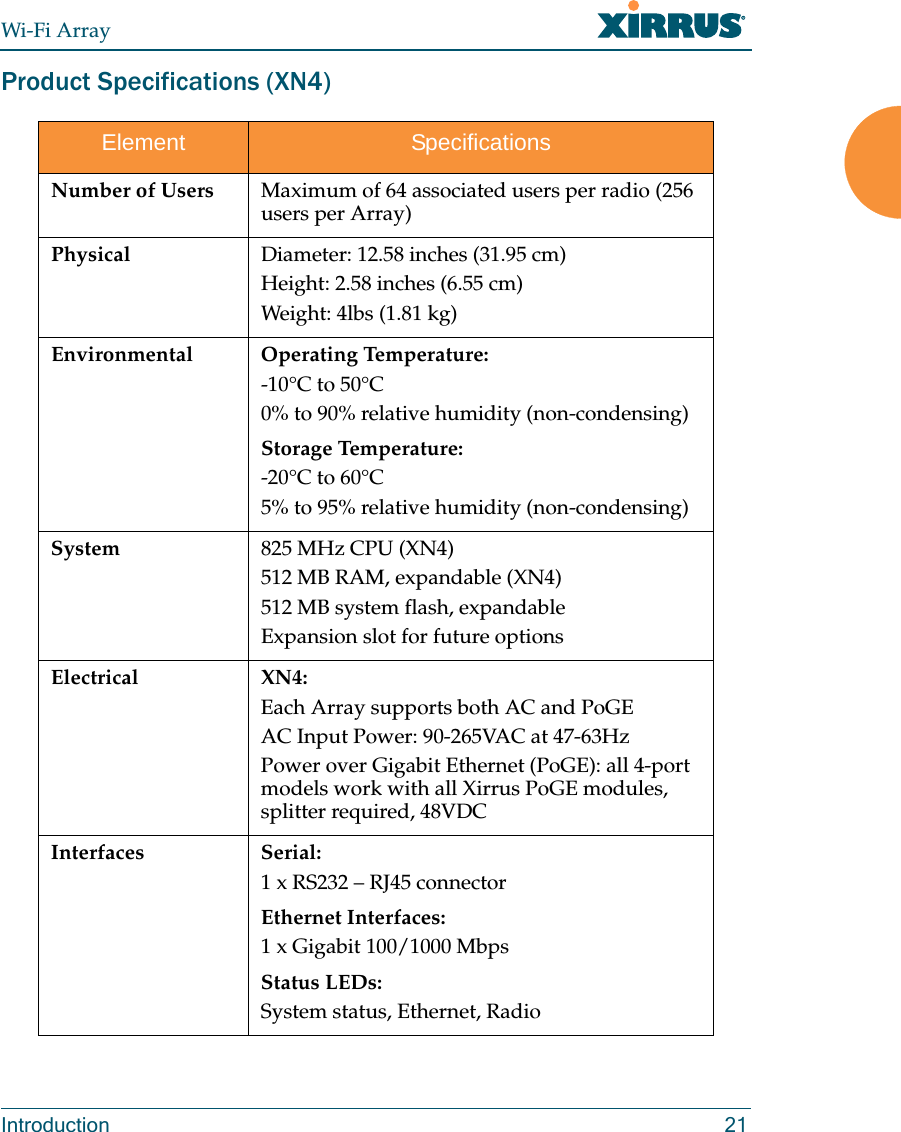

Wi-Fi ArrayIntroduction 21Product Specifications (XN4)Element SpecificationsNumber of Users Maximum of 64 associated users per radio (256 users per Array)Physical Diameter: 12.58 inches (31.95 cm)Height: 2.58 inches (6.55 cm)Weight: 4lbs (1.81 kg) Environmental Operating Temperature:-10°C to 50°C0% to 90% relative humidity (non-condensing)Storage Temperature:-20°C to 60°C5% to 95% relative humidity (non-condensing)System 825 MHz CPU (XN4)512 MB RAM, expandable (XN4)512 MB system flash, expandableExpansion slot for future optionsElectrical XN4: Each Array supports both AC and PoGEAC Input Power: 90-265VAC at 47-63Hz Power over Gigabit Ethernet (PoGE): all 4-port models work with all Xirrus PoGE modules, splitter required, 48VDC Interfaces Serial:1 x RS232 – RJ45 connectorEthernet Interfaces:1 x Gigabit 100/1000 MbpsStatus LEDs:System status, Ethernet, Radio

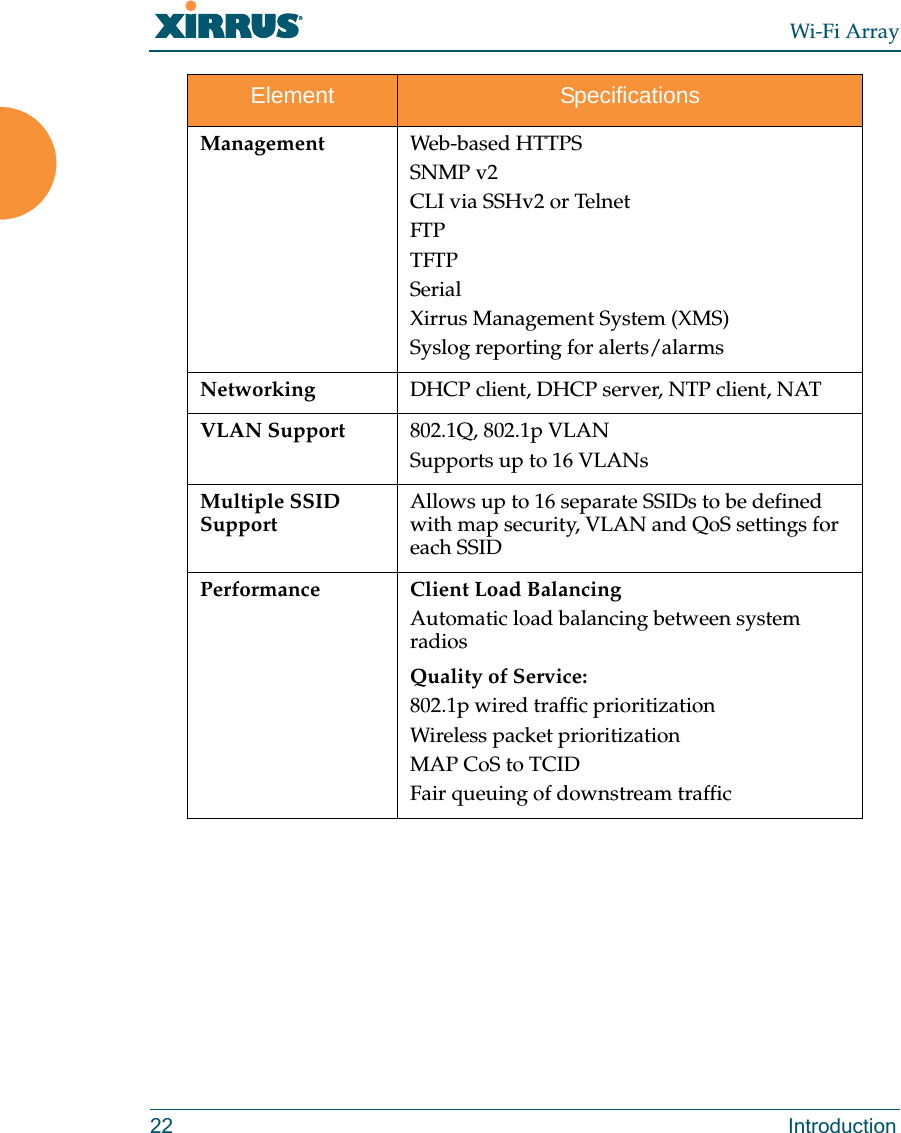

Wi-Fi Array22 IntroductionManagement Web-based HTTPSSNMP v2CLI via SSHv2 or TelnetFTPTFTPSerialXirrus Management System (XMS)Syslog reporting for alerts/alarmsNetworking DHCP client, DHCP server, NTP client, NATVLAN Support 802.1Q, 802.1p VLANSupports up to 16 VLANsMultiple SSID SupportAllows up to 16 separate SSIDs to be defined with map security, VLAN and QoS settings for each SSIDPerformance Client Load BalancingAutomatic load balancing between system radiosQuality of Service:802.1p wired traffic prioritizationWireless packet prioritizationMAP CoS to TCIDFair queuing of downstream trafficElement Specifications

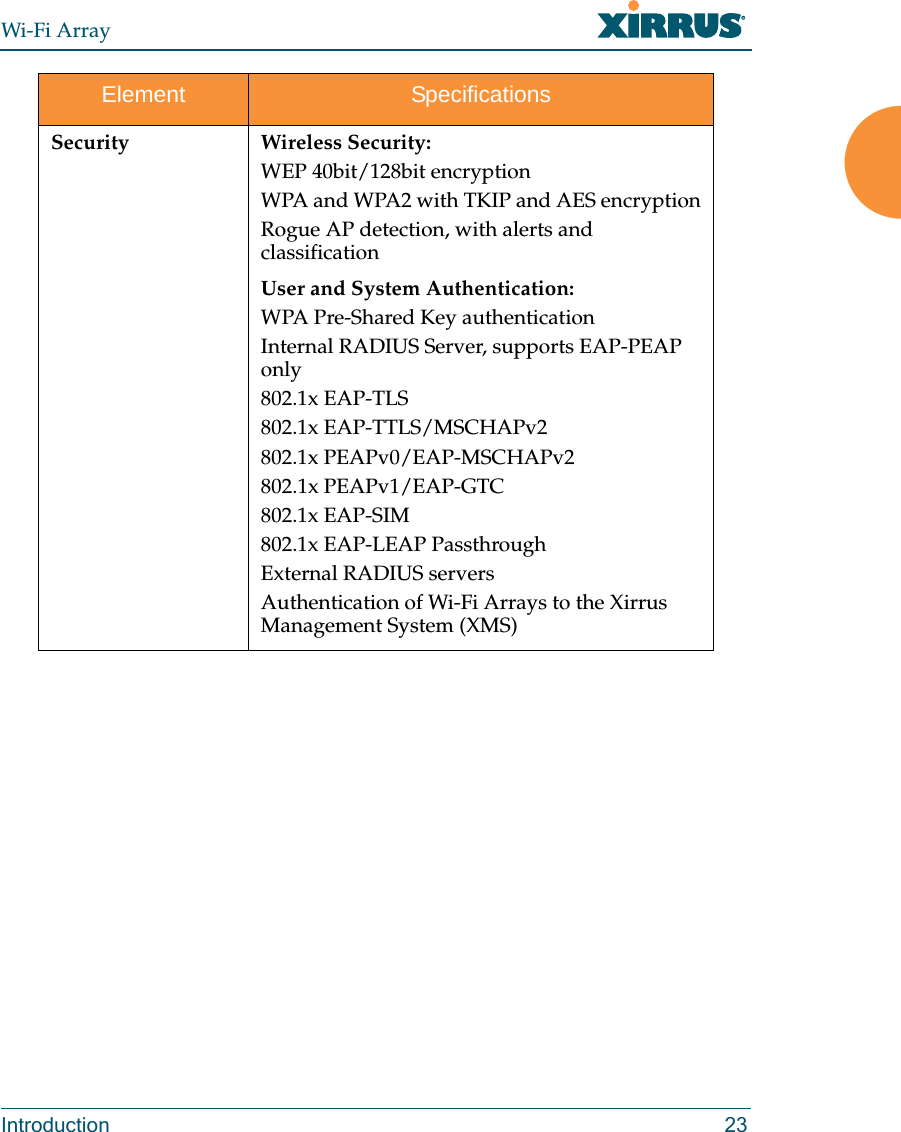

Wi-Fi ArrayIntroduction 23Security Wireless Security:WEP 40bit/128bit encryptionWPA and WPA2 with TKIP and AES encryptionRogue AP detection, with alerts and classificationUser and System Authentication:WPA Pre-Shared Key authenticationInternal RADIUS Server, supports EAP-PEAP only802.1x EAP-TLS802.1x EAP-TTLS/MSCHAPv2802.1x PEAPv0/EAP-MSCHAPv2802.1x PEAPv1/EAP-GTC802.1x EAP-SIM802.1x EAP-LEAP Passthrough External RADIUS serversAuthentication of Wi-Fi Arrays to the Xirrus Management System (XMS)Element Specifications
Wi-Fi Array24 IntroductionSee AlsoKey Features and BenefitsWi-Fi Array Product OverviewProduct Specifications (XN16 and XN8)Power over Gigabit Ethernet (PoGE) (Optional)The Xirrus Family of ProductsWhy Choose the Xirrus Wi-Fi Array?Wireless Number of Radios:4 x 802.11a/b/g/n radiosWireless Standards:802.11a/b/g/n and g-only mode802.11e, 802.11iChannel Selection:Manual and AutomaticFrequency Bands: 11a: 4.945 – 4.985 (restricted Public Safety band)11a: 5.15-5.25 GHz (UNII 1)11a: 5.725-5825 GHz (UNII 3)11b/g: 2.412-2.462 GHz (FCC)Antennas:12 x internal 6 dBi 60° 802.11a sectorized12 x internal 3 dBi 180° 802.11b/g sectorized1 x internal 2 dBi 360° omni-directional (for RF monitoring)3 x external RP-TNC connectors for three 802.11a/b/g/n radiosRadio Approvals:FCC (United States) Compliance FCC Part 15.107 and 15109, Class BWarranty One year (hardware and software)Element Specifications
Wi-Fi ArrayIntroduction 25
Wi-Fi Array26 Introduction

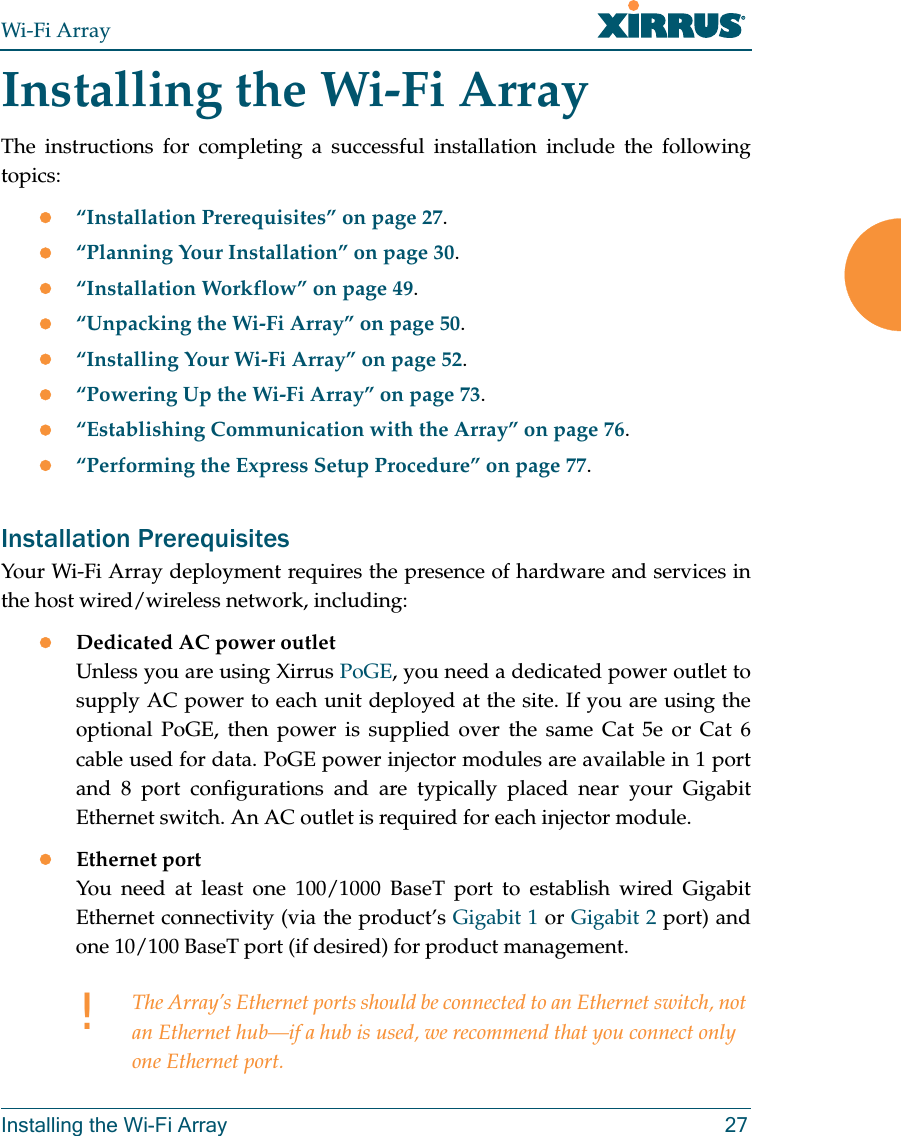

Wi-Fi ArrayInstalling the Wi-Fi Array 27Installing the Wi-Fi ArrayThe instructions for completing a successful installation include the following topics:z“Installation Prerequisites” on page 27.z“Planning Your Installation” on page 30.z“Installation Workflow” on page 49.z“Unpacking the Wi-Fi Array” on page 50.z“Installing Your Wi-Fi Array” on page 52.z“Powering Up the Wi-Fi Array” on page 73.z“Establishing Communication with the Array” on page 76.z“Performing the Express Setup Procedure” on page 77.Installation PrerequisitesYour Wi-Fi Array deployment requires the presence of hardware and services in the host wired/wireless network, including:zDedicated AC power outletUnless you are using Xirrus PoGE, you need a dedicated power outlet to supply AC power to each unit deployed at the site. If you are using the optional PoGE, then power is supplied over the same Cat 5e or Cat 6 cable used for data. PoGE power injector modules are available in 1 port and 8 port configurations and are typically placed near your Gigabit Ethernet switch. An AC outlet is required for each injector module.zEthernet port You need at least one 100/1000 BaseT port to establish wired Gigabit Ethernet connectivity (via the product’s Gigabit 1 or Gigabit 2 port) and one 10/100 BaseT port (if desired) for product management. !The Array’s Ethernet ports should be connected to an Ethernet switch, not an Ethernet hub—if a hub is used, we recommend that you connect only one Ethernet port.
Wi-Fi Array28 Installing the Wi-Fi ArrayzSecure Shell (SSH) utilityTo establish secure remote command line access to the Array, you need a Secure Shell (SSH) utility, such as PuTTY.zSecure Web browserEither Internet Explorer (version 6.0 or higher), Netscape Navigator (version 7.0 or higher), or Mozilla Firefox (version 1.01 or higher).A secure Web browser is required for Web-based management of the Array. The browser must be on the same subnet as the Array, or you must set a static route for management as described in the warning above. zSerial connection capabilityTo connect directly to the console port on the Array, your computer must be equipped with a male 9-pin serial port and terminal emulation software (for example, HyperTerminal). The Xirrus Array only supports serial cable lengths up to 25’ per the RS-232 specification. Use the following settings when establishing a serial connection:!The Gigabit1 Ethernet interface is the primary port for both data and management traffic. If a single Ethernet connection is used, it must be connected to the Gigabit1 Ethernet interface. See also, “Port Failover Protection” on page 40.The 10/100 Ethernet Port may be used for managing the Array out of band from the Gigabit Ethernet ports. The 10/100 port will route only management traffic, using a static route that may be configured for this interface. See “interface” on page 273. Bits per second 115,200Data bits 8Parity NoneStop bits 1Flow control None

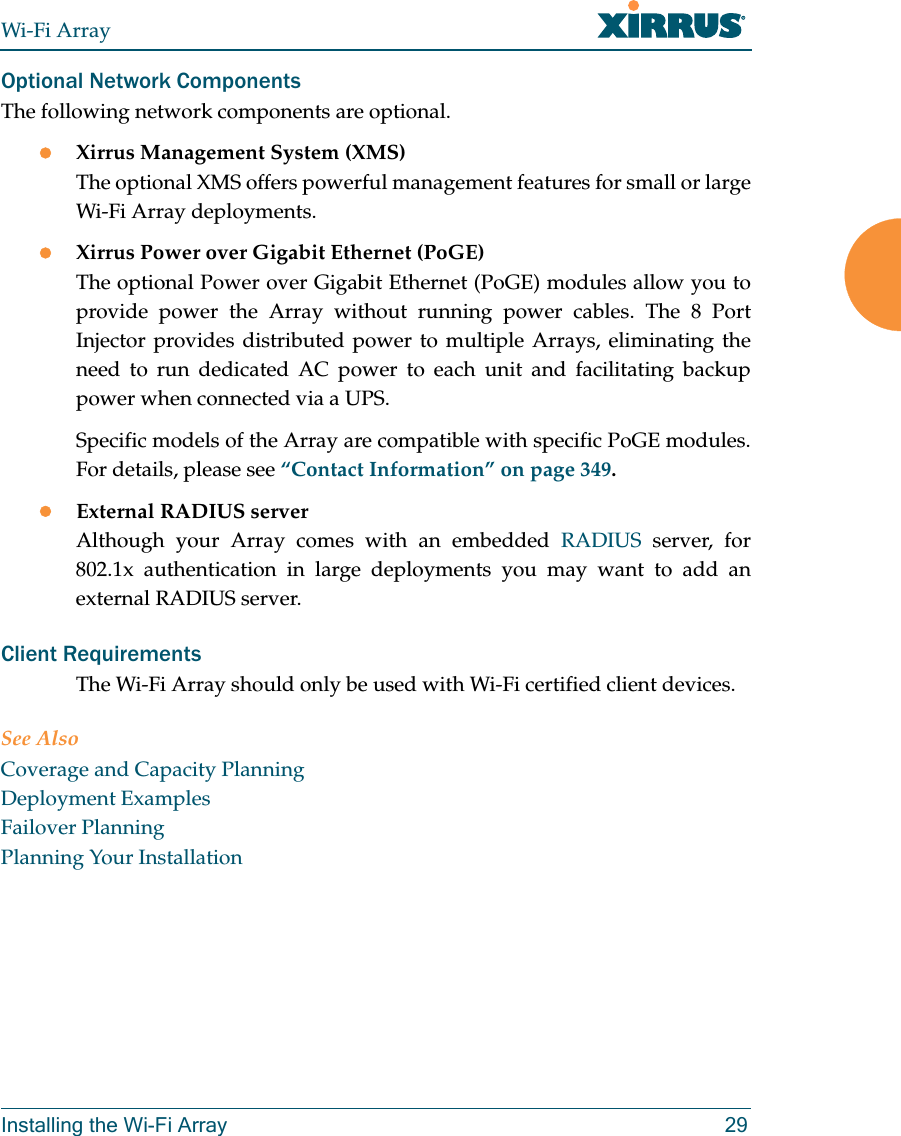

Wi-Fi ArrayInstalling the Wi-Fi Array 29Optional Network ComponentsThe following network components are optional.zXirrus Management System (XMS)The optional XMS offers powerful management features for small or large Wi-Fi Array deployments.zXirrus Power over Gigabit Ethernet (PoGE)The optional Power over Gigabit Ethernet (PoGE) modules allow you to provide power the Array without running power cables. The 8 Port Injector provides distributed power to multiple Arrays, eliminating the need to run dedicated AC power to each unit and facilitating backup power when connected via a UPS.Specific models of the Array are compatible with specific PoGE modules. For details, please see “Contact Information” on page 349. zExternal RADIUS serverAlthough your Array comes with an embedded RADIUS server, for 802.1x authentication in large deployments you may want to add an external RADIUS server.Client RequirementsThe Wi-Fi Array should only be used with Wi-Fi certified client devices.See AlsoCoverage and Capacity PlanningDeployment ExamplesFailover PlanningPlanning Your Installation

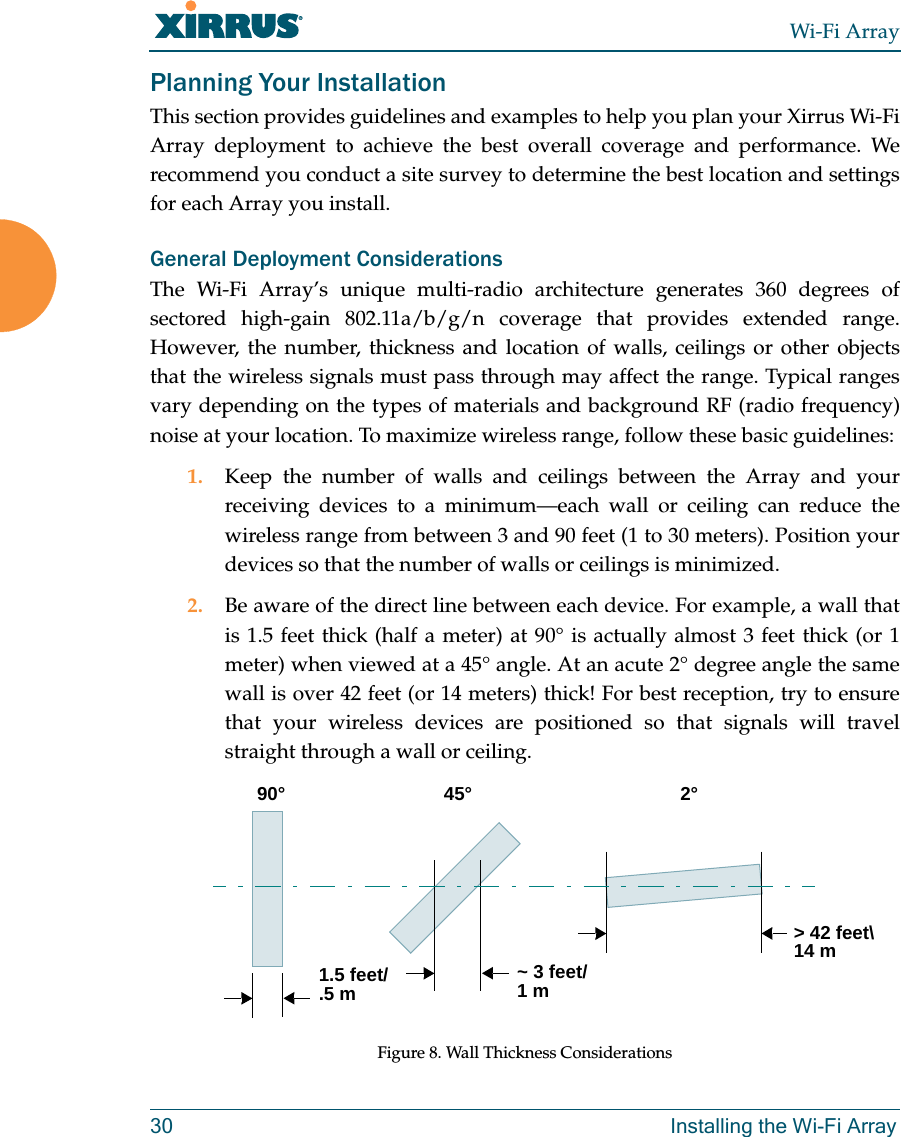

Wi-Fi Array30 Installing the Wi-Fi ArrayPlanning Your InstallationThis section provides guidelines and examples to help you plan your Xirrus Wi-Fi Array deployment to achieve the best overall coverage and performance. We recommend you conduct a site survey to determine the best location and settings for each Array you install.General Deployment ConsiderationsThe Wi-Fi Array’s unique multi-radio architecture generates 360 degrees of sectored high-gain 802.11a/b/g/n coverage that provides extended range. However, the number, thickness and location of walls, ceilings or other objects that the wireless signals must pass through may affect the range. Typical ranges vary depending on the types of materials and background RF (radio frequency) noise at your location. To maximize wireless range, follow these basic guidelines:1. Keep the number of walls and ceilings between the Array and your receiving devices to a minimum—each wall or ceiling can reduce the wireless range from between 3 and 90 feet (1 to 30 meters). Position your devices so that the number of walls or ceilings is minimized.2. Be aware of the direct line between each device. For example, a wall that is 1.5 feet thick (half a meter) at 90° is actually almost 3 feet thick (or 1 meter) when viewed at a 45° angle. At an acute 2° degree angle the same wall is over 42 feet (or 14 meters) thick! For best reception, try to ensure that your wireless devices are positioned so that signals will travel straight through a wall or ceiling.Figure 8. Wall Thickness Considerations90° 45°1.5 feet/ .5 m ~ 3 feet/ 1 m> 42 feet\ 14 m2°

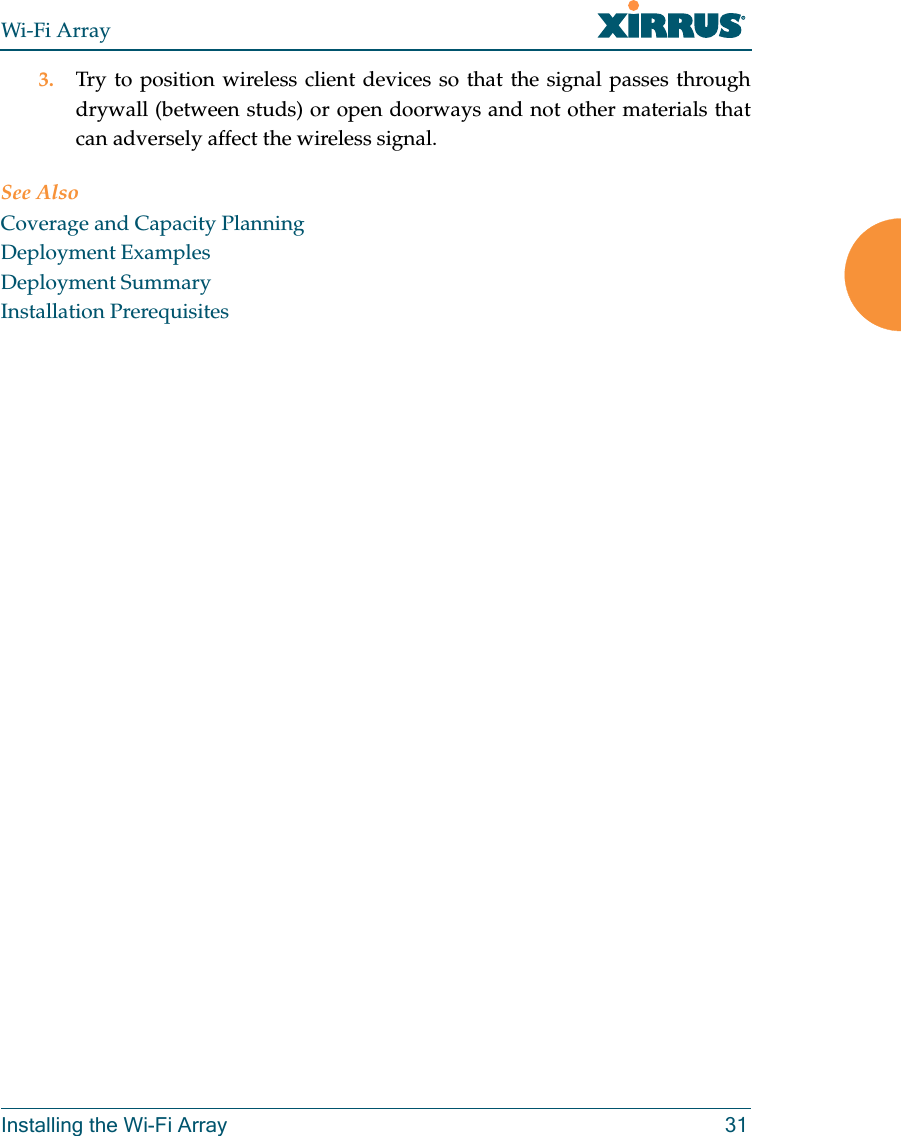

Wi-Fi ArrayInstalling the Wi-Fi Array 313. Try to position wireless client devices so that the signal passes through drywall (between studs) or open doorways and not other materials that can adversely affect the wireless signal.See AlsoCoverage and Capacity PlanningDeployment ExamplesDeployment SummaryInstallation Prerequisites

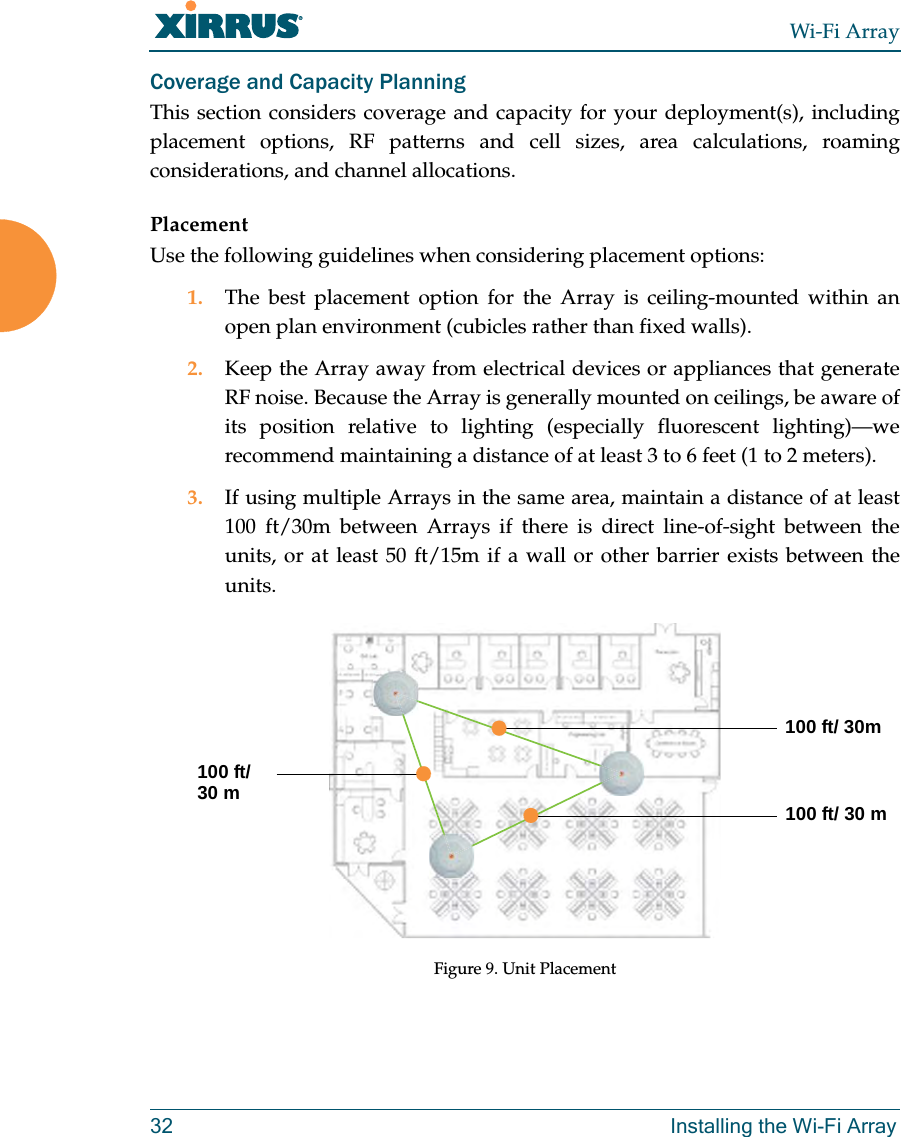

Wi-Fi Array32 Installing the Wi-Fi ArrayCoverage and Capacity PlanningThis section considers coverage and capacity for your deployment(s), including placement options, RF patterns and cell sizes, area calculations, roaming considerations, and channel allocations.PlacementUse the following guidelines when considering placement options:1. The best placement option for the Array is ceiling-mounted within an open plan environment (cubicles rather than fixed walls).2. Keep the Array away from electrical devices or appliances that generate RF noise. Because the Array is generally mounted on ceilings, be aware of its position relative to lighting (especially fluorescent lighting)—we recommend maintaining a distance of at least 3 to 6 feet (1 to 2 meters).3. If using multiple Arrays in the same area, maintain a distance of at least 100 ft/30m between Arrays if there is direct line-of-sight between the units, or at least 50 ft/15m if a wall or other barrier exists between the units.Figure 9. Unit Placement100 ft/ 30m100 ft/ 30 m100 ft/30 m

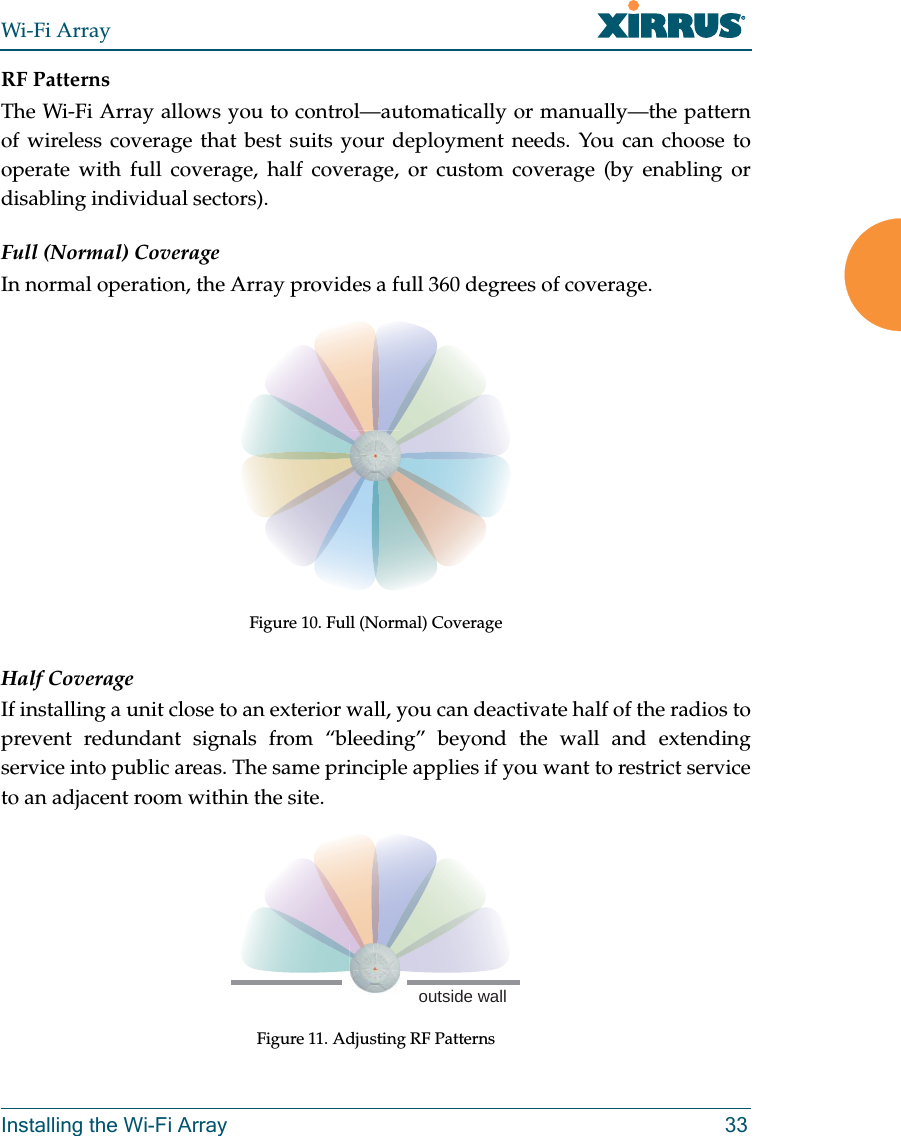

Wi-Fi ArrayInstalling the Wi-Fi Array 33RF PatternsThe Wi-Fi Array allows you to control—automatically or manually—the pattern of wireless coverage that best suits your deployment needs. You can choose to operate with full coverage, half coverage, or custom coverage (by enabling or disabling individual sectors).Full (Normal) CoverageIn normal operation, the Array provides a full 360 degrees of coverage.Figure 10. Full (Normal) CoverageHalf CoverageIf installing a unit close to an exterior wall, you can deactivate half of the radios to prevent redundant signals from “bleeding” beyond the wall and extending service into public areas. The same principle applies if you want to restrict service to an adjacent room within the site.Figure 11. Adjusting RF Patternsoutside wall

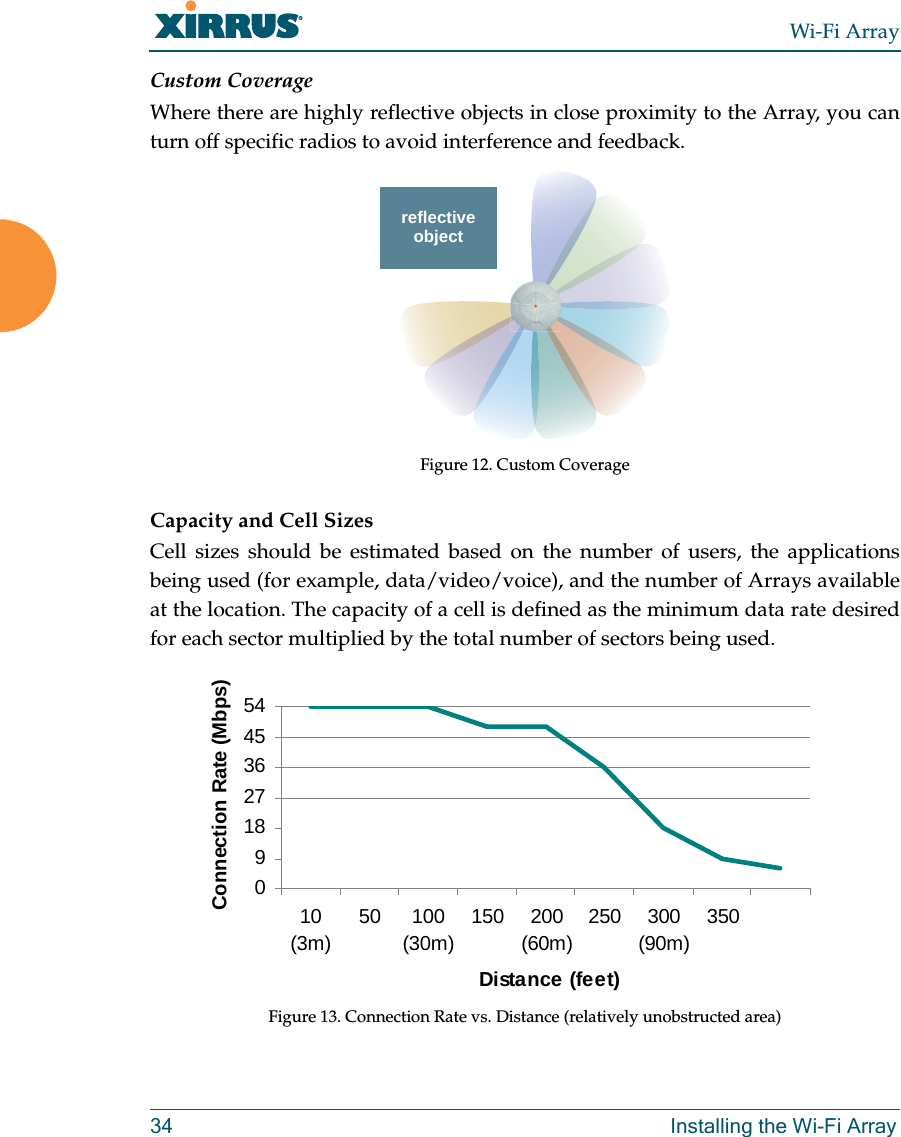

Wi-Fi Array34 Installing the Wi-Fi ArrayCustom CoverageWhere there are highly reflective objects in close proximity to the Array, you can turn off specific radios to avoid interference and feedback.Figure 12. Custom CoverageCapacity and Cell SizesCell sizes should be estimated based on the number of users, the applications being used (for example, data/video/voice), and the number of Arrays available at the location. The capacity of a cell is defined as the minimum data rate desired for each sector multiplied by the total number of sectors being used.Figure 13. Connection Rate vs. Distance (relatively unobstructed area)objectreflective09182736455410(3m)50 100(30m)150 200(60m)250 300(90m)350Distance (feet)Connection Rate (Mbps)

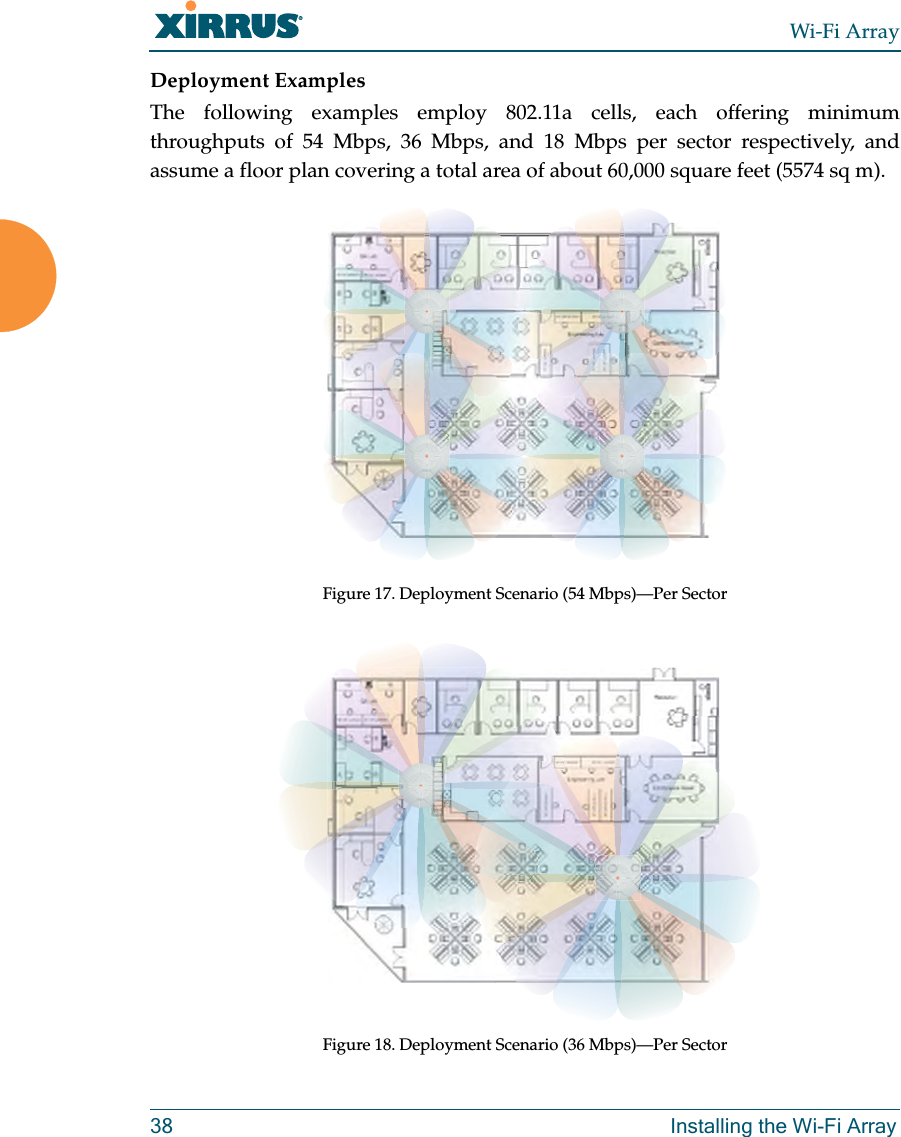

Wi-Fi ArrayInstalling the Wi-Fi Array 35Figure 13 shows some sample maximum connection rates for the XN8 and XN16 at different distances in an unobstructed area.  Wireless environments can vary greatly so the actual rates may be different depending on the specific network deployment. Fine Tuning Cell SizesAdjusting the transmit power allows you to fine tune cell sizes. There are four standard sizes—Small, Medium, Large, or Max (the default is Max). There is also an Auto setting that automatically determines the best cell size, and a Manual setting that allows you to choose your power settings directly. If you are installing many units in close proximity to each other, reduce the transmit power to avoid excessive interference with other Arrays or installed APs. See also, “Coverage and Capacity Planning” on page 32.Figure 14. Transmit PowerSharp CellThis feature available from the Web Management Interface reduces interference between neighboring Wi-Fi Arrays or other Access Points by limiting to a defined #The XN4 has a smaller range than the larger Arrays. The distance is about 80% of the values shown in Figure 13 above. Thus the maximum cell size is about 64% of the coverage area in the chart.LargeMediumSmall

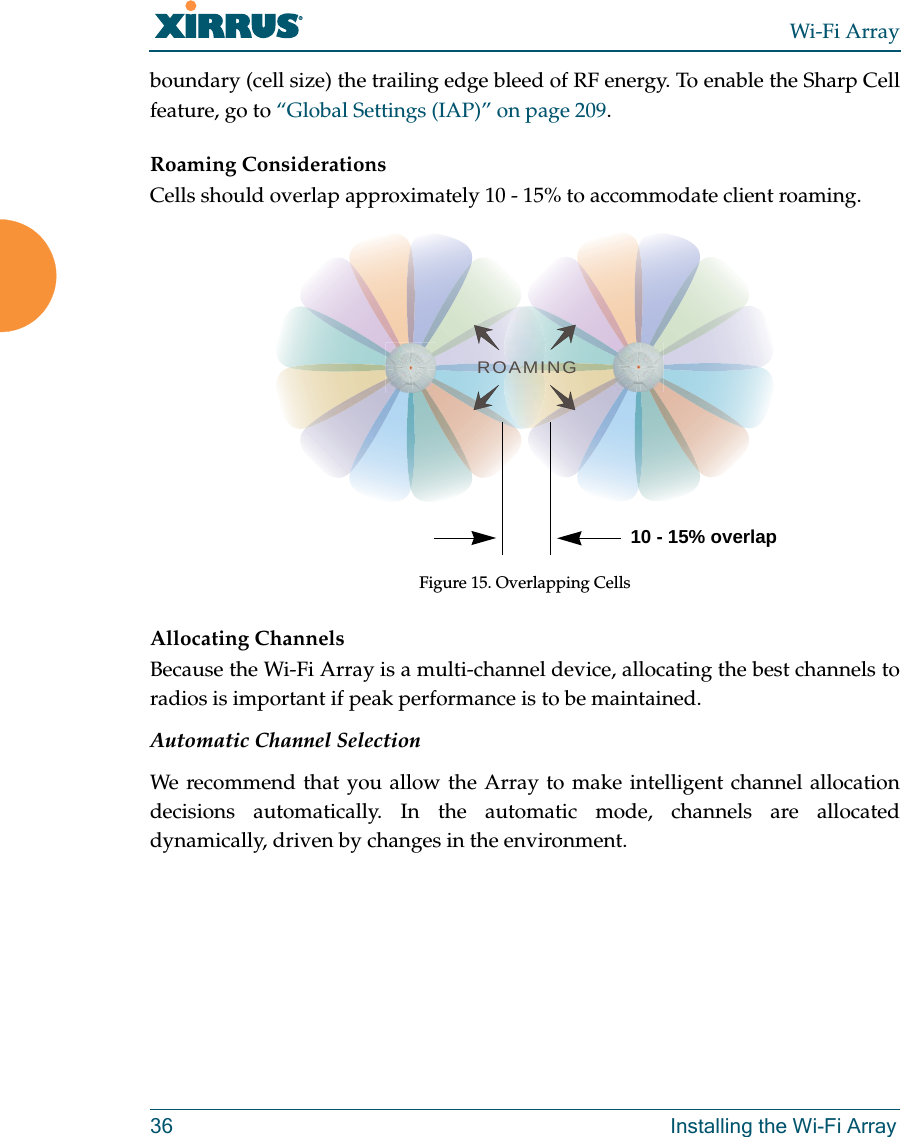

Wi-Fi Array36 Installing the Wi-Fi Arrayboundary (cell size) the trailing edge bleed of RF energy. To enable the Sharp Cell feature, go to “Global Settings (IAP)” on page 209. Roaming ConsiderationsCells should overlap approximately 10 - 15% to accommodate client roaming.Figure 15. Overlapping CellsAllocating ChannelsBecause the Wi-Fi Array is a multi-channel device, allocating the best channels to radios is important if peak performance is to be maintained.Automatic Channel SelectionWe recommend that you allow the Array to make intelligent channel allocation decisions automatically. In the automatic mode, channels are allocated dynamically, driven by changes in the environment.ROAMING10 - 15% overlap

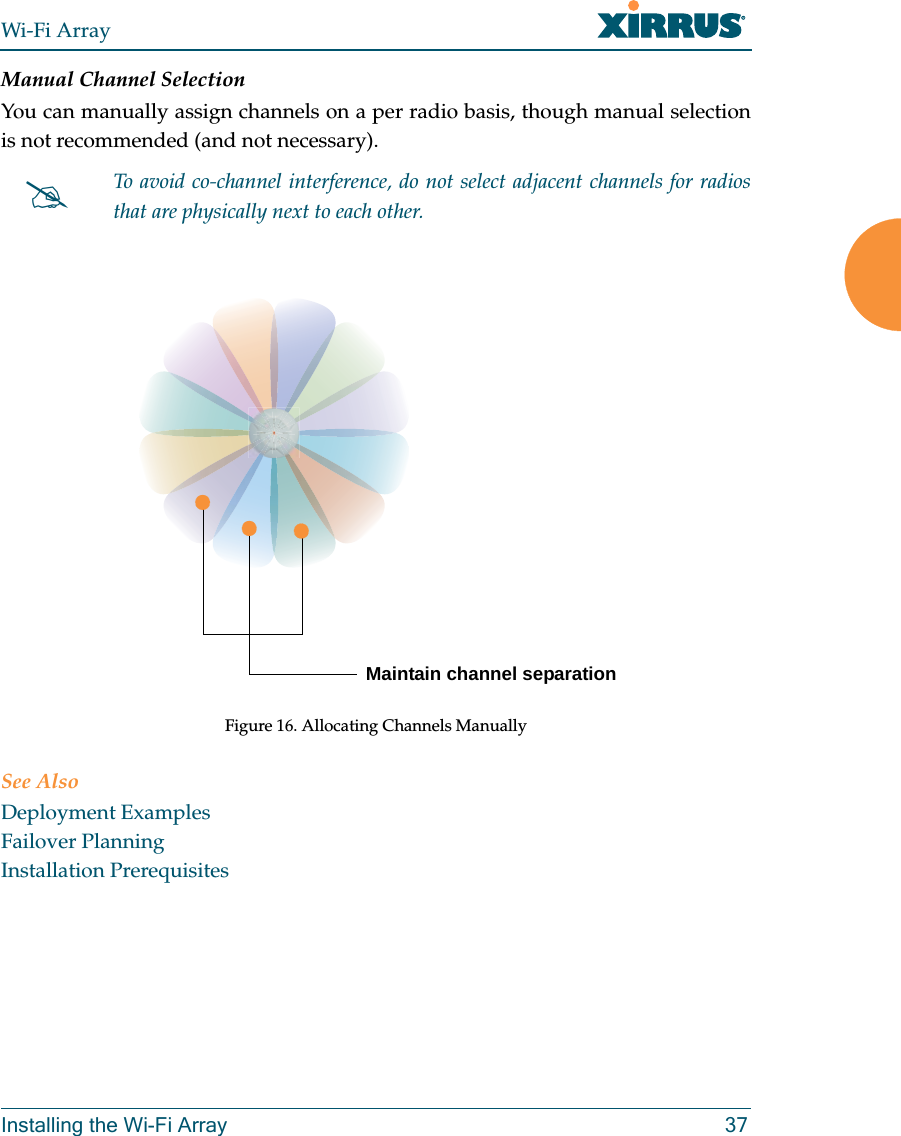

Wi-Fi ArrayInstalling the Wi-Fi Array 37Manual Channel SelectionYou can manually assign channels on a per radio basis, though manual selection is not recommended (and not necessary).Figure 16. Allocating Channels ManuallySee AlsoDeployment ExamplesFailover PlanningInstallation Prerequisites#To avoid co-channel interference, do not select adjacent channels for radios that are physically next to each other.Maintain channel separation
Wi-Fi Array38 Installing the Wi-Fi ArrayDeployment ExamplesThe following examples employ 802.11a cells, each offering minimum throughputs of 54 Mbps, 36 Mbps, and 18 Mbps per sector respectively, and assume a floor plan covering a total area of about 60,000 square feet (5574 sq m).Figure 17. Deployment Scenario (54 Mbps)—Per SectorFigure 18. Deployment Scenario (36 Mbps)—Per Sector

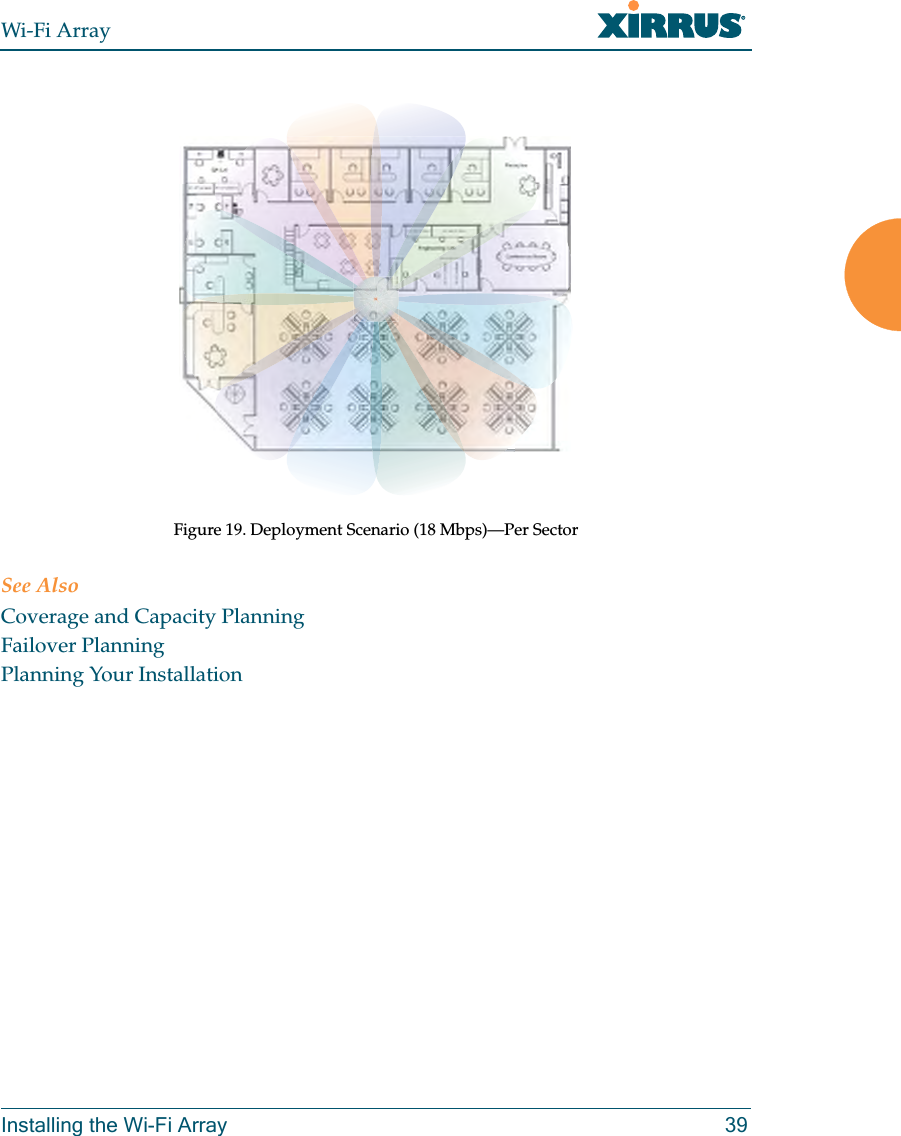

Wi-Fi ArrayInstalling the Wi-Fi Array 39Figure 19. Deployment Scenario (18 Mbps)—Per SectorSee AlsoCoverage and Capacity PlanningFailover PlanningPlanning Your Installation

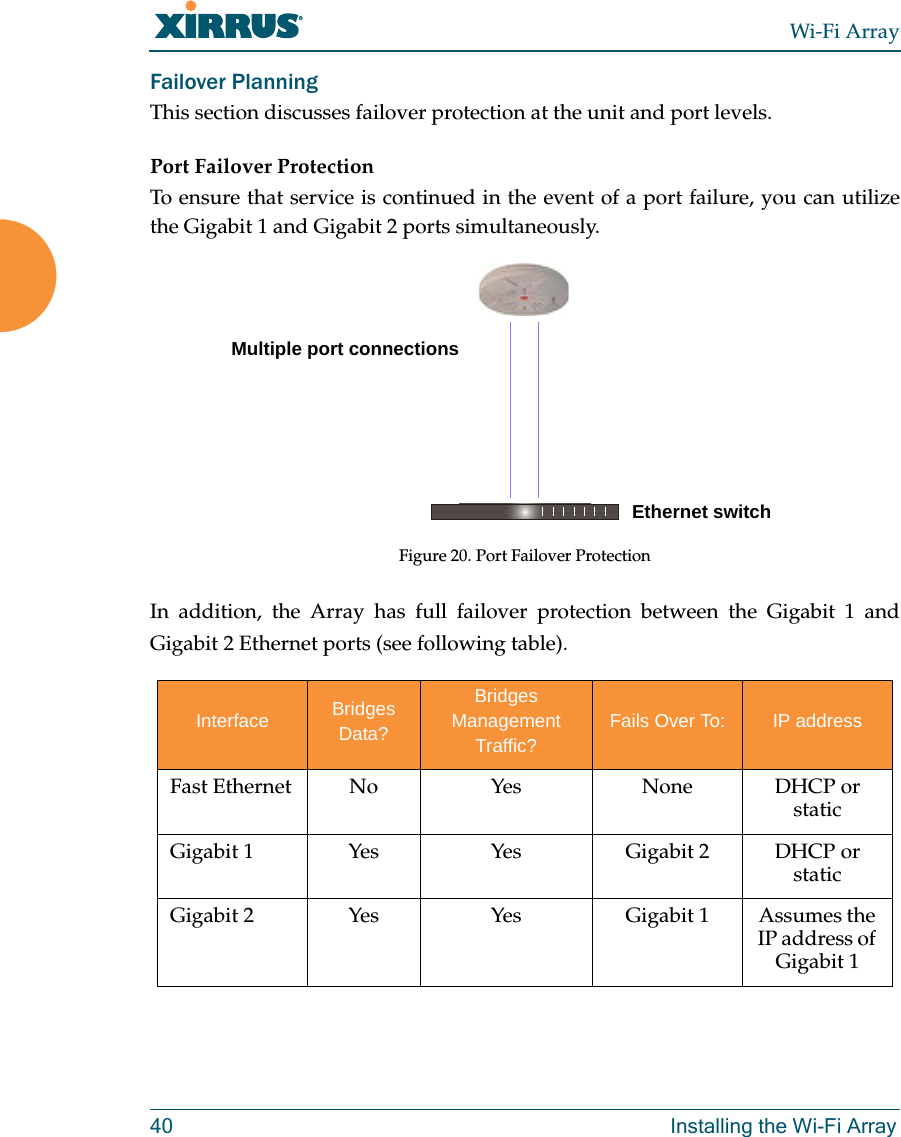

Wi-Fi Array40 Installing the Wi-Fi ArrayFailover PlanningThis section discusses failover protection at the unit and port levels.Port Failover ProtectionTo ensure that service is continued in the event of a port failure, you can utilize the Gigabit 1 and Gigabit 2 ports simultaneously.Figure 20. Port Failover ProtectionIn addition, the Array has full failover protection between the Gigabit 1 and Gigabit 2 Ethernet ports (see following table).Interface Bridges Data?Bridges Management Traffic?Fails Over To: IP addressFast Ethernet No Yes None DHCP or staticGigabit 1 Yes Yes Gigabit 2 DHCP or staticGigabit 2 Yes Yes Gigabit 1 Assumes the IP address of Gigabit 1Ethernet switchMultiple port connections

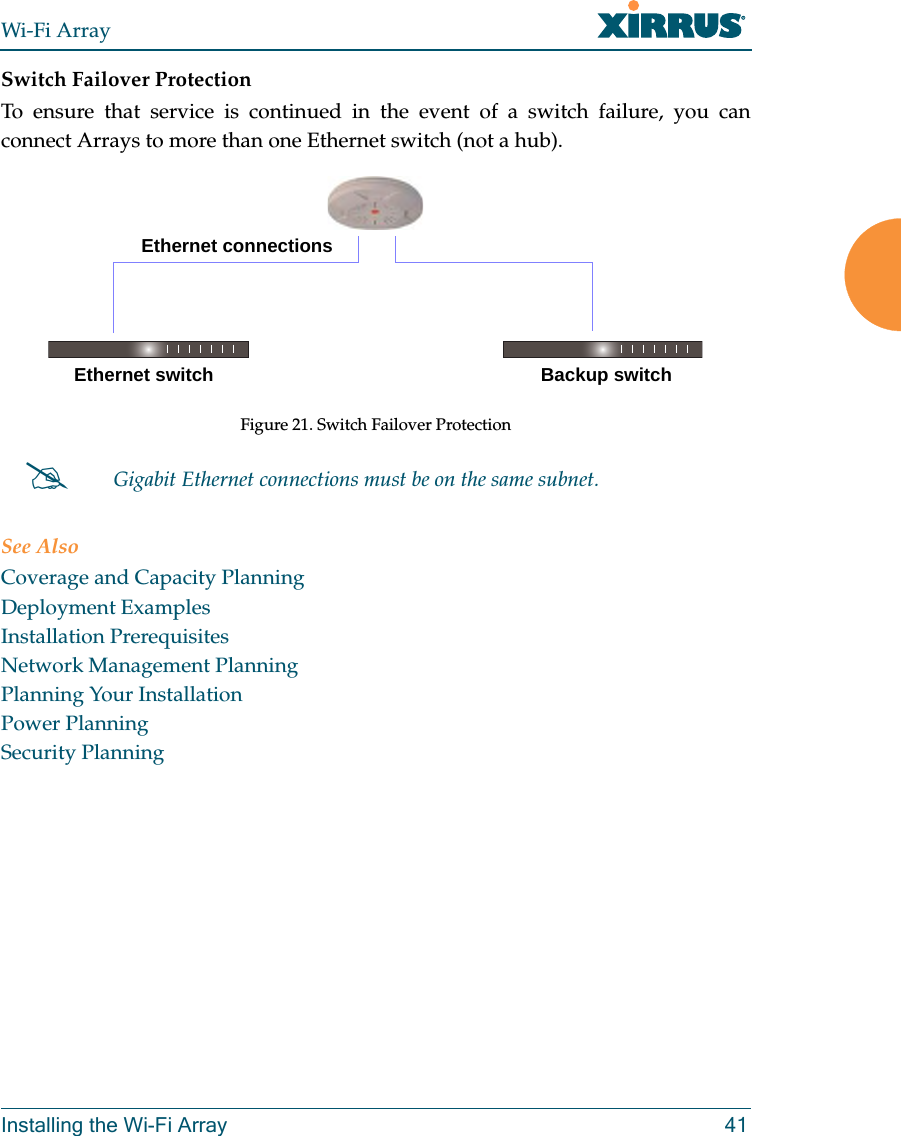

Wi-Fi ArrayInstalling the Wi-Fi Array 41Switch Failover ProtectionTo ensure that service is continued in the event of a switch failure, you can connect Arrays to more than one Ethernet switch (not a hub).Figure 21. Switch Failover ProtectionSee AlsoCoverage and Capacity PlanningDeployment ExamplesInstallation PrerequisitesNetwork Management PlanningPlanning Your InstallationPower PlanningSecurity Planning#Gigabit Ethernet connections must be on the same subnet.Ethernet switch Backup switchEthernet connections

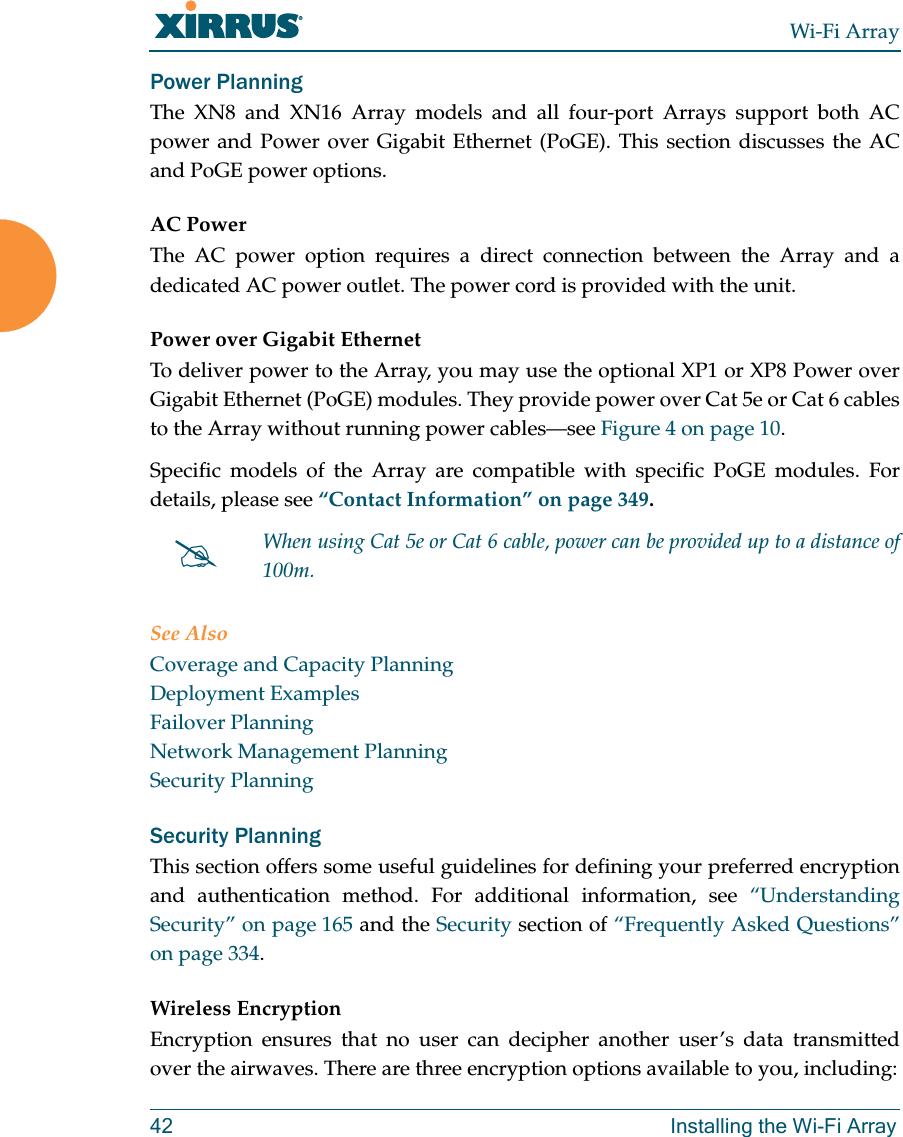

Wi-Fi Array42 Installing the Wi-Fi ArrayPower PlanningThe XN8 and XN16 Array models and all four-port Arrays support both AC power and Power over Gigabit Ethernet (PoGE). This section discusses the AC and PoGE power options.AC PowerThe AC power option requires a direct connection between the Array and a dedicated AC power outlet. The power cord is provided with the unit.Power over Gigabit EthernetTo deliver power to the Array, you may use the optional XP1 or XP8 Power over Gigabit Ethernet (PoGE) modules. They provide power over Cat 5e or Cat 6 cables to the Array without running power cables—see Figure 4 on page 10. Specific models of the Array are compatible with specific PoGE modules. For details, please see “Contact Information” on page 349. See AlsoCoverage and Capacity PlanningDeployment ExamplesFailover PlanningNetwork Management PlanningSecurity PlanningSecurity PlanningThis section offers some useful guidelines for defining your preferred encryption and authentication method. For additional information, see “Understanding Security” on page 165 and the Security section of “Frequently Asked Questions” on page 334.Wireless EncryptionEncryption ensures that no user can decipher another user’s data transmitted over the airwaves. There are three encryption options available to you, including:#When using Cat 5e or Cat 6 cable, power can be provided up to a distance of 100m.

Wi-Fi ArrayInstalling the Wi-Fi Array 43zWEP-40bit or WEP-128bitBecause WEP is vulnerable to cracks, we recommend that you only use this for legacy devices that cannot support a stronger encryption type.zWi-Fi Protected Access (WPA)This is much more secure than WEP and uses TKIP for encryption.zWi-Fi Protected Access (WPA2) with AES This is government-grade encryption—available on most new client adapters—and uses the AES–CCM encryption mode (Advanced Encryption Standard–Counter Mode).AuthenticationAuthentication ensures users are who they say they are, and occurs when users attempt to join the wireless network and periodically thereafter. The following authentication methods are available with the Wi-Fi Array:zRADIUS 802.1x 802.1x uses a remote RADIUS server to authenticate large numbers of clients, and can handle different authentication methods (EAP-TLS, EAP-TTLS, EAP-PEAP, and EAP-LEAP Passthrough).zXirrus Internal RADIUS serverRecommended for smaller numbers of users (about 100 or less). Supports EAP-PEAP onlyzPre-Shared KeyUses a pass-phrase or key that is manually distributed to all authorized users. The same passphrase is given to client devices and entered into each Array.zMAC Access Control Lists (ACLs)MAC access control lists provide a list of client adapter MAC addresses that are allowed or denied access to the wireless network, and can be used in addition to any of the above authentication methods. ACLs are good for embedded devices, like printers and bar-code scanners (though MAC addresses can be spoofed). The Wi-Fi Array supports 1,000 ACL entries.
Wi-Fi Array44 Installing the Wi-Fi ArraySee AlsoFailover PlanningNetwork Management PlanningPower Planning

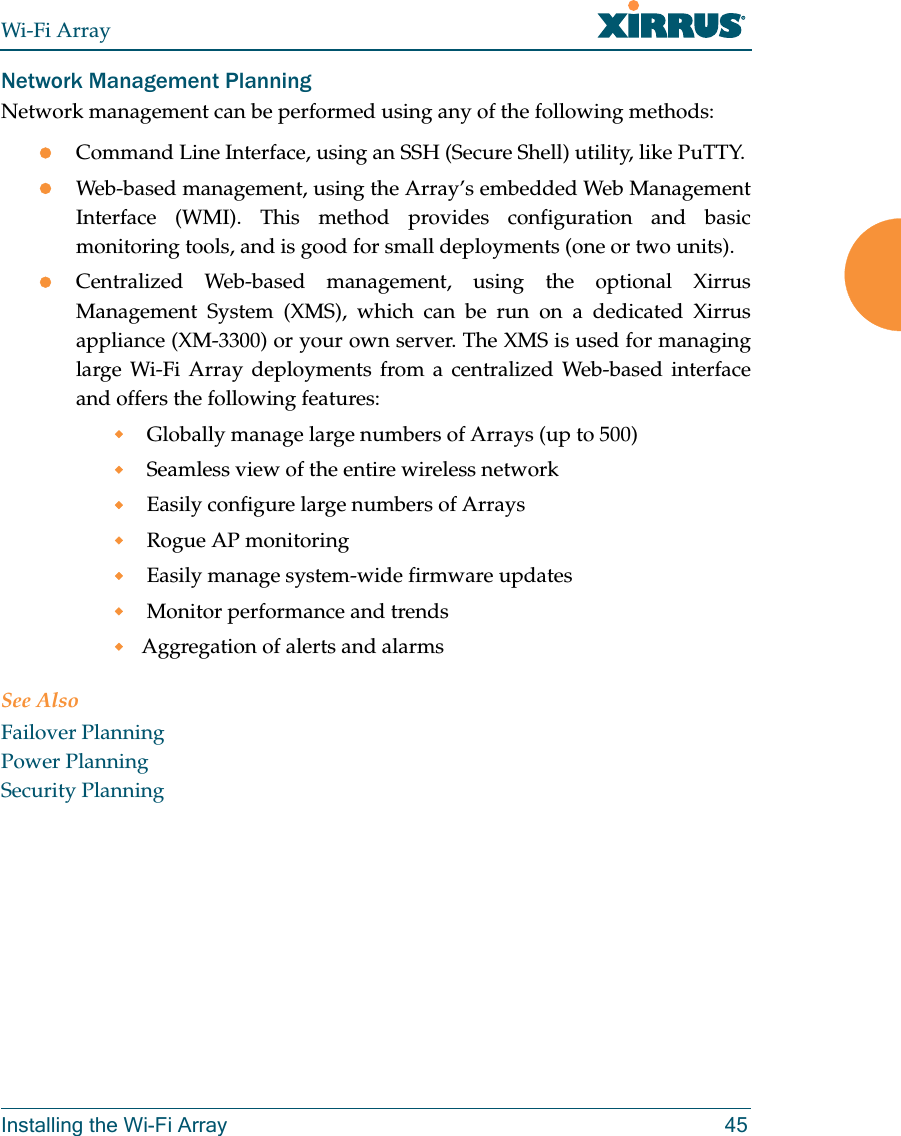

Wi-Fi ArrayInstalling the Wi-Fi Array 45Network Management PlanningNetwork management can be performed using any of the following methods:zCommand Line Interface, using an SSH (Secure Shell) utility, like PuTTY.zWeb-based management, using the Array’s embedded Web Management Interface (WMI). This method provides configuration and basic monitoring tools, and is good for small deployments (one or two units).zCentralized Web-based management, using the optional Xirrus Management System (XMS), which can be run on a dedicated Xirrus appliance (XM-3300) or your own server. The XMS is used for managing large Wi-Fi Array deployments from a centralized Web-based interface and offers the following features: Globally manage large numbers of Arrays (up to 500) Seamless view of the entire wireless network Easily configure large numbers of Arrays  Rogue AP monitoring Easily manage system-wide firmware updates  Monitor performance and trendsAggregation of alerts and alarmsSee AlsoFailover PlanningPower PlanningSecurity Planning

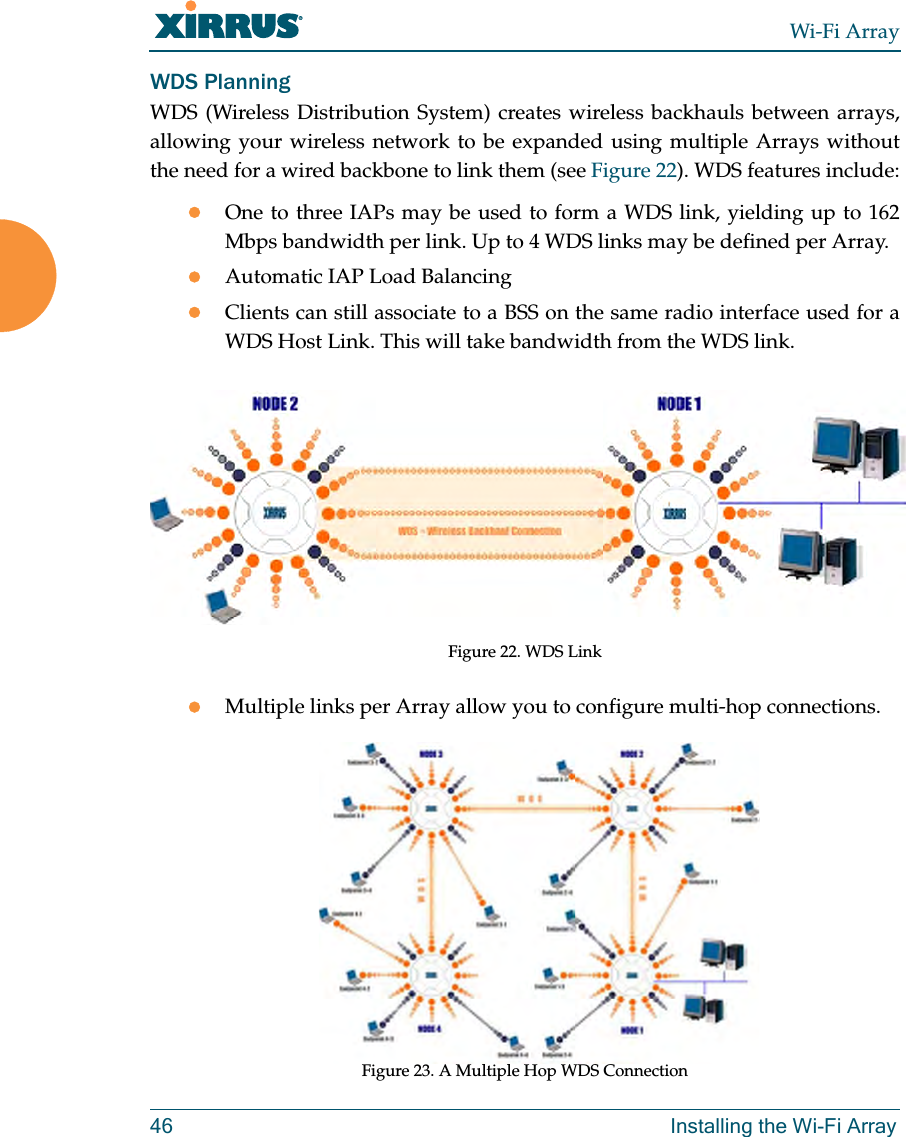

Wi-Fi Array46 Installing the Wi-Fi ArrayWDS PlanningWDS (Wireless Distribution System) creates wireless backhauls between arrays, allowing your wireless network to be expanded using multiple Arrays without the need for a wired backbone to link them (see Figure 22). WDS features include:zOne to three IAPs may be used to form a WDS link, yielding up to 162 Mbps bandwidth per link. Up to 4 WDS links may be defined per Array.zAutomatic IAP Load Balancing zClients can still associate to a BSS on the same radio interface used for a WDS Host Link. This will take bandwidth from the WDS link. Figure 22. WDS LinkzMultiple links per Array allow you to configure multi-hop connections.Figure 23. A Multiple Hop WDS Connection

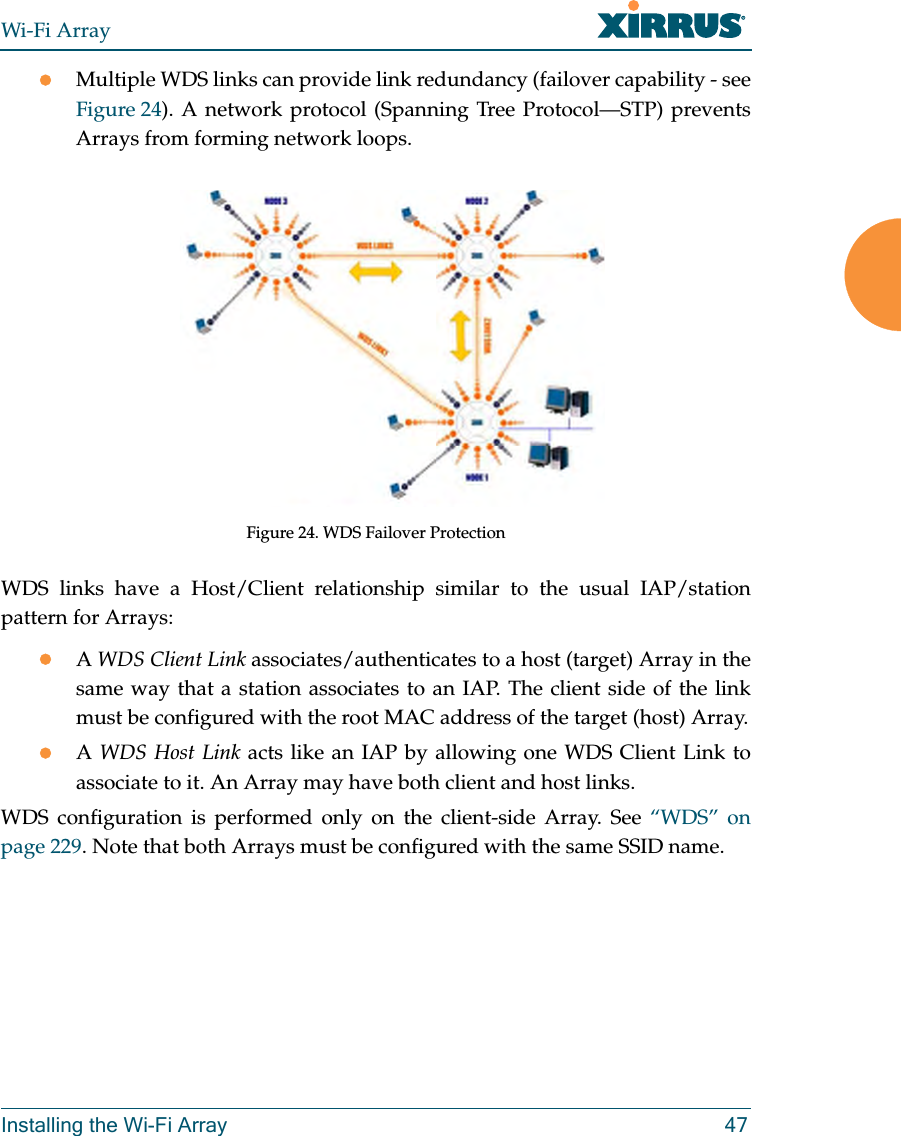

Wi-Fi ArrayInstalling the Wi-Fi Array 47zMultiple WDS links can provide link redundancy (failover capability - see Figure 24). A network protocol (Spanning Tree Protocol—STP) prevents Arrays from forming network loops. Figure 24. WDS Failover ProtectionWDS links have a Host/Client relationship similar to the usual IAP/station pattern for Arrays:zA WDS Client Link associates/authenticates to a host (target) Array in the same way that a station associates to an IAP. The client side of the link must be configured with the root MAC address of the target (host) Array.zA WDS Host Link acts like an IAP by allowing one WDS Client Link to associate to it. An Array may have both client and host links.WDS configuration is performed only on the client-side Array. See “WDS” on page 229. Note that both Arrays must be configured with the same SSID name.

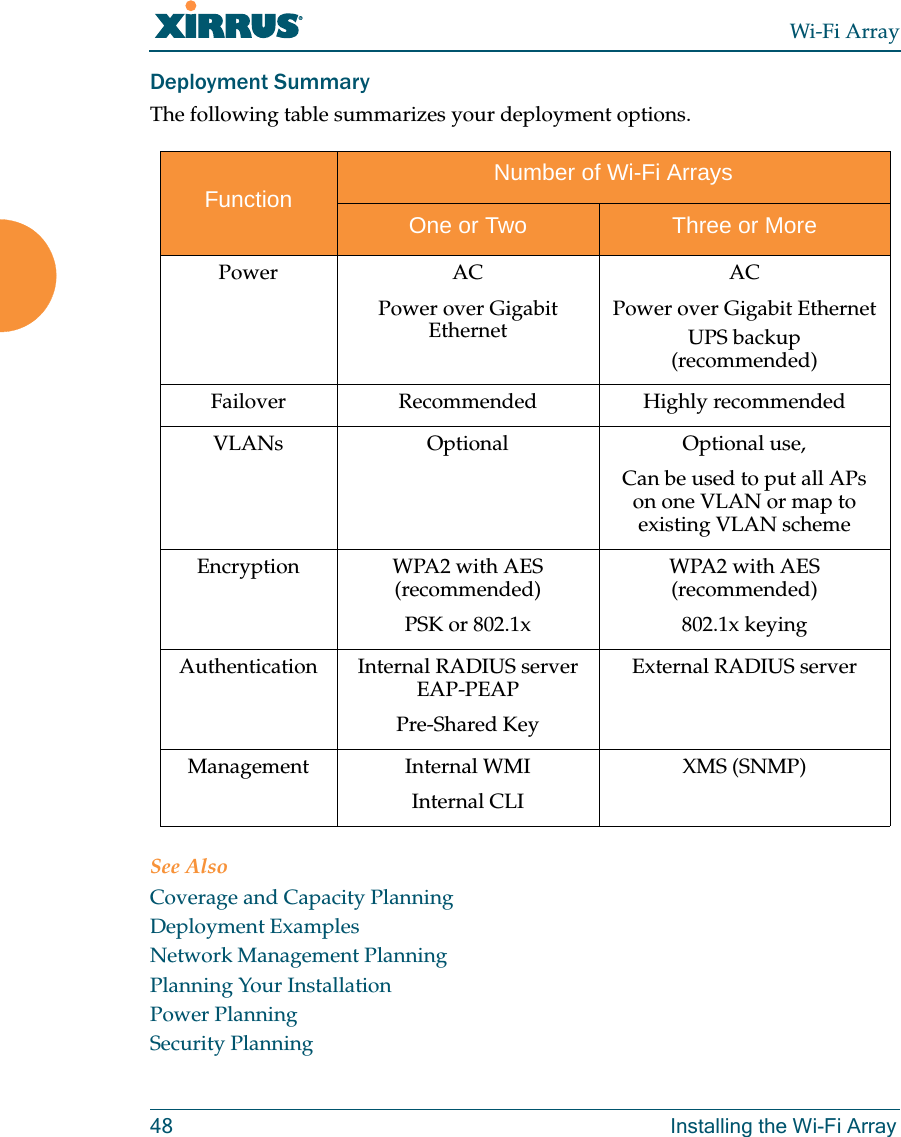

Wi-Fi Array48 Installing the Wi-Fi ArrayDeployment SummaryThe following table summarizes your deployment options.See AlsoCoverage and Capacity PlanningDeployment ExamplesNetwork Management PlanningPlanning Your InstallationPower PlanningSecurity PlanningFunction Number of Wi-Fi ArraysOne or Two Three or MorePower ACPower over Gigabit EthernetACPower over Gigabit EthernetUPS backup(recommended)Failover Recommended Highly recommendedVLANs Optional Optional use,Can be used to put all APs on one VLAN or map to existing VLAN schemeEncryption WPA2 with AES (recommended)PSK or 802.1x WPA2 with AES (recommended)802.1x keyingAuthentication Internal RADIUS serverEAP-PEAPPre-Shared KeyExternal RADIUS serverManagement Internal WMIInternal CLIXMS (SNMP)

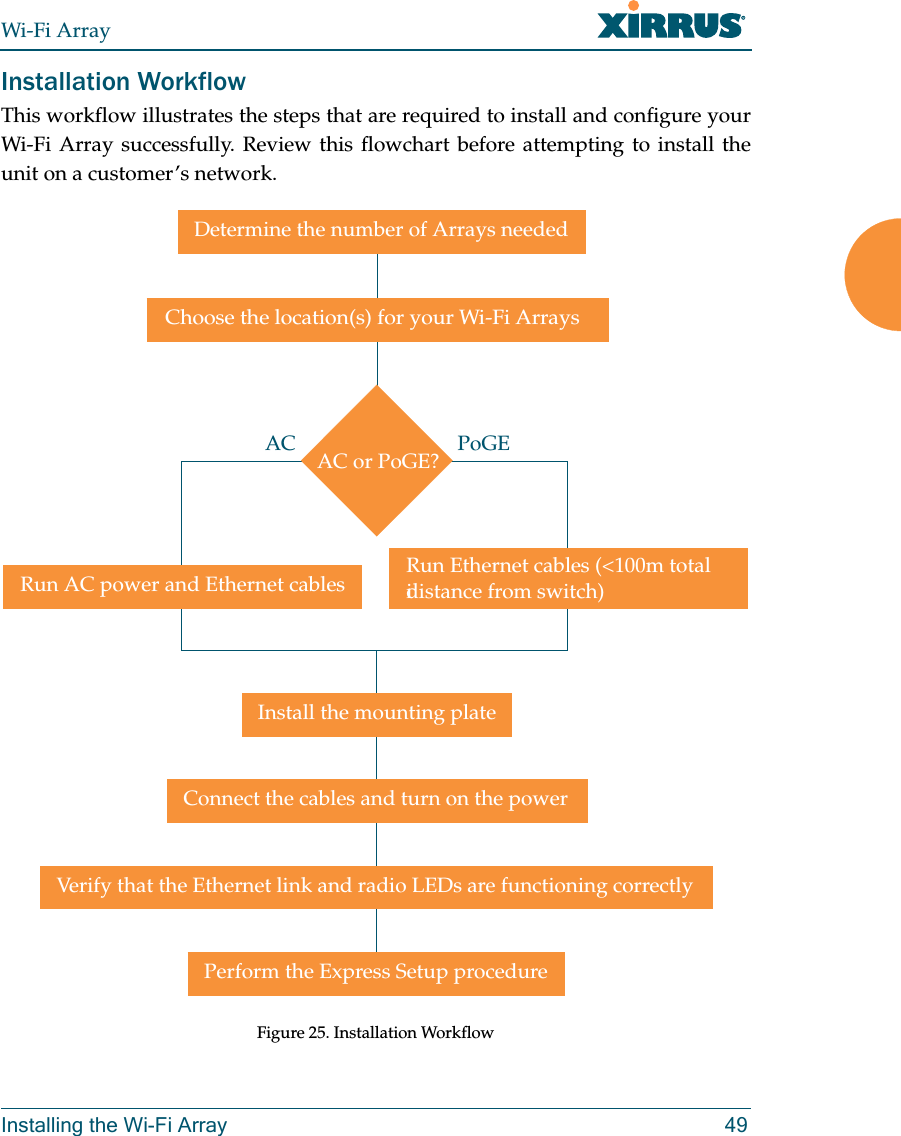

Wi-Fi ArrayInstalling the Wi-Fi Array 49Installation WorkflowThis workflow illustrates the steps that are required to install and configure your Wi-Fi Array successfully. Review this flowchart before attempting to install the unit on a customer’s network.Figure 25. Installation WorkflowDetermine the number of Arrays neededChoose the location(s) for your Wi-Fi ArraysAC PoGEInstall the mounting plateConnect the cables and turn on the powerVerify that the Ethernet link and radio LEDs are functioning correctlyPerform the Express Setup procedureRun AC power and Ethernet cables Run Ethernet cables (<100m total AC or PoGE?idistance from switch)

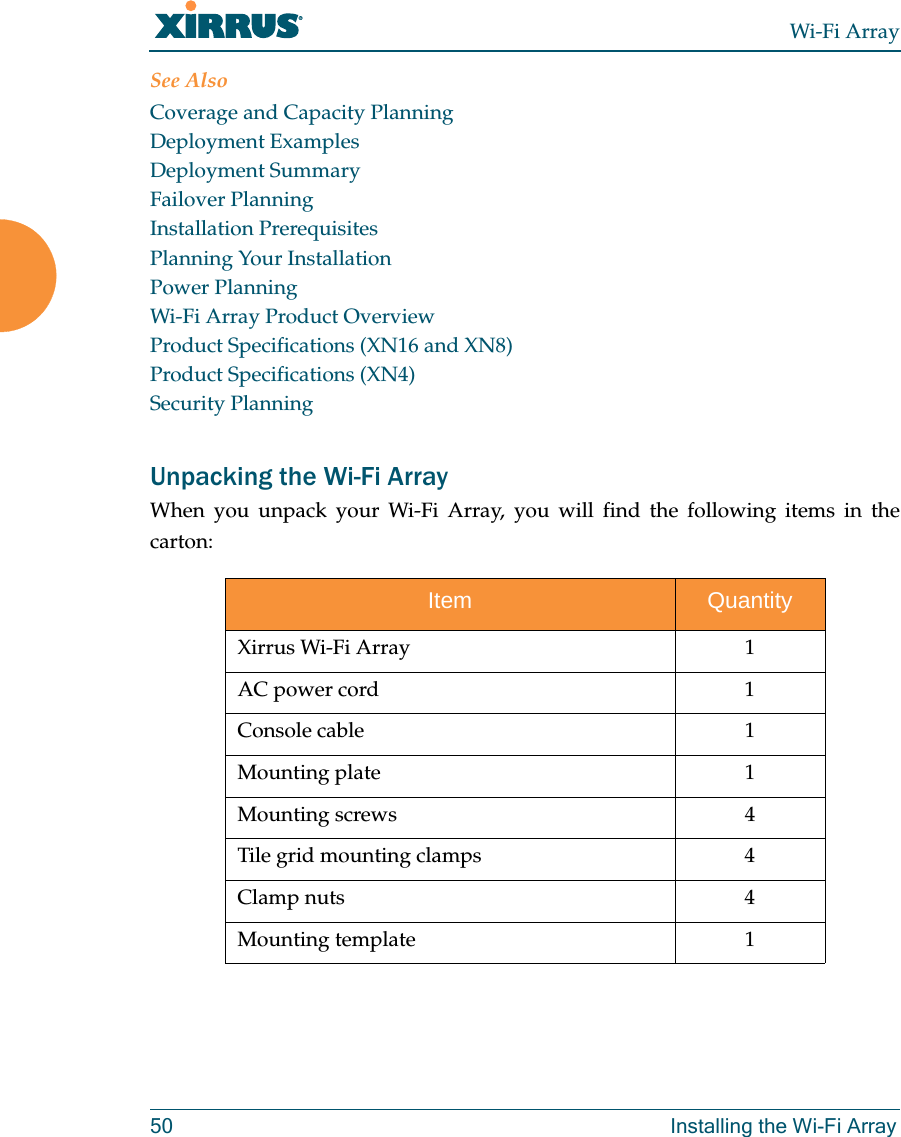

Wi-Fi Array50 Installing the Wi-Fi ArraySee AlsoCoverage and Capacity PlanningDeployment ExamplesDeployment SummaryFailover PlanningInstallation PrerequisitesPlanning Your InstallationPower PlanningWi-Fi Array Product OverviewProduct Specifications (XN16 and XN8)Product Specifications (XN4)Security PlanningUnpacking the Wi-Fi ArrayWhen you unpack your Wi-Fi Array, you will find the following items in the carton: Item QuantityXirrus Wi-Fi Array 1AC power cord 1Console cable 1Mounting plate 1Mounting screws 4Tile grid mounting clamps 4Clamp nuts 4Mounting template 1

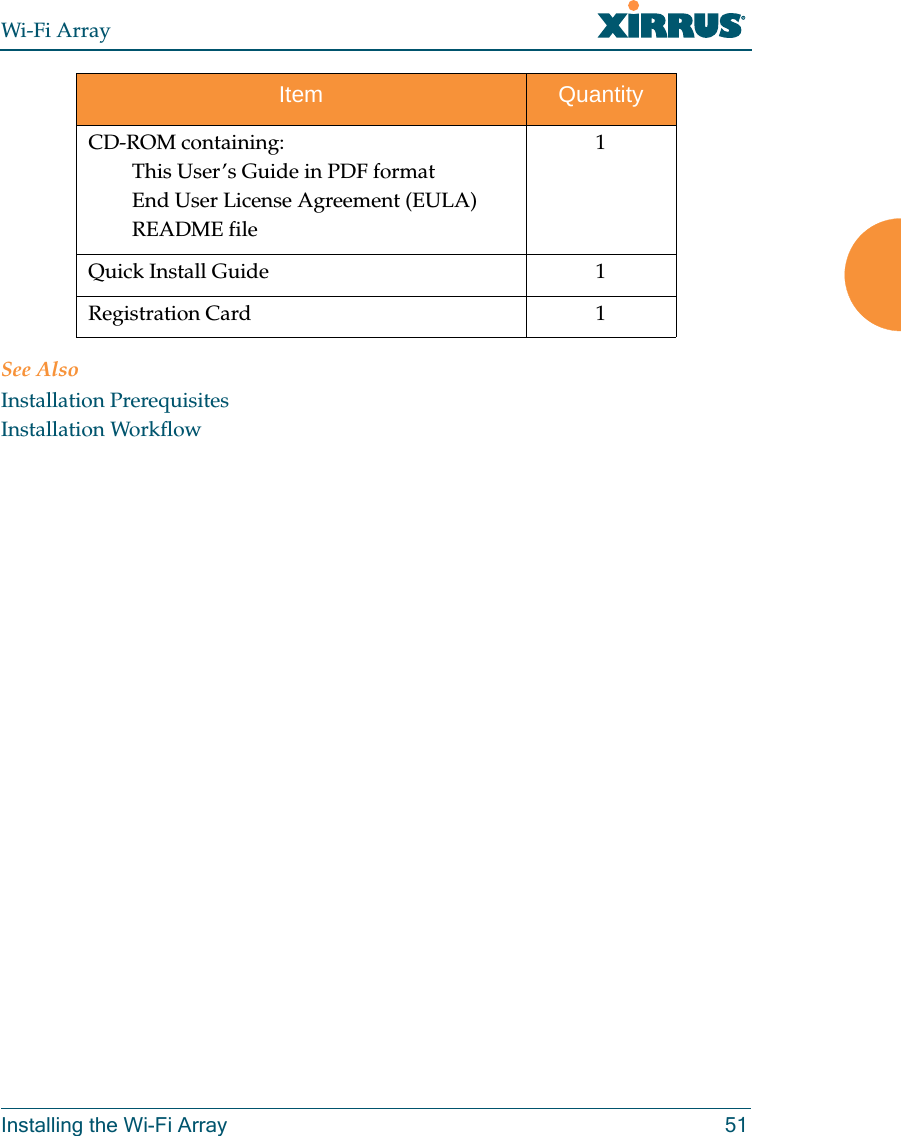

Wi-Fi ArrayInstalling the Wi-Fi Array 51See AlsoInstallation PrerequisitesInstallation WorkflowCD-ROM containing:This User’s Guide in PDF formatEnd User License Agreement (EULA)README file1Quick Install Guide 1Registration Card 1Item Quantity

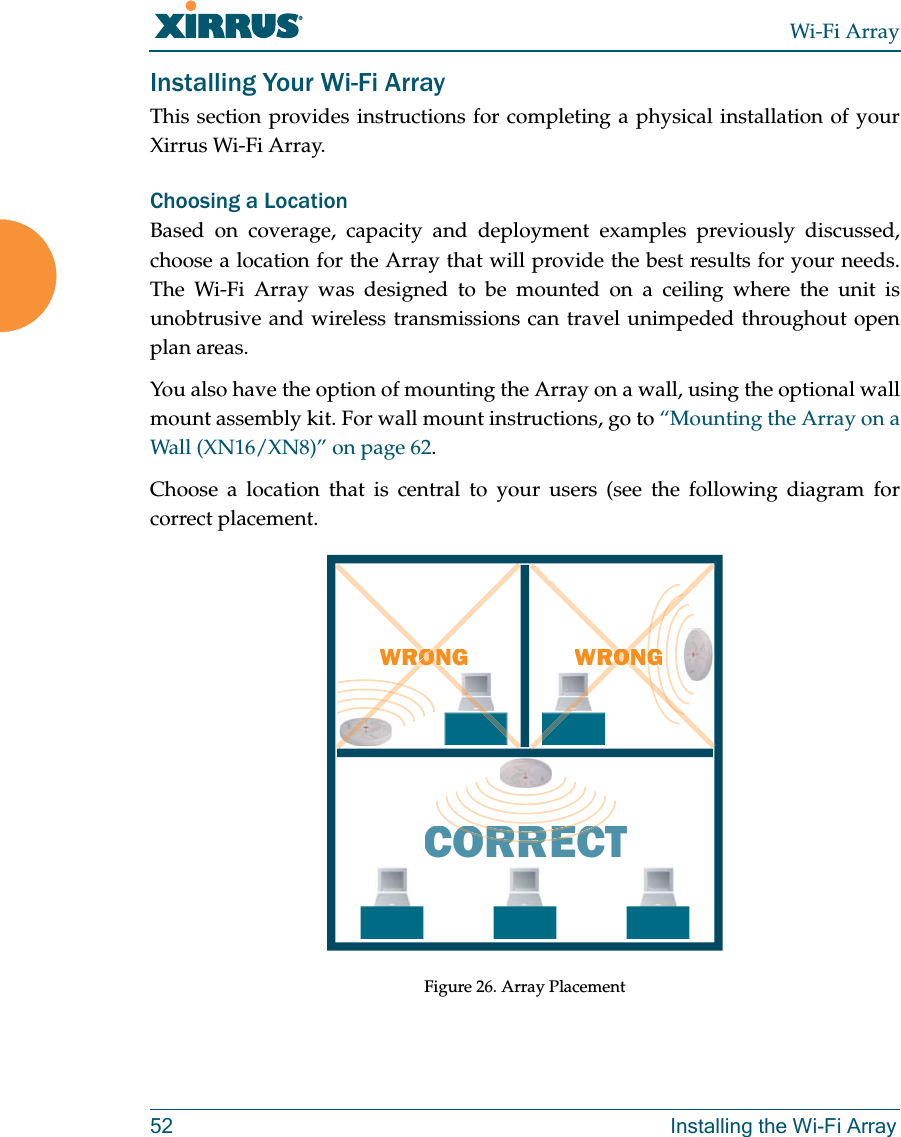

Wi-Fi Array52 Installing the Wi-Fi ArrayInstalling Your Wi-Fi ArrayThis section provides instructions for completing a physical installation of your Xirrus Wi-Fi Array.Choosing a LocationBased on coverage, capacity and deployment examples previously discussed,choose a location for the Array that will provide the best results for your needs. The Wi-Fi Array was designed to be mounted on a ceiling where the unit is unobtrusive and wireless transmissions can travel unimpeded throughout open plan areas.You also have the option of mounting the Array on a wall, using the optional wall mount assembly kit. For wall mount instructions, go to “Mounting the Array on a Wall (XN16/XN8)” on page 62.Choose a location that is central to your users (see the following diagram for correct placement.Figure 26. Array PlacementWRONGCORRECTRORRERORRECWRONGGGOONRORONONRORON

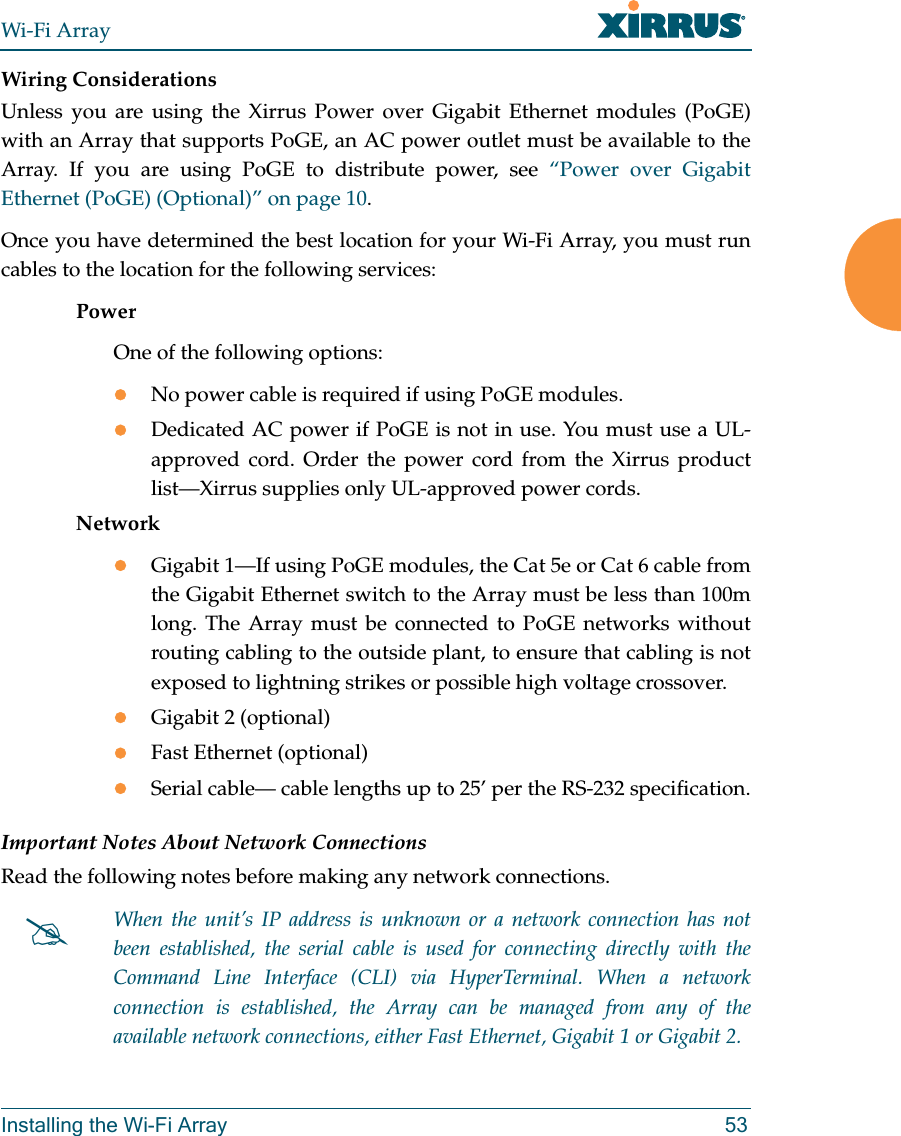

Wi-Fi ArrayInstalling the Wi-Fi Array 53Wiring ConsiderationsUnless you are using the Xirrus Power over Gigabit Ethernet modules (PoGE) with an Array that supports PoGE, an AC power outlet must be available to the Array. If you are using PoGE to distribute power, see “Power over Gigabit Ethernet (PoGE) (Optional)” on page 10.Once you have determined the best location for your Wi-Fi Array, you must run cables to the location for the following services:PowerOne of the following options:zNo power cable is required if using PoGE modules. zDedicated AC power if PoGE is not in use. You must use a UL-approved cord. Order the power cord from the Xirrus product list—Xirrus supplies only UL-approved power cords. NetworkzGigabit 1—If using PoGE modules, the Cat 5e or Cat 6 cable from the Gigabit Ethernet switch to the Array must be less than 100m long. The Array must be connected to PoGE networks without routing cabling to the outside plant, to ensure that cabling is not exposed to lightning strikes or possible high voltage crossover.zGigabit 2 (optional)zFast Ethernet (optional)zSerial cable— cable lengths up to 25’ per the RS-232 specification.Important Notes About Network ConnectionsRead the following notes before making any network connections.#When the unit’s IP address is unknown or a network connection has not been established, the serial cable is used for connecting directly with the Command Line Interface (CLI) via HyperTerminal. When a network connection is established, the Array can be managed from any of the available network connections, either Fast Ethernet, Gigabit 1 or Gigabit 2.
Wi-Fi Array54 Installing the Wi-Fi ArraySee AlsoFailover PlanningInstallation PrerequisitesInstallation WorkflowMounting the Wi-Fi Array on a Wall (XN4)Mounting the Array on a Wall (XN16/XN8)Mounting the Array on a CeilingPower over Gigabit Ethernet (PoGE) (Optional)Unpacking the Wi-Fi ArrayMounting the Array on a CeilingMost offices have drop-down acoustical ceiling tiles set into a standard grid. The Wi-Fi Array has been designed to enable mounting to a tiled ceiling via a mounting plate and clamps that attach to the grid. Once the mounting plate is attached, the Array simply rotates onto the plate (similar to a smoke detector). Once the unit is mounted it can be removed and re-attached easily, without the need for tools or modifications to the original installation.This section assumes that you are mounting the Array to a tiled ceiling. If your ceiling is not tiled, the mounting plate can be attached directly to the ceiling with the screws and anchors provided (without using the tile grid mounting clamps).!The Array’s Ethernet ports should be plugged into an Ethernet switch, not an Ethernet hub—if a hub is used, we recommend that you connect only one Ethernet port.!The Gigabit1 Ethernet interface is the primary port for both data and management traffic. If a single Ethernet connection is used, it must be connected to the Gigabit1 Ethernet interface. See also, “Port Failover Protection” on page 40.The 10/100 Ethernet Port may be used for managing the Array out of band from the Gigabit Ethernet ports. The 10/100 port will route only management traffic, using a static route that may be configured for this interface. See “interface” on page 273.

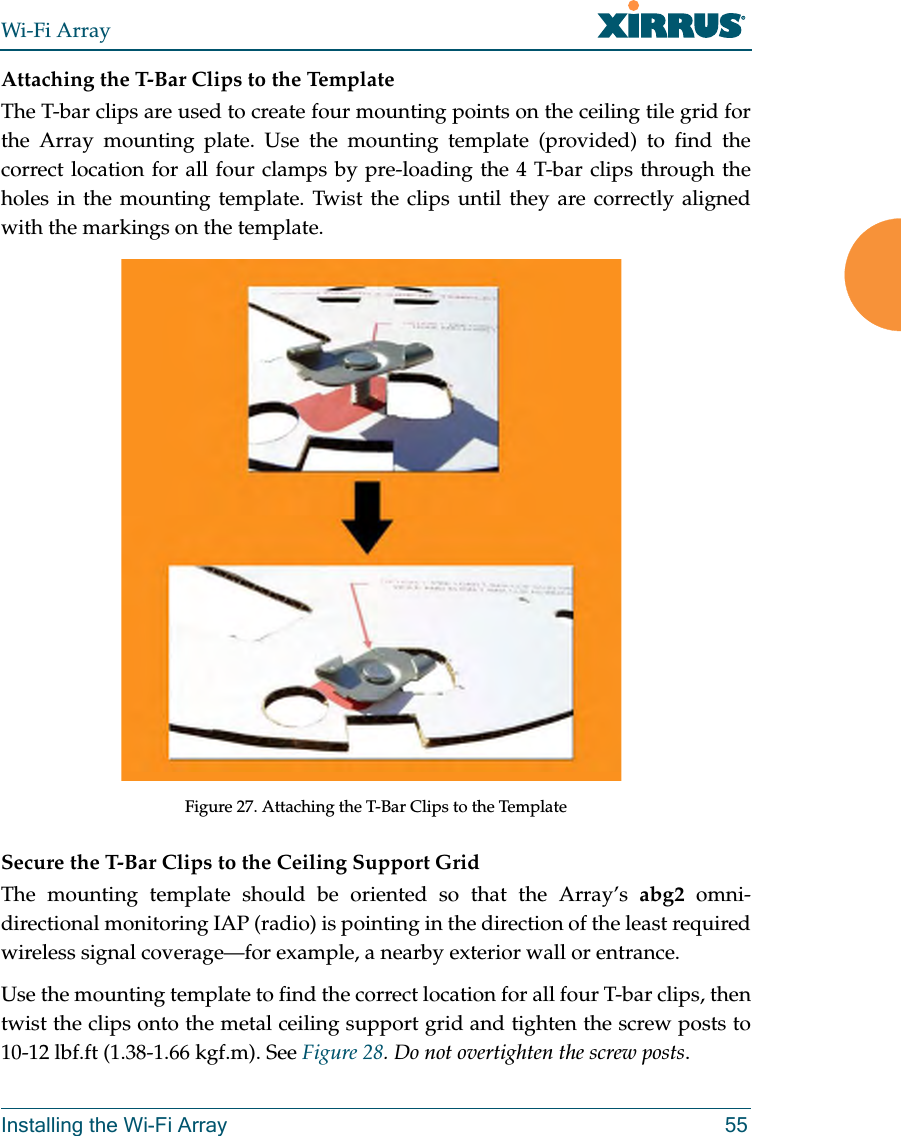

Wi-Fi ArrayInstalling the Wi-Fi Array 55Attaching the T-Bar Clips to the TemplateThe T-bar clips are used to create four mounting points on the ceiling tile grid for the Array mounting plate. Use the mounting template (provided) to find the correct location for all four clamps by pre-loading the 4 T-bar clips through the holes in the mounting template. Twist the clips until they are correctly aligned with the markings on the template.Figure 27. Attaching the T-Bar Clips to the Template Secure the T-Bar Clips to the Ceiling Support GridThe mounting template should be oriented so that the Array’s abg2 omni-directional monitoring IAP (radio) is pointing in the direction of the least required wireless signal coverage—for example, a nearby exterior wall or entrance.Use the mounting template to find the correct location for all four T-bar clips, then twist the clips onto the metal ceiling support grid and tighten the screw posts to 10-12 lbf.ft (1.38-1.66 kgf.m). See Figure 28. Do not overtighten the screw posts.

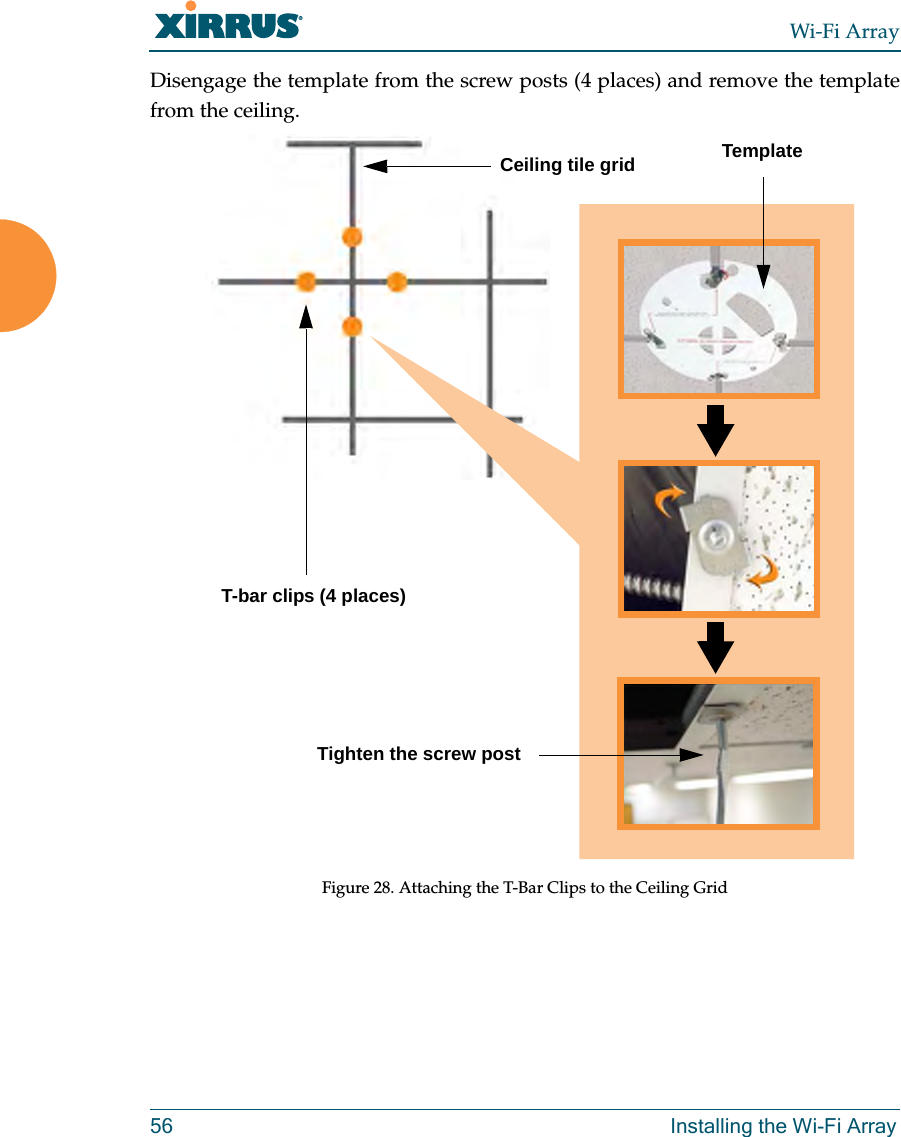

Wi-Fi Array56 Installing the Wi-Fi ArrayDisengage the template from the screw posts (4 places) and remove the template from the ceiling.Figure 28. Attaching the T-Bar Clips to the Ceiling GridCeiling tile gridT-bar clips (4 places)Tighten the screw postTemplate

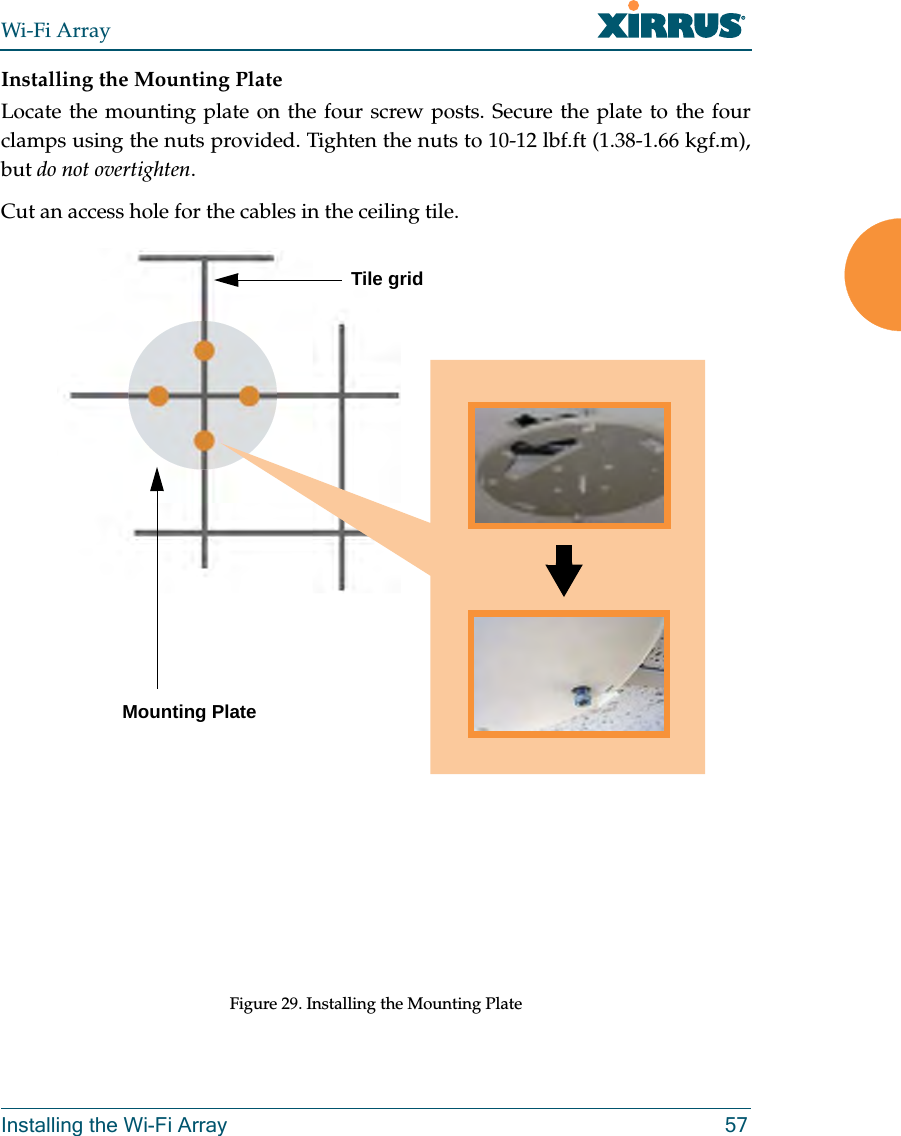

Wi-Fi ArrayInstalling the Wi-Fi Array 57Installing the Mounting PlateLocate the mounting plate on the four screw posts. Secure the plate to the four clamps using the nuts provided. Tighten the nuts to 10-12 lbf.ft (1.38-1.66 kgf.m), but do not overtighten. Cut an access hole for the cables in the ceiling tile. Figure 29. Installing the Mounting Plate Tile gridMounting Plate

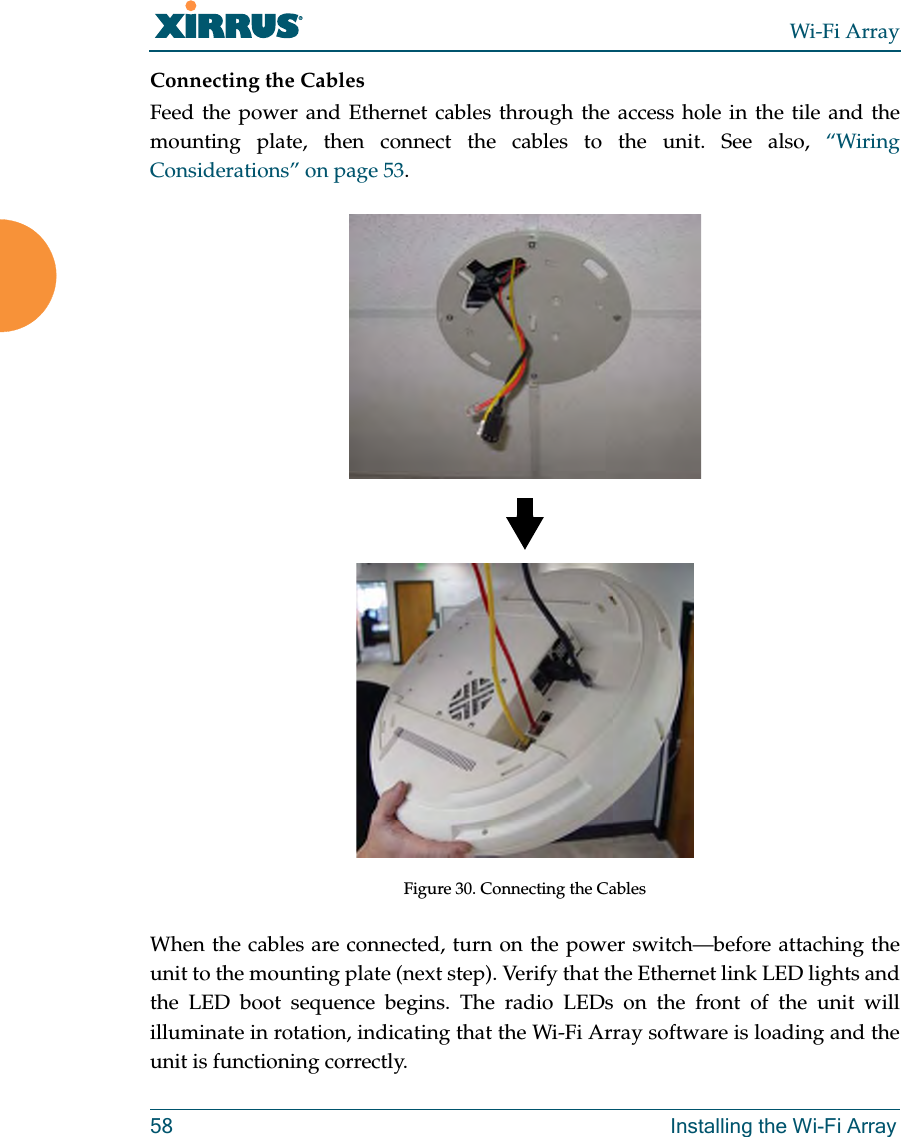

Wi-Fi Array58 Installing the Wi-Fi ArrayConnecting the CablesFeed the power and Ethernet cables through the access hole in the tile and the mounting plate, then connect the cables to the unit. See also, “Wiring Considerations” on page 53.Figure 30. Connecting the CablesWhen the cables are connected, turn on the power switch—before attaching the unit to the mounting plate (next step). Verify that the Ethernet link LED lights and the LED boot sequence begins. The radio LEDs on the front of the unit will illuminate in rotation, indicating that the Wi-Fi Array software is loading and the unit is functioning correctly.

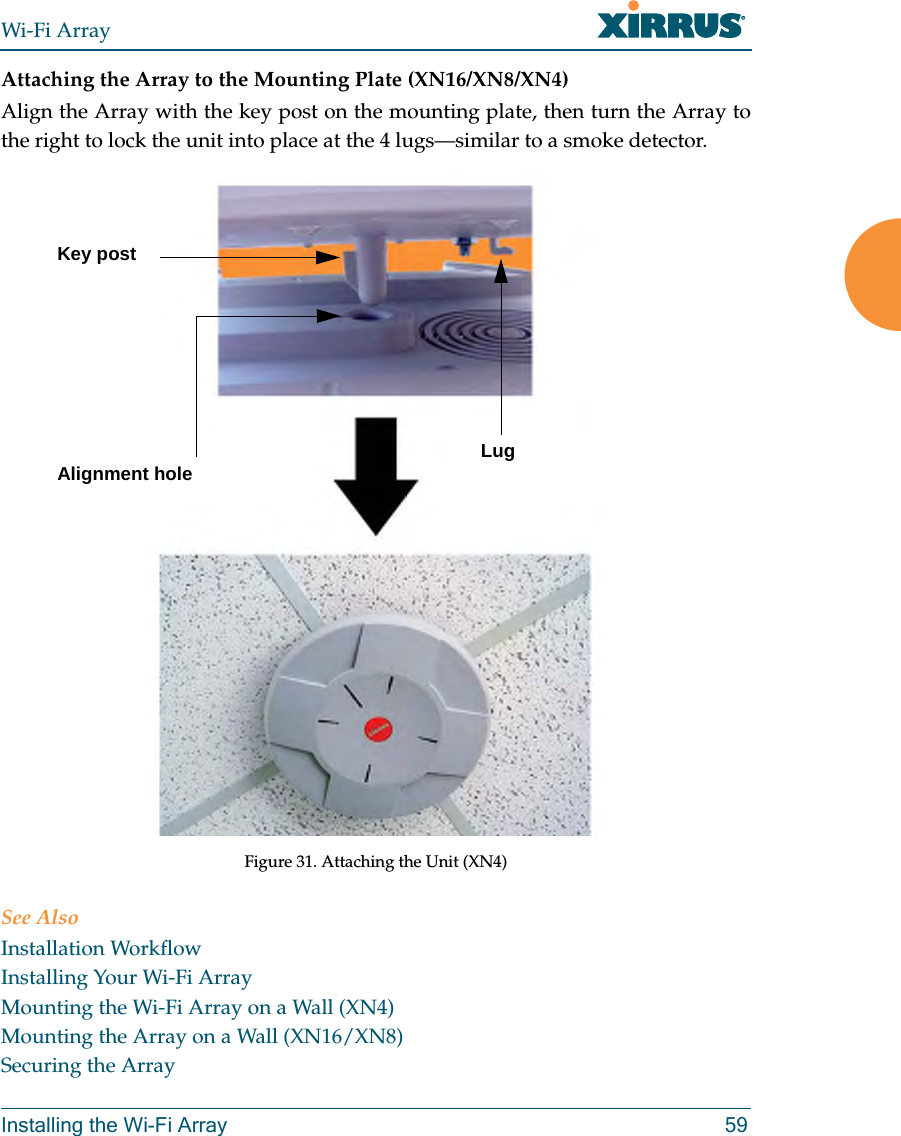

Wi-Fi ArrayInstalling the Wi-Fi Array 59Attaching the Array to the Mounting Plate (XN16/XN8/XN4)Align the Array with the key post on the mounting plate, then turn the Array to the right to lock the unit into place at the 4 lugs—similar to a smoke detector.Figure 31. Attaching the Unit (XN4)See AlsoInstallation WorkflowInstalling Your Wi-Fi ArrayMounting the Wi-Fi Array on a Wall (XN4)Mounting the Array on a Wall (XN16/XN8)Securing the ArrayKey postLugAlignment hole

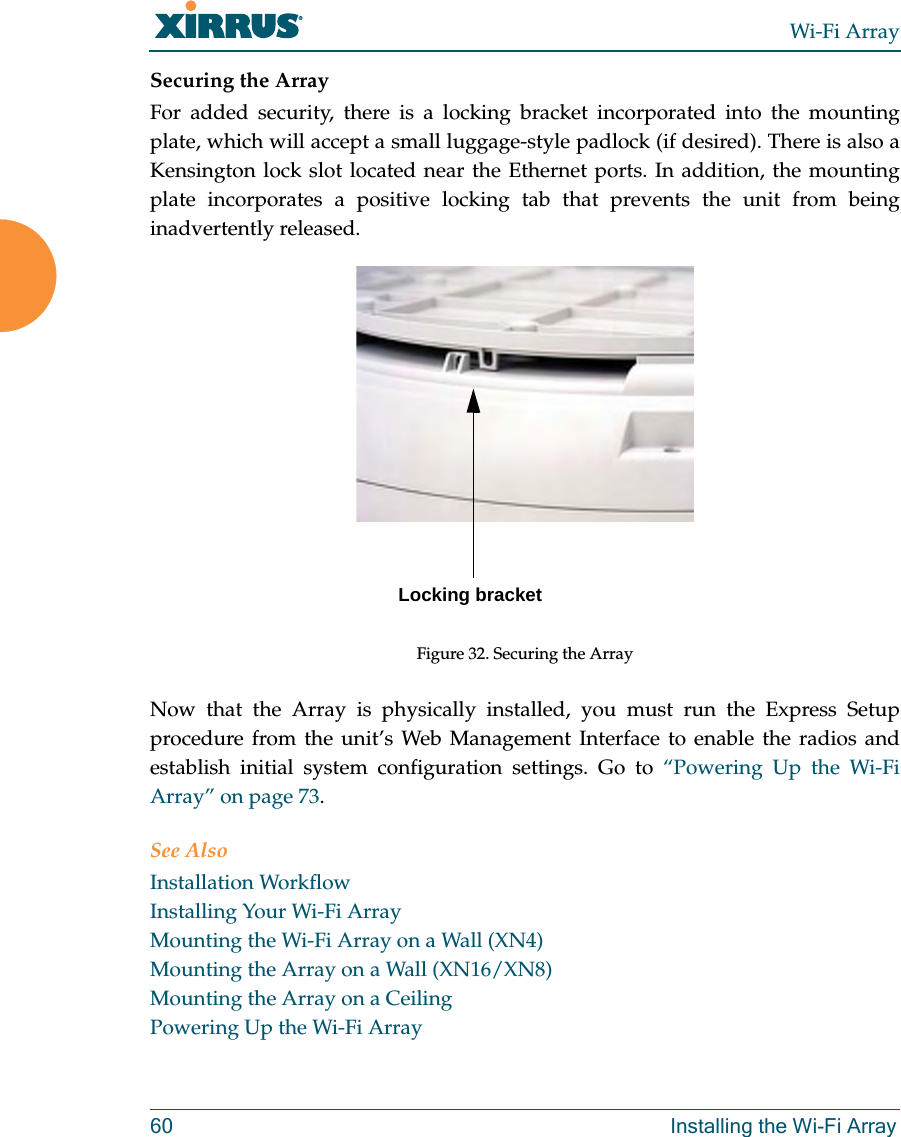

Wi-Fi Array60 Installing the Wi-Fi ArraySecuring the ArrayFor added security, there is a locking bracket incorporated into the mounting plate, which will accept a small luggage-style padlock (if desired). There is also a Kensington lock slot located near the Ethernet ports. In addition, the mounting plate incorporates a positive locking tab that prevents the unit from being inadvertently released. Figure 32. Securing the ArrayNow that the Array is physically installed, you must run the Express Setup procedure from the unit’s Web Management Interface to enable the radios and establish initial system configuration settings. Go to “Powering Up the Wi-Fi Array” on page 73.See AlsoInstallation WorkflowInstalling Your Wi-Fi ArrayMounting the Wi-Fi Array on a Wall (XN4)Mounting the Array on a Wall (XN16/XN8)Mounting the Array on a CeilingPowering Up the Wi-Fi ArrayLocking bracket

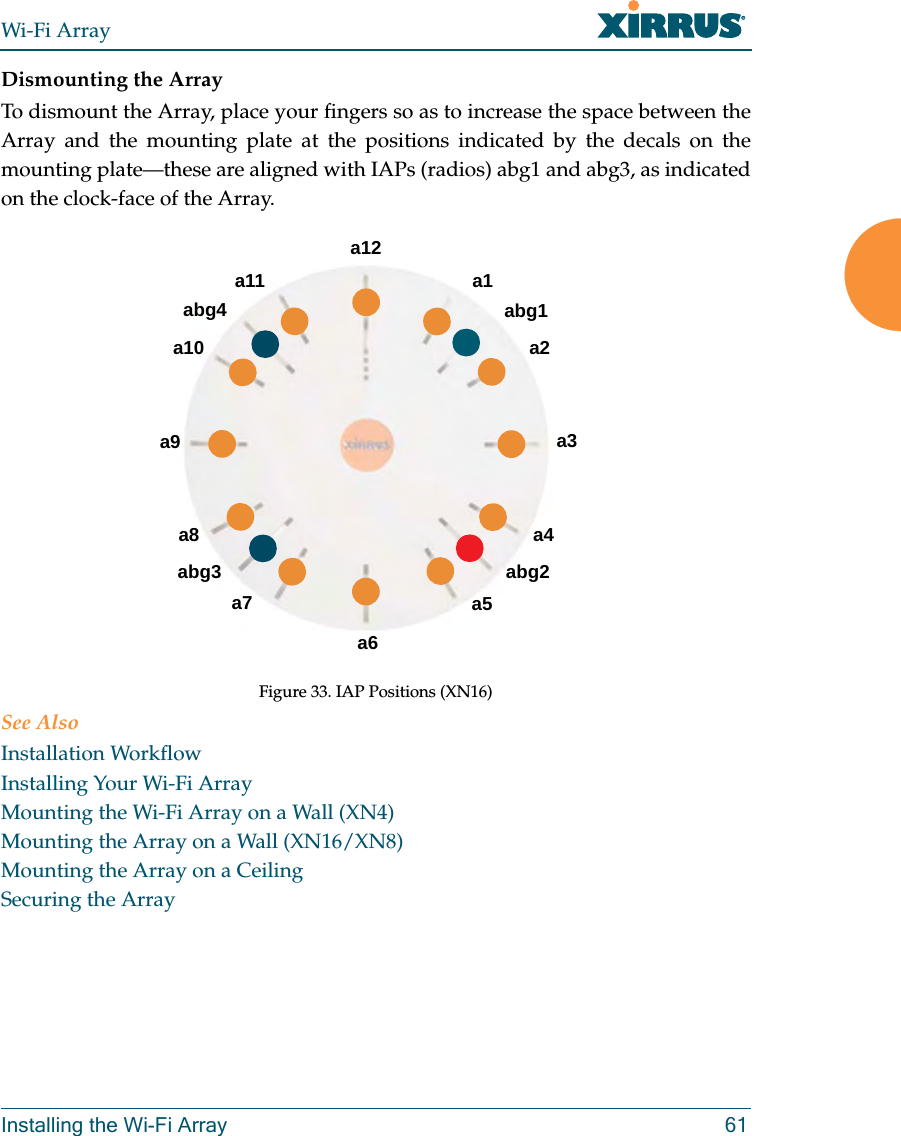

Wi-Fi ArrayInstalling the Wi-Fi Array 61Dismounting the ArrayTo dismount the Array, place your fingers so as to increase the space between the Array and the mounting plate at the positions indicated by the decals on the mounting plate—these are aligned with IAPs (radios) abg1 and abg3, as indicated on the clock-face of the Array.Figure 33. IAP Positions (XN16)See AlsoInstallation WorkflowInstalling Your Wi-Fi ArrayMounting the Wi-Fi Array on a Wall (XN4)Mounting the Array on a Wall (XN16/XN8)Mounting the Array on a CeilingSecuring the Arraya1abg1a2a3a4abg2a5a6a7abg3a8a9a10abg4a11a12

Wi-Fi Array62 Installing the Wi-Fi ArrayMounting the Array on a Wall (XN16/XN8)This procedure is applicable to the Wi-Fi Array’s 16-radio models (XN16) and 8-radio models (XN8). If you are mounting a 4 radio model, go to “Mounting the Wi-Fi Array on a Wall (XN4)” on page 67.The wall mounting assembly kit is used to mount the Wi-Fi Array (16-radio or 8-radio models) on a wall, instead of the traditional ceiling mount—if mounting the Array on the ceiling is impractical at your location.Kit Contents (Wall Mount Assembly - XN16 and XN8)The wall mount assembly kit includes the following items:z5 x SNAPTOGGLE™ toggle bolts (for attaching the wall bracket to the wall)z4 x 1/4 inch bolt assemblies (for attaching the mounting plate to the wall bracket)zWall Mounting BracketTools RequiredzPower drillz1/2 inch (13mm) drill bitzCross head screwdriverz1/4 inch nut wrenchzPencilzLevel

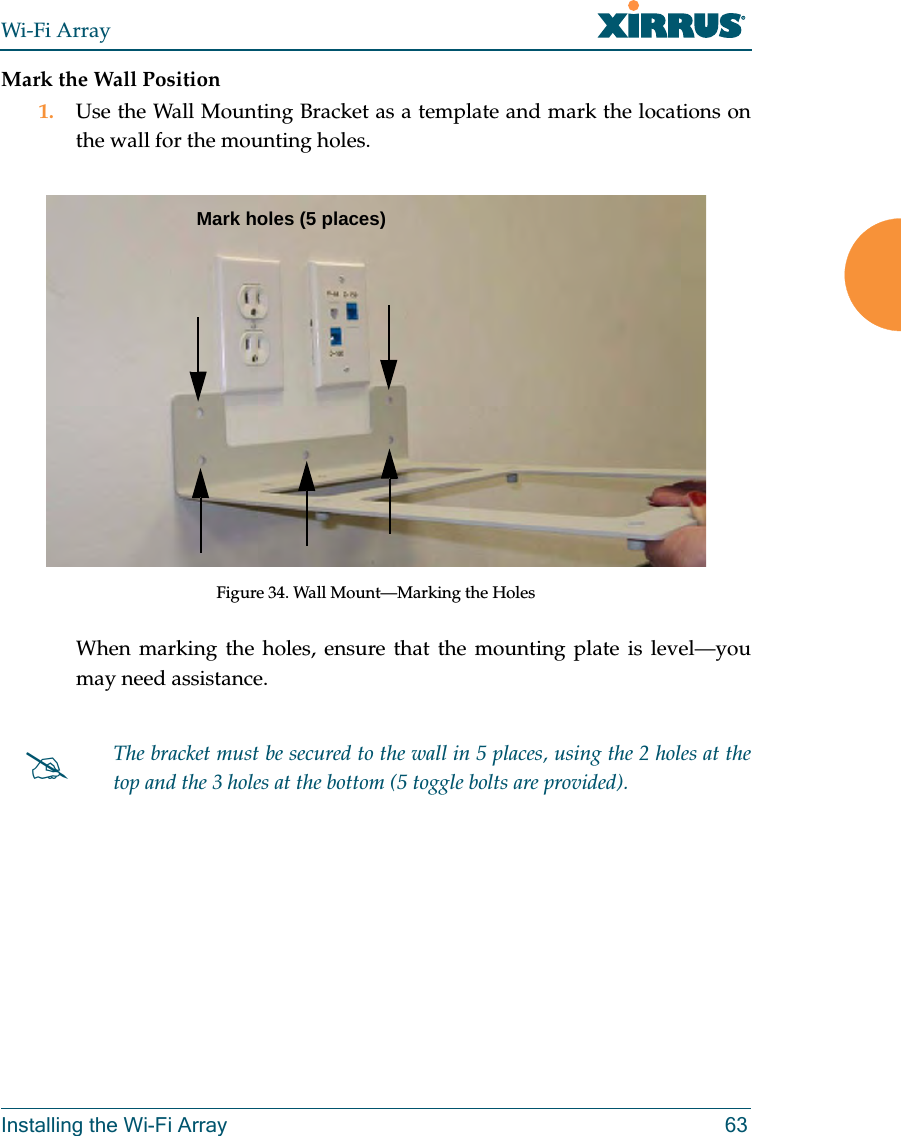

Wi-Fi ArrayInstalling the Wi-Fi Array 63Mark the Wall Position1. Use the Wall Mounting Bracket as a template and mark the locations on the wall for the mounting holes. Figure 34. Wall Mount—Marking the HolesWhen marking the holes, ensure that the mounting plate is level—you may need assistance.#The bracket must be secured to the wall in 5 places, using the 2 holes at the top and the 3 holes at the bottom (5 toggle bolts are provided).Mark holes (5 places)
